Bathroom Waterproofing Sheet: Installation Tips for 2026

You're standing in a newly tiled shower, grout still bright, screen still clear. Downstairs, a brown stain is already spreading across the ceiling. The tiles look perfect, so the leak feels impossible. That's the trap with waterproofing. The layer that stops water sits under the tiles, and once tiling starts, you can't see it again.

That's why this guide treats a bathroom waterproofing sheet as one part of a complete system. You'll learn where it goes, how the layers fit together, and what records to request before anyone covers the work. The product matters, but the joints, corners, substrate and paperwork decide whether it lasts.

Table of Contents

What a Bathroom Waterproofing Sheet Is and How It Differs

A shower can look beautifully finished and still leak into the room below. Water passes through grout, which is porous, and through tiny gaps at corners and penetrations. If there's no continuous barrier behind the finish, that water reaches framing, cabinetry and ceilings long before you notice anything wrong.

A bathroom waterproofing sheet is a flexible membrane bonded to the substrate under tiles, with joints and corners sealed using matching tape, corner pieces and adhesive. A liquid membrane does the same job differently. The installer brushes or rolls it on in coats, often embedding reinforcing fabric at corners while the coat is wet.

The visual below shows why the hidden layer matters more than the visible finish.

A comparison infographic showing how a bathroom waterproofing sheet provides a continuous barrier compared to failing tile layers.

Bathroom waterproofing sheet versus liquid membrane at a glance

Factor Waterproofing sheet Liquid membrane
Form Rolled sheet bonded to the substrate Liquid applied by brush or roller in coats
Joints and corners Joint tape and pre-formed corner pieces bonded with system adhesive Reinforcing fabric or tape embedded in the wet coat
Thickness control Set by the sheet and its bond Depends on number and rate of coats; verify against the product data
Curing before tiling Follow adhesive and sealant cure times Each coat must dry and the full system must cure per product data
Main installation risk Poorly bonded laps, corners and penetrations Uneven coverage and thin spots at corners and wastes
Typical choice Flat, sound substrates and large floor areas Complex shapes, niches and many small penetrations

Read the table as a starting point, not a verdict. Homeowners often ask which category is waterproof, and the honest answer is that either can be, and either can fail. A sheet that's well made in the factory still depends on site work at every lap and pipe.

Practical rule: Tiles and grout finish the surface. The membrane underneath stops the water.

Both systems fail for the same core reasons. The substrate moves or holds moisture, a corner isn't reinforced, a waste isn't sealed, or incompatible products are mixed. Judging a job by the roll or tin alone misses those risks. The useful question is whether the whole build-up, from substrate to tile adhesive, works as one tested system.

Where Sheet Membranes Go in a Bathroom

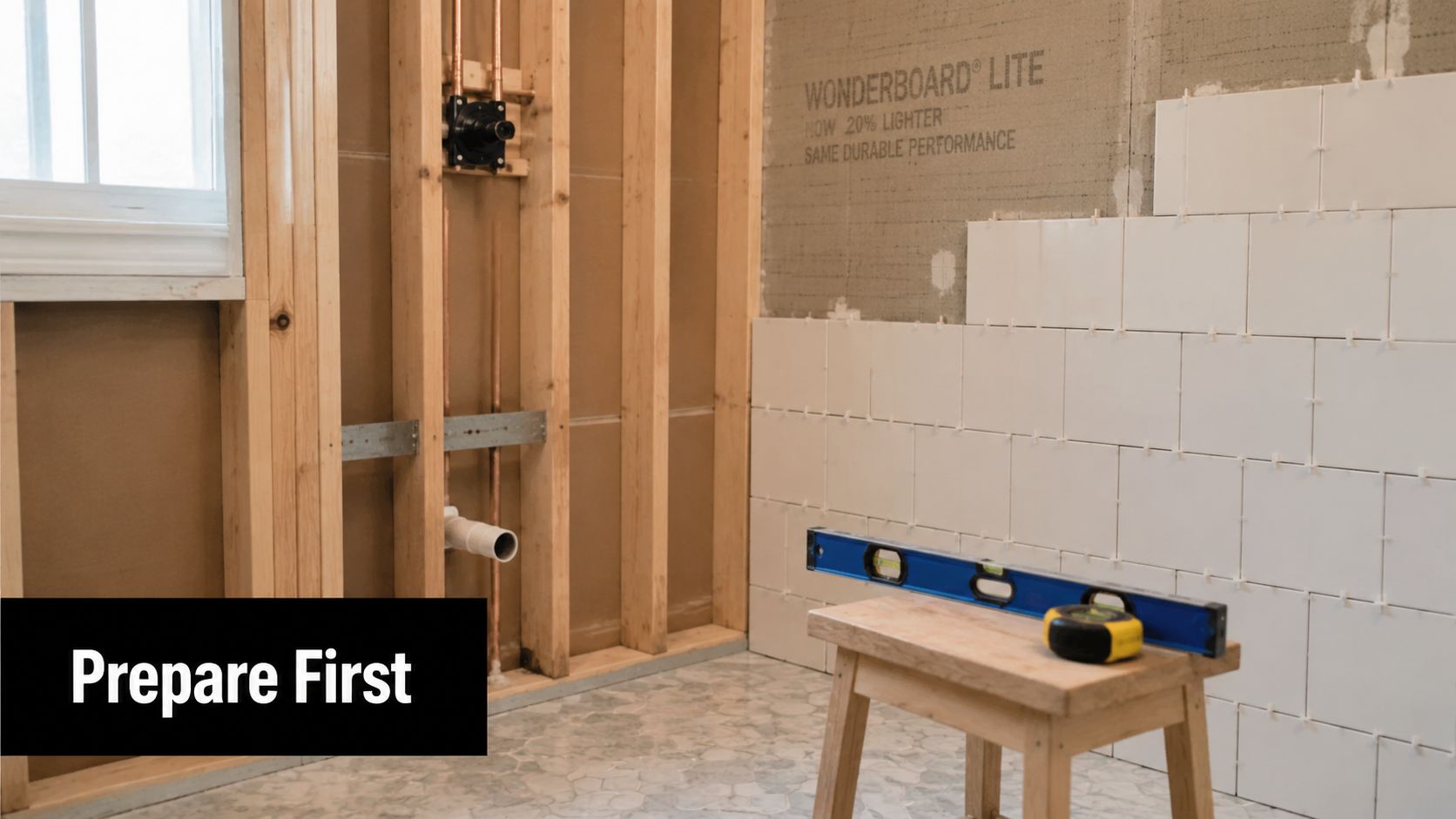

Start with the shower, because it's the highest-stakes zone. Water hits the floor and walls daily, under pressure and with heat, so the rules are strictest there. The NCC waterproofing guidance for houses states that the entire shower floor, including a hob or step-down, must be waterproof, and shower walls must be waterproof to at least 1,800 mm above the floor substrate. Wall junctions, wall-to-floor junctions and relevant joints inside the shower must also be waterproof.

That means the sheet can't stop neatly at the shower screen line if the floor and junctions continue beyond it. It runs across the full shower floor, turns up at the walls, and carries up the walls to the required height. Every change of direction gets tape or a corner piece, because corners move slightly and a flat sheet folded sharply can bridge or split.

Bathroom zones, NCC requirements and what the sheet must do

Bathroom area What the NCC requires What the sheet must do
Shower floor, including hob or step-down Must be waterproof Run the sheet across the full floor and up to the walls at the junction
Shower walls Waterproof to at least 1,800 mm above the floor substrate Carry the sheet to at least 1,800 mm with sealed joints
Wall-to-floor and wall junctions in the shower Must be waterproof Use joint tape and corner pieces at every junction
Timber-based bathroom floor Must be waterproof Give full sheet coverage with sealed joints
Tap and spout penetrations in horizontal surfaces Must be waterproofed around the penetration Seal the sheet tightly around each penetration

Outside the shower, the floor material changes the answer. A timber-based floor such as particleboard or plywood needs full waterproof coverage, so the sheet runs wall to wall with sealed joints. Concrete and compressed fibre-cement have been treated as water-resistant in parts of a bathroom under earlier provisions, which is why two similar bathrooms can legitimately have different sheet extents.

Penetrations deserve the same care as large areas. Where a tap or spout passes through a horizontal surface, the sheet must seal tightly around it rather than stop short and rely on surface silicone. A niche adds internal corners and a shelf that holds water, so follow the detailing in our guide to waterproofing a shower niche correctly before you finalise the layout.

If you're comparing approaches for the shower base itself, Trademaster Construction's shower liner guide is a useful plain-language resource on how a liner sits under a shower floor. Use it for concepts, not Australian compliance.

In a renovation, changing the shower layout, replacing the floor or adding new wall linings can bring these requirements into play even if the old bathroom had less coverage. Check the existing substrate and fixture positions first. Then decide where the sheet goes, rather than copying whatever the previous tiles hid.

Why Installation Quality Decides Whether the Sheet Works

Waterproofing failures aren't rare, and they're rarely caused by a sheet wearing out in the middle of a floor. Independent defect research cited in Australian reporting on waterproofing standards covering Queensland, New South Wales and Victoria ranked waterproofing as the third most common defect category, at 11.46 percent of all recorded problems. The reported issues were membrane failures, defective membrane installation, and inadequate falls to shower areas.

Separate NSW strata research cited in that reporting found serious waterproofing defects in 42 percent of surveyed Class 2 apartment buildings. Read that figure carefully. It describes surveyed apartment buildings, not every Australian house or bathroom, so it doesn't predict your renovation. It does show how often concealed work goes wrong when detailing and inspection are weak.

The three failures that stay hidden

  • Membrane failure: The material breaks down, debonds or was never compatible with the primer and adhesive under it.
  • Defective installation: Laps lift, corners aren't reinforced, or a penetration is cut too loosely and sealed with hope.
  • Inadequate falls: Water ponds instead of draining, so it sits against grout and junctions for hours after each shower.

All three can stay concealed beneath tiles until damage appears elsewhere. You might see a ceiling stain below, mould that keeps returning, swollen vanity panels, or paint bubbling on the other side of a shower wall. By then, the original membrane is buried and the argument about what was installed becomes hard to settle.

Good substrate preparation before waterproofing prevents many of these outcomes, because a sound, clean, correctly sloped base gives the sheet a chance to bond and drain. A premium sheet doesn't rescue a damp screed, a dusty wall or a floor that falls away from the waste.

The material category predicts less than verified system compatibility and workmanship.

For a homeowner, the practical consequence is timing. The evidence exists for a short window between membrane installation and tiling. After that, proving quality depends on photographs, product records and signed documentation captured while the work was visible.

When a Sheet Suits Your Bathroom Better Than Liquid

Don't start with a brand ranking. Start with the substrate in front of you. Ask whether it's flat, sound, dry and stable, and how many corners and pipes interrupt it. Those answers usually point to the easier system to install well.

A sheet tends to suit large, flat floor areas where the installer can lay full widths with few cuts. Its thickness is set during manufacture, so you don't rely on coat build to reach the right film thickness. It also suits projects where the installer regularly uses that specific sheet system and knows its tape, corners and adhesive.

A liquid membrane may be easier where the room fights a roll. Tight ensuites, curved or irregular niches, clusters of small penetrations and awkward steps can be brushed around more readily than they're cut and folded. The trade-off is discipline. The installer must achieve even coverage, reinforce corners and let each coat cure.

Five questions that decide the choice

  • Substrate condition: Is it flat, sound and dry, or patched, moving and moisture-affected?
  • Shape complexity: Are there niches, benches, steps or tight corners that need many cuts?
  • Number of penetrations: How many pipes, wastes and fixings pass through the membrane?
  • Installer experience: Has the installer completed this exact system before, not just a similar one?
  • Documentation available: Can you get product evidence, method details and installation photos?

Old substrates make generic advice unreliable. A renovated bathroom might combine original framing, new sheeting, a patched screed and moved plumbing. Movement at those junctions matters more than whether the membrane arrived as a roll or a liquid.

Either choice must meet the same compliance pathway for the wet area. If two quotes propose different systems, compare their detailing, preparation and records line by line. The installer who can explain corners, wastes and curing clearly is usually a safer bet than the one who only names a product.

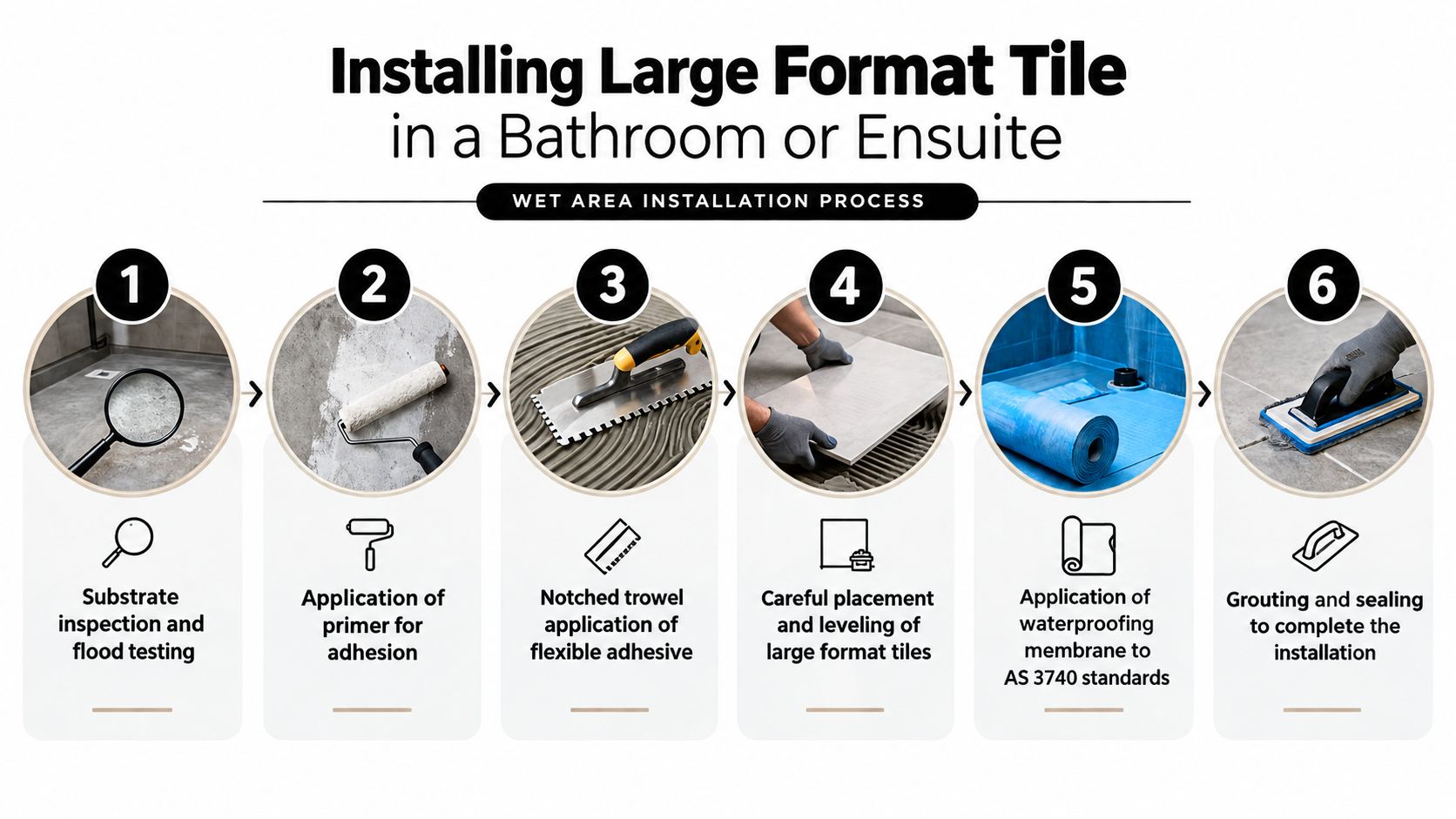

How the Sheet System Works and How to Install It

Think of a raincoat. The fabric can be waterproof, yet water still enters through seams, zips and hems if they're not sealed. A sheet membrane works the same way. The flat field of the sheet is the easy part, and the laps, corners and penetrations decide whether the system holds.

The diagram below builds the system from the bottom up, in the order water would try to pass through it.

A diagram illustrating the step-by-step installation process of a bathroom sheet waterproofing system on a floor.

From the bottom, you need a sound, flat, dry substrate, then the specified primer and adhesive, the sheet, joint tape and corner pieces, and sealants at wastes and perimeters. Tile and grout sit on top as the finish, not the waterproofing. The NCC Housing Provisions Part 10.2 recognises flexible waterproof sheet flooring material only when it has waterproof joints, and Victorian guidance requires wet-area membranes to demonstrate compliance with AS/NZS 4858:2004. Follow one consistent pathway, AS 3740 or the Housing Provisions, rather than mixing details.

Moisture control comes before any bonding. The Victorian Building and Plumbing Commission waterproofing guidance warns that excessive residual moisture can prevent a membrane from fully curing or cause premature failure. That warning applies in spirit to the whole build-up, because trapped moisture weakens bonds and can blister coatings and adhesives.

Watch the installation sequence in the video, then use the steps below to check what your installer is doing and why.

Installation in eight steps

  1. Confirm the substrate is sound, flat and dry. Take moisture readings on screeds and patched walls before primer goes on, because trapped moisture undermines curing and bond. The common slip is trusting a surface that feels dry.
  2. Repair and prime. Fill cracks, remove loose material, vacuum dust, then apply the primer specified for that sheet and substrate. A generic primer can look fine and still be incompatible.
  3. Check falls and drainage. Run water or use a level to confirm the floor falls to the waste without ponding. Sealing a floor that holds water locks in a defect.
  4. Set corners and junction tape first. Fit pre-formed internal corner pieces and joint tape at wall-to-floor junctions before the main sheet, so movement points are reinforced, not bridged.
  5. Seal wastes and penetrations. Dress the sheet into the puddle flange, seal around grates and pipes, and use the specified sealant and bond breakers. The wrong sealant at a waste can attack the membrane or lose adhesion.
  6. Lay and bond the sheet. Set out full sheets to minimise joints, use the specified overlaps, spread compatible adhesive evenly and roll out air pockets from the centre outward.
  7. Inspect before tiling. Check every lap, corner and penetration by hand and eye, and test where the system and project require it. Fix lifted edges now, not after tiles are on.
  8. Record the work. Photograph coverage, corners and penetrations, and note the system name, batch and installer before linings or tiles hide everything.

The same sequence needs extra care below ground, where external moisture adds pressure from the other side. Northpoint Construction's overview of waterproofing a basement bathroom shows why drainage and detailing matter even more in those settings, although Australian projects still need the local pathway.

Installer check: If you can't see sealed corners and penetrations in the photos, you don't have evidence they were sealed.

Rushing usually shows up as skipped moisture checks, mixed primers, unrolled laps and tiling before adhesives cure. None of those shortcuts saves much time. Each one removes a layer of protection you'll never be able to inspect again.

Records, Compliance and Builders Before Tiling

Ask one question before tiling starts. If this shower leaks in three years, what evidence will show the work was compliant? If the answer is only a verbal assurance, you're relying on memory after the proof has been covered.

In Victoria, the framework is specific. Victorian building standards guidance explains that NCC requirements operate through the Building Act 1993, Building Regulations 2018 and Plumbing Regulations 2018, with the appointed building surveyor responsible for assessing building-permit compliance. Waterproofing must follow the applicable NCC Deemed-to-Satisfy provisions, AS 3740 or an approved Performance Solution, and shower floors, adjacent wet areas and related penetrations are compliance-sensitive work.

That framework has a history worth knowing when old advice conflicts with current practice. The NCC structure changed over time, with details moving between the code and AS 3740, so your documentation should name the applicable NCC edition and the exact pathway used. Don't accept a note that just says waterproofed to Australian Standards. Ask which standard, which edition and which system.

Recent Victorian regulatory-impact proposals for stronger notification at waterproofing and pre-lining stages reflect the same concern you should have as an owner. Once linings and tiles go in, defects are hidden. Your record set is the practical way to keep the work visible on paper.

Our summary of bathroom waterproofing standards in Australia helps you match those records to the relevant requirements before you sign a contract.

Records to request before tiling

Record What it proves
Product name and AS/NZS 4858 evidence Sheet is a wet-area membrane that meets the standard
Substrate moisture check results Substrate was dry enough for the membrane to cure
Installation photographs Joints, corners and penetrations were built as specified
Membrane coverage details Full sheet coverage was achieved across the wet area
Signed installer records Named installer accepts responsibility for the work
Building permit or inspection status Whether a permit or inspection applies and was booked

Use the table as a pre-tiling gate. Tiling shouldn't proceed until the system evidence is on file, moisture was checked, joints and penetrations were inspected, photographs exist, and any required permit or inspection is booked. If one item is missing, pause while the membrane is still exposed. A one-day delay is cheaper than removing tiles to investigate a leak.

Who does what on a compliant project

Registered builders coordinate the trades and sequence, but coordination isn't the same as certification. The Australian Building Codes Board guidance on building practitioners identifies registered building certifiers as the appropriate source for advice about individual buildings or sites, while the NCC provides the technical wet-area rules. A registered builder coordinating plumbers, electricians, carpenters and waterproofers can help manage bathroom renovations, but registration doesn't remove the need for compliant design, installation and certification where required.

Check three things in writing before work starts. Confirm the builder's registration status, clarify whether a building permit or inspection applies to your scope, and ask who signs the waterproofing records. Those answers should be in the quote and contract, not discovered after demolition.

With us, all of our workers are qualified and certified waterproofers or tilers, so the person installing the membrane and the person tiling over it work to the same system and record set. That continuity matters because tile adhesive, grout and movement joints must suit the membrane underneath.

Ask for a written quote that scopes the complete waterproofing system, not just a line for waterproofing. It should name preparation, primer, sheet or membrane system, junction detailing, the records you'll receive and the warranty terms. Our waterproofing work comes with extended warranties, and you should confirm any provider's warranty in writing, including what it covers and what maintenance it assumes, before work starts.

For bathroom renovations, we offer free quotes and 3D drawings, which lets you agree the layout, shower position, niche and waste locations before waterproofing is detailed around them. Moving a waste after the sheet is laid creates penetrations and patching you'd rather design out at the drawing stage.

Property managers and landlords should keep the same file for each property. When a tenant reports a stain or a leaking shower, product evidence, dated photographs and signed records help a rectification team locate the likely failure point quickly. Without them, diagnosis often means opening finished surfaces just to learn what was installed.


If you're planning bathroom renovations in Melbourne and want the waterproofing sheet system, tiling and records handled in one coordinated scope, talk to Melbourne Tiling Services P/L for a free quote and 3D drawings before you commit to a layout. We'll help you confirm the system, detailing and pre-tiling evidence for your bathroom, and our waterproofing work comes with extended warranties.

How to Install Porcelain Tile: A Melbourne Bathroom Guide

A perfect-looking porcelain floor can still be a leaking bathroom. Porcelain's dense, low-absorption body stops water soaking through the tile itself, but it doesn't waterproof the joints, penetrations, waste connection or wall junctions underneath. That's the counterintuitive starting point for learning how to install porcelain tile in a Melbourne wet area. The finish you see is only the last layer, and every earlier layer has to be signed off before you cover it.

Table of Contents

The Porcelain Tile Installation Sequence at a Glance

Get the order wrong and the only remedy is demolition. The sequence is substrate, waterproofing, falls, adhesive, laying, movement joints, grout, then sealer, and every stage gates the next. Few installers skip a step deliberately. They work around one they cannot prove, which is why every row below carries its own check.

Stage Must be true before moving on How to check
1. Substrate prepared Flat within about 3 mm under a 2 m straightedge, dry and sound Straightedge and moisture test
2. Waterproofing applied Membrane, collars, bond breakers and reinforcing complete and cured Photograph concealed work and record curing time
3. Falls checked Consistent fall to the floor waste as the waterproofing system specifies Spirit level and water test before tiling
4. Adhesive selected Suited to porcelain's low water absorption and the substrate Adhesive data sheet against the tile specification
5. Tiles bedded Near-continuous adhesive support across the tile back, no voids Lift test on sample tiles
6. Movement joints set Joints continue through tile and bedding, with flexible sealant planned Layout drawing marked before adhesive goes down
7. Grout and sealer applied Grout cured, matching colour, corner joints sealed Manufacturer cure times and sealer data sheet

In Australia, porcelain work follows the Australian Standard for ceramic and stone tile installation, while wet-area waterproofing must also comply with the National Construction Code and AS 3740. The NCC Housing Provisions for wet area waterproofing require the membrane in a hobless shower, or a shower with a hob or stepdown, to extend over the floor and up the vertical wall substrate to at least 1,800 millimetres above the finished tile level, and they permit that membrane above or below the tile bed or screed provided the complete system meets the performance requirements.

Why the sequence matters

Tile height doesn't replace that membrane. A wall tiled to the ceiling over a membrane that stops short, misses a collar or bridges a corner will still leak, and the failure stays hidden until moisture appears in the next room.

Porcelain is a finish, not a waterproofing system. Treat the membrane as structure and the tile as the wear surface over it.

The step DIYers skip is the pause between waterproofing and tiling. The membrane looks painted on, so the adhesive goes down the same afternoon. I'd stop there and treat the sign-off as its own milestone. Confirm falls, penetrations, corners and junctions, photograph the concealed work with a tape measure in frame, record primer and membrane curing times, and note collar and puddle flange checks on a dated sheet. Adhesive over an unproven membrane is a gamble with the dearest part of the job, the strip-out.

Tick each row before you open the next bag of adhesive. Once porcelain covers the floor, your photos and records are the only evidence of what sits underneath.

Large-Format Porcelain Flatness, Warpage and Handling

A careful installer can still produce an uneven large-format floor. That isn't always poor workmanship, and understanding why saves arguments later.

Check flatness physically before you judge any finished surface, as this checking work shows.

A professional flooring contractor using a long spirit level to check the flatness of newly installed tiles.

Long tile edges bridge substrate dips instead of following them. A small hollow that a mosaic would absorb becomes a raised corner, a shadow line under downlights, and a toe-catching lip on a 600 mm-plus tile. Lippage is that height difference between adjacent edges.

Clips don't flatten floors

A levelling-clip system pulls neighbouring edges closer together. It doesn't correct a bowed screed, remove deflection in a sheet floor, or straighten a warped tile. Tightening clips over a dip can even lift a tile off its bed and create a void. Australian Laticrete technical guidance for large porcelain panels identifies strict substrate flatness requirements, a stable substrate with limited deflection, and high mortar coverage for large porcelain panels, particularly in wet and exterior areas.

Decide before you buy, not on laying day:

  • Measure first: Run a straightedge in several directions and mark highs and lows on the floor.
  • Budget for correction: Allow for grinding, patching, screeding or self-levelling compound if the base needs it.
  • Confirm the system: Match adhesive, primer and trowel size to the tile back and substrate.
  • Plan the handling: Work out entry paths, cutting space, suction lifters and a second pair of hands.

Tile-over-anything methods stop looking cheap at this stage. A 600 mm-plus format requires more preparation, slower placement, heavier adhesive use, and a higher breakage allowance. Our large-format tile installation approach reflects that extra preparation, because the tile price is only part of the installed cost.

Watch the bedding and alignment sequence before you attempt a large panel on your own.

Telling warpage from installation error

Carry large tiles on edge, use two people for long pieces, and inspect every carton for chips and bow before adhesive is mixed. To check warpage, lay a tile face up on a known flat surface and look for rocking or a raised centre, then place two tiles face to face. If both bow the same way, that's inherent warpage. If flat tiles sit unevenly only in one part of the room, suspect the substrate or bedding.

Agree in writing, before the first tile is set, how you'll assess inherent bow and acceptable lippage, including offset patterns that place a tile centre beside another tile's edge. A 50 per cent brick offset is the worst layout for a bowed tile. A one-third offset usually reduces the visible peak.

Pre-Tiling Waterproofing Sign-Off

Don't let waterproofing become a preliminary step you rush to get past. Sign it off as its own milestone, with a named person, a date and photos, before any tile is set.

  1. Match the system to the specification: Confirm the membrane, primer, reinforcing and bond breakers installed are the products in the approved specification, and check them against the product data sheet for your bathroom plan.
  2. Check membrane extent: Verify coverage over the floor and up the shower walls to the required height for hobless showers and showers with a hob or stepdown, measured from finished tile level, not from the raw screed.
  3. Inspect the waste: Confirm floor waste collars and puddle flanges are clean, the membrane laps the flange correctly, and there's no trapped air, bridging or lifted edge.
  4. Check penetrations and junctions: Every pipe, valve and fixing penetration needs a sealed collar. Bond breakers should sit at wall-to-wall, wall-to-floor and hob-to-wall junctions so movement doesn't tear the membrane.
  5. Water test the falls: Flood or hose the shower floor lightly and watch the water. It should move consistently to the waste with no ponding away from the drain.
  6. Confirm curing: Record when primer and each membrane coat were applied and confirm the required curing time has elapsed before tiling or flood testing.
  7. Photograph everything: Take dated photos with a scale reference of corners, penetrations, the flange, membrane terminations and the full floor before tile covers them.

Practical rule: If you can't prove a junction was detailed correctly from your photos, assume you'll have to argue about it later.

File the completed checklist with the product data sheets and warranty documents. For a Victorian project, keep the paperwork described in our guide to a waterproofing compliance certificate in Victoria with those records, rather than relying on a verbal assurance that the room was done properly.

Compatibility matters too. Confirm the tile adhesive is approved over that membrane and substrate. A membrane can pass its own inspection and still fail as a system if the adhesive, primer or screed layer isn't compatible with it.

Movement Joints and Waterproofing Details to Get Right

Rigid grout in a corner looks neat for about one season. Then the building moves, the grout cracks, and the owner blames the tile.

Location Spacing rule Joint width
Internal floor where any dimension exceeds 9 m Joints needed, spacing no greater than 4.5 m At least 6 mm
Internal floor in direct sunlight with a dimension over 6 m Spacing 4.5 m At least 6 mm
External tiled floor in any dimension Spacing 4.5 m At least 6 mm
Internal shower corners Joint required at each corner At least 6 mm (generally)
Changes between materials and floor perimeters Joint required At least 6 mm (generally)

Housing industry guidance interpreting AS 3958:2023 on tile layout states internal floors require movement joints when any dimension exceeds 9 metres with spacing no greater than 4.5 metres, internal floors affected by direct sunlight need 4.5-metre spacing where a dimension exceeds 6 metres, and external tiled floors require joints at 4.5-metre spacing in any dimension. Those joints are generally at least 6 millimetres wide, continue through tile and bedding, and shouldn't be filled with rigid cement grout.

Why porcelain needs room to move

Substrates and buildings expand, contract and deflect with temperature, moisture and structural load. Porcelain and cementitious bedding don't accommodate that movement at the same rate. Without a soft joint to absorb strain, stress concentrates at the weakest point, which is usually a grout line, a tile edge or the adhesive bond.

That reasoning tells you where joints belong even in an odd-shaped room:

  • Over structural joints: Never bridge them. Bring the joint straight through the tile layer.
  • At material changes: Timber to concrete, sheet to screed, and old slab to new extension all move differently.
  • Around fixed elements: Columns, door frames, island benches and bath hobs restrain the field.
  • At perimeters and corners: Walls restrain floors, and internal shower corners combine movement with water exposure.

Form the gap through the tile and bedding, insert suitable backing material where the system requires it, and finish with flexible sealant. Backing material controls sealant depth and stops three-sided adhesion, which would stop the sealant flexing properly.

Bond breakers under the tile

Bond breakers sit at wall-to-wall, wall-to-floor and hob-to-wall junctions, and at movement joints where a bonded membrane meets the substrate. They let the membrane system accommodate local movement at the junction instead of being locked rigidly across it. Missing bond breakers are hidden once tiled, which is why your sign-off photos matter.

Before adhesive goes down, draw every joint on the layout plan and run your finger along each planned line. Mark any uninterrupted run longer than 4.5 m and resolve it on paper. Confirm those planning figures against the specific standard, substrate, sunlight exposure and manufacturer system for your job, because a sunny balcony, a heated bathroom floor and a shaded ensuite don't impose identical strain.

How to Lay Porcelain Tile Step by Step

Work slowly enough to check your bedding while it's still wet. Speed is useless if the tile you placed an hour ago is sitting on ridges and air.

A step-by-step infographic illustrating the professional process for installing porcelain tiles on a floor surface.

  1. Check the substrate. Run a 2 m straightedge across the slab, screed or sheet in several directions. Published Australian guidance on tile floor coverings says to correct deviations exceeding approximately 3 mm under that straightedge. Grind high spots and fill or level low spots with a compatible compound. The common slip is trying to pack out a dip with extra tile adhesive, which slumps, shrinks unevenly and leaves a hollow edge.

  2. Clean back to a sound surface. Mechanically remove dust, laitance, paint, curing compounds and weak material. Vacuum, don't just sweep, because fine dust breaks the bond. Confirm the surface is structurally sound, dry, stable and compatible with the specified primer and adhesive. Primer isn't a cure for a crumbling screed.

  3. Dry lay and set out. Mark centre lines, check perimeter cuts, and confirm movement joint locations before mixing. In a shower, plan cuts so floor tiles follow the fall to the waste without tiny slivers at the drain. I would dry lay the first rows with spacers in place, because a layout error is free to fix at this point and expensive an hour later.

  4. Key in, then comb. Spread a thin coat with the flat side of the trowel, pressing adhesive into the substrate or membrane. Then comb the bed with a notched trowel sized to the tile, holding consistent ridges in one direction. One-direction ridges let air escape when you slide the tile. Swirled adhesive traps it.

  5. Back-butter large-format tiles. Flat-trowel a thin, continuous coat onto the tile back, filling any mesh, texture or shallow profile. Place the tile and slide it perpendicular to the comb lines so ridges collapse into each other. Skipping back-buttering is the fastest route to edge voids on a big tile, even when the floor bed looks generous.

  6. Set, space and check level. Press the tile firmly, fit spacers, and run the straightedge across neighbouring tiles, not just a small spirit level on one tile. Clean adhesive from joints as you go. Work in small areas you can cover before the adhesive skins over, and scrape up and discard adhesive that has skinned. Pressing a tile into skinned adhesive gives contact without proper transfer.

  7. Lift and verify coverage. Every few rows, and whenever you change mix, trowel or substrate area, lift a freshly placed tile. Wet-area floors and shower zones should show near-continuous support at 95 to 100 per cent coverage with no edge voids. Squeeze-out around the perimeter doesn't prove the centre is supported. If you see clean stripes on the tile back, increase transfer by back-buttering more thoroughly, using fresh adhesive, checking trowel size and improving your sliding action.

  8. Cut accurately and safely. Use a quality manual cutter for suitable straight cuts and a wet saw with a diamond blade for dense porcelain, dense edge work and shower floor cuts. Support the tile fully, mark clearly, feed slowly and wear eye and hearing protection. Cut shower floor pieces to match the fall, checking each piece against the waste height instead of forcing one large tile to bend across competing planes.

  9. Leave the bed alone to cure. Keep foot traffic off fresh work and follow the adhesive manufacturer's cure time before grouting. Walking on tiles early can break the developing bond without visibly moving the tile.

A sound lifted tile shows full adhesive transfer across the back, corners included. A sound finished tile gives a solid note when tapped, not a hollow drum.

Porcelain's density makes it unforgiving of shortcuts. You need a polymer-modified adhesive specified for porcelain and your substrate, clean mixing water, the right open time for the day's conditions, and enough adhesive to support the whole tile. If a lifted tile keeps showing voids after you correct technique and trowel size, stop and reassess the flatness of the base rather than pressing harder.

Grouting, Sealing and Fixing Common Faults

Grout last, seal after cure, and keep rigid material out of joints designed to move. That order sounds obvious, yet most cosmetic repairs I would investigate start with someone treating grout and sealant as interchangeable.

Grout and sealer order

Wait until the adhesive has cured, remove spacers and loose adhesive, then pack joints fully with grout matched in colour across walls and floors. Work diagonally across joints with a rubber float, tool the surface, and clean with a damp sponge without flooding fresh joints. Too much wash water weakens and lightens cement grout.

Once grout has cured to the manufacturer's timing, seal corner and movement joints with flexible sealant and apply penetrating sealer over tiles and grout where the specified system requires it. Our bathroom work uses matching colour grout on walls and floors, sealed corner joints, and penetrative sealer over tiles and grout. If you're weighing joint materials, compare epoxy grout versus cement grout on curing, cleaning and movement limits before you buy, not after the bags are open.

The NCC waterproofing frequently asked questions for houses confirm the National Construction Code permits AS 3740 as a deemed-to-satisfy pathway for residential wet areas when applicable Housing Provisions are also met, with AS 3740:2021 covering materials, junctions, penetrations and shower detailing. That matters during repairs because replacing surface grout doesn't restore a failed junction underneath.

Symptom Likely cause Fix
Hollow or drummy tile when tapped Low adhesive coverage or no back-buttering Lift, re-bed with full coverage and back-butter large tiles
Lippage between adjacent tiles Substrate dips beyond about 3 mm Level the substrate before re-setting
Cracked grout at a corner or junction Rigid grout across a movement joint Cut out the grout and install flexible sealant in the joint
Tiles lifting or debonding Adhesive skinned over or unlevel substrate Remove, clean the back, re-bed with fresh adhesive
Damp patch at a wall-floor junction Incomplete membrane, bond breaker or drain detail Stop and have the waterproofing checked before any repair

Diagnose bedding before grout. Tap systematically, mark hollow tiles with tape, and check whether cracks follow one tile, one joint line or a structural line through several tiles. A single drummy tile usually points to local coverage. A repeating crack points to movement.

If the fault sits at a wet-area junction, floor waste or wall-to-floor corner, stop before cosmetic repair. Correct-looking tiles over incomplete waterproofing, blocked falls, unsealed penetrations or rigidly grouted corners are a recognised failure pathway, and fresh sealant over the top can trap moisture while hiding the evidence.

Confirm Your Builder and Permits Before You Start

Calling a full bathroom rebuild “tiling” doesn't change what it legally is. Separate single-trade tile replacement from coordinated bathroom renovations before demolition, purchasing or signing anything.

Registration checks in order

  1. Search the register: Use the Building and Plumbing Commission practitioner search to check the builder's name, registration class, permitted work and any conditions or limits. Do this before appointment, not after a deposit.
  2. Define the full scope: Demolition, carpentry, waterproofing, plastering, plumbing coordination and tiling together amount to a wider renovation, even if porcelain is the visible finish.
  3. Apply the contract threshold: Consumer Affairs Victoria guidance on becoming a registered building practitioner states a person does not generally need domestic-builder registration for work involving only wall or floor tiling, but registration is required for domestic building work where the contract exceeds $10,000, subject to stated exemptions. A major domestic building contract must be used for work worth more than $10,000, and the builder must be registered with the Building and Plumbing Commission.
  4. Check permits separately: Like-for-like replacement of internal wall cladding without structural alteration may not need a building permit. Moving walls, changing structural elements or altering services can change that position, so ask your local council or a registered building surveyor before work starts.

For bathroom renovations, use registered builders whose registration covers coordinating the actual scope, and confirm which licensed practitioners will handle plumbing, electrical and waterproofing components. Registration for the coordinating builder doesn't automatically answer every specialist licence question.

Ask for a written scope naming demolition, substrate preparation, waterproofing, screeding, tiling, grouting, sealing and shower screen work as applicable. Request membrane product data, waterproofing records, curing documentation, progress photos and warranty terms in the contract documents.

Melbourne Tiling Services P/L has been an established tiling business since 2003, and all of the business's workers are qualified and certified waterproofers or tilers. Check our registration on the same practitioner search before appointment, just as you would any other builder. You can also phone Melbourne Tiling Services on 1300 661 658 to discuss who coordinates each trade on a bathroom renovation.


For a Melbourne bathroom that needs the full sequence handled in order, from substrate preparation and waterproofing sign-off through porcelain laying, movement joints and sealing, talk to Melbourne Tiling Services P/L about your scope before demolition begins. Visit Melbourne Tiling Services P/L to arrange advice on your renovation, check the work your project involves, and plan the installation before the first tile covers the details underneath.

Bathroom Installation and Tiling: Costs and Timelines

Bathrooms outnumbered kitchens in Australian renovation work in 2024–2025: approximately 244,000 jobs against 163,000 kitchen renovations, based on Housing Industry Association estimates reported by news.com.au. A mid-range refresh that keeps the existing layout, replacing the tiles, shower screen, vanity and fixtures, usually lands between AUD 15,000 and AUD 30,000 and runs for 2 to 4 weeks.

The finished surface tells you almost nothing.

Money and lost days sit underneath it, in demolition, substrate repair, falls, membrane and the cure time each layer demands. A fall that misses the waste or a membrane that skipped a flood test stays invisible until the leak appears. I would verify both before a single tile goes on, and judge any quote on how the contractor proves that hidden work rather than on the tile range being proposed.

Table of Contents

What a Bathroom Renovation Costs and How Long It Takes

A bathroom quote is mostly a wager on what sits behind the old tiles. Two rooms with the same floor area can land weeks and thousands apart once demolition exposes swollen sheeting, a floor out of level, a waste in the wrong place, or a shower base that never had enough fall. Costs vary widely by scope because the visible finish is only the last layer; demolition, substrate, falls and membrane decide whether the job stays simple.

Scope Indicative cost (AUD) Typical duration
Wall and floor re-tile on existing layout 4,000 to 9,000 5 to 8 working days
Mid-range refresh with new tiles, screen and fixtures on existing layout 15,000 to 30,000 2 to 4 weeks
Full redesign with relocated waste, niche or hobless shower 30,000 to 50,000 and above 4 to 8 weeks
Shower leak repair with re-membrane and re-tile 2,000 to 6,000 3 to 7 days

Treat these bands as typical ranges by scope rather than fixed quotes. A re-tile on the existing layout stays shorter because plumbing points do not move. A redesign that relocates the waste, cuts a niche or builds a hobless shower pays for carpentry, new falls and a wider membrane, which is why it stretches toward 4 to 8 weeks.

What pushes the price inside a band

Tile price and format. A standard ceramic wall tile carries a different material cost, and a different cutting day, from large porcelain or stone. More cuts mean more labour even when the square metres match.

Hidden substrate and waterproofing. Stripping sheeting, rebuilding a shower base and laying a new membrane often cost more than the vanity you can see. An out-of-level floor adds screed before a single tile is set, and every extra layer needs time before the next one covers it.

Services and walls that move. Shifting a waste, a tap or a power point brings a plumber or electrician back while the walls are open. Leaving those positions where they are is the fastest way to stay in the lower half of a band.

How to read the quote

Each trade should be its own line: demolition, substrate, waterproofing, tiling, fixtures, electrical and make-good. Exclusions belong in writing, not in a verbal “we'll see on site”. A lump sum with no breakdown is how a cheap quote grows once the wall comes off. Before tiles hide the work, ask for photos of the substrate, the membrane and the shower base fall, and have the fall checked with a level rather than judged by eye. You can test a scope against a bathroom renovation calculator before you compare two written prices.

Practical rule: If the waterproofing line is smaller than the tile-supply line, ask which membrane, how many coats, and whether waterstops are included.

Choosing Between Ceramic, Porcelain, Marble and Kerlite

Water absorption decides whether a tile belongs in a shower. Ceramic is like a biscuit with a glazed coat: the body can still drink water if that coat chips. Porcelain is fired so dense it barely drinks, which is why it suits showers and floors that take constant wet feet.

A comparison chart outlining the characteristics, uses, and costs of ceramic, porcelain, marble, and Kerlite tiles.

Material Best use Water absorption Care needs Relative cost
Ceramic Walls and light-traffic floors Higher, often 3% or more Glaze can chip; wipe clean Low
Porcelain Showers, floors and walls Very low, under 0.5% Low maintenance; harder to cut Low to mid
Marble Feature walls, niches and vanity tops Porous, needs sealing Seal regularly; etches with acidic cleaners High
Kerlite (brand of thin sintered porcelain) Large-format walls and floors, inside and out Low; thin sintered porcelain Few grout lines; needs flat substrate and specialist cutting High

Where each material earns its place

Ceramic is still a sound wall tile where weight and cost matter. I wouldn't put a higher-absorption ceramic on a shower floor that stays wet for hours. It wipes clean on a dry wall and fails the brief once the glaze is breached at the floor.

Porcelain is the default for shower floors and most wet walls. It cuts harder, so blade wear and a slower set-out belong in the tiling days, not only in the box price. Low maintenance is real. Easy cutting is not.

Marble brings natural veining that suits a feature wall, a niche or a vanity top. It is porous, so it needs sealing on a schedule, and lemon-based or other acidic cleaners etch the face. Treat it as a finish you maintain, not a set-and-forget surface. A remnant sill in a niche can look deliberate. An unsealed shower floor in the same stone will mark.

Kerlite is a brand of thin sintered porcelain, so compare it as a large-format porcelain option rather than a separate mineral. The thin slabs give few grout lines and a smooth look inside or out. They demand a flatter substrate, a compatible large-format adhesive and specialist cutting. Fewer joints don't replace falls or a membrane.

Slip, light and the order

Ask for an AS 4586 slip rating. R10 or higher is commonly specified for wet floors. A polished tile that looks right under showroom spots can be the wrong surface once it's soapy.

View samples under the bathroom's own lighting, write down the batch number, and confirm the format fits the walls without a run of skinny cuts. A 600 mm tile on a short return leaves awkward pieces. Change the format on paper, not after the pallet arrives. Large-format work also fails on lippage when the wall waves more than the adhesive can fill. Check flatness with a straightedge, and match the trowel notch to the tile, before you lock the order.

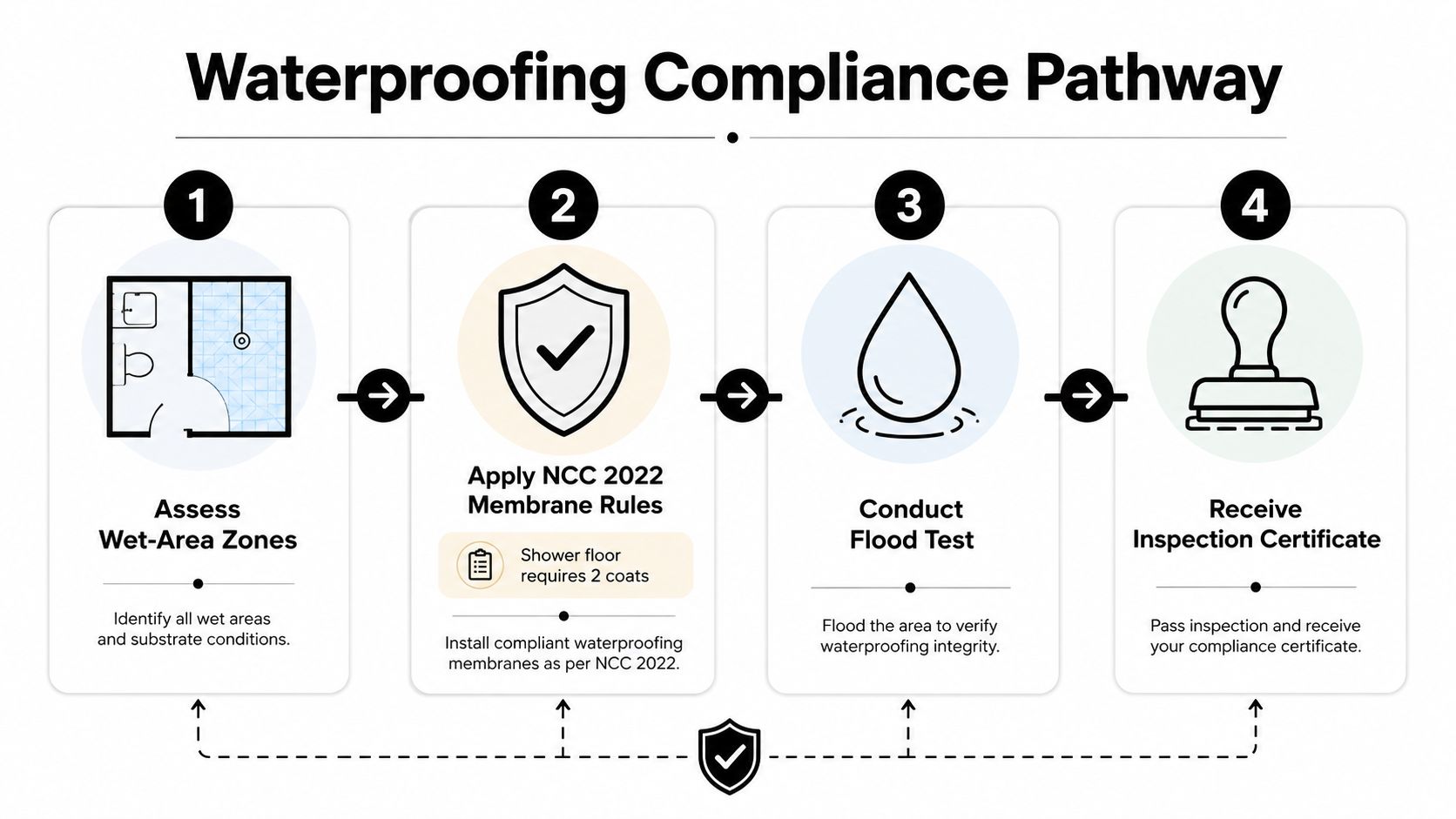

Waterproofing and Falls Before Any Tile Goes On

A shower screen limits splash. It does not seal the floor or the wall. Water still tracks under tiles, through movement joints and around pipes if the membrane stops too low. Adhesive and grout are finishes. They are not the waterproofing system.

In Victoria, the NCC 2022 Housing Provisions require a bathroom shower floor to be waterproof, and shower-area walls waterproofed to at least 1,800 mm above the floor substrate, as set out by the Australian Building Codes Board. For a hobless shower the membrane continues across the floor and up the vertical wall substrate to that height, rather than stopping at the screen line. AS 3740 is the domestic wet-area pathway the Board identifies, with the NCC as the compliance framework. Substrate prep, a compatible primer, bond breakers at internal corners, sealed penetrations and photos of coverage all sit before any tile.

Requirement Rule Why it matters
Shower wall waterproofing height At least 1,800 mm above floor substrate Covers the splash zone above the screen line
Floor fall to waste Between 1:80 and 1:50 Drains water without ponding, around 18.75 to 30 mm over 1.5 m
Unenclosed shower radius 1,500 mm from the shower rose Sets a wider exposed zone for membrane and waterstops
Doorway waterstop Fitted at floor-level openings Stops water crossing the threshold into the room
Membrane coats and coverage As the product data sheet and AS 3740 require Confirms the membrane is continuous and thick enough
Penetrations Sealed at pipes, valves and waste Common entry points for leaks behind tiles

Corners, pipes and the waste

Internal corners need bond breakers or reinforcing so the membrane can flex when the framing moves. A coat painted tight into a sharp corner cracks along the junction. The leak then shows up in the next room, not on the tile face.

Pipe penetrations, mixer bodies and the waste flange are the usual entry points. Each one should be sealed with a collar or sealant the membrane maker accepts, then lapped into the field coat. Primer has to suit the sheet or screed. A second coat only counts if the first has skinned as the data sheet says. The screed that sets the fall has to be in place before that membrane goes down, so drainage doesn't depend on a thick, compressible bed of adhesive.

What to hold before tiles go on

Ask for three records while the membrane is still visible.

  • Product and batch: the membrane name, the batch number and the primer used.
  • Dated photographs: the full floor, the wall height, every penetration and each doorway waterstop.
  • A written check: a flood test, or the equivalent inspection your waterproofer records, before tiling starts.

Those photos are the only proof once the tiles cover the work. The practical sequence is set out in these bathroom waterproofing standards.

A neat tile layout cannot repair a membrane that stopped at the glass.

How Trades Run From Demolition to Grout

A step-by-step infographic illustrating the six stages of a bathroom renovation from demolition to final handover.

A renovation programme is a chain of handovers. The costly mistakes are usually buried by the next trade: an unstable substrate, uninspected rough-in, incorrect fall or membrane covered before it has cured. Check each layer before it disappears.

  1. Demolition, usually 1 to 2 days. Appliances, fittings, shower screens, tiles and substrate sheeting come out. Soft sheet and old adhesive beds get binned rather than tiled over. This is the first chance to assess what the new work will sit on.

  2. Rough-in plumbing and electrical, usually 1 to 3 days. Drains, supply lines, outlet positions and rewiring are completed while the walls remain open, then inspected before anything is closed. Book the return visit before the carpentry slot. A contractor who can handle plumbing calls while on jobs is less likely to leave a required adjustment sitting in voicemail.

  3. Carpentry and substrate, usually 1 to 3 days. Stud walls, a dropped shower base, niches, and new wall and subfloor sheeting are completed. Walls are commonly plaster or fibre-cement sheet. Subfloors may be timber, particle board, compressed sheet or fibre-cement. Swollen or loose sheeting has to be replaced before tiling.

  4. Screeding, then cure. Victorian guidance from the Building and Plumbing Commission sets a minimum fall of 1:80 and a maximum of 1:50 toward a floor waste (about 18.75 mm to 30 mm over a 1.5 m run), and waterproofing across a 1,500 mm horizontal radius from the shower rose connection for an unenclosed shower. Too little fall leaves ponded water, slower drying, mould risk and efflorescence. Too much makes large-format porcelain uncomfortable underfoot and prone to lippage.

  5. Waterproofing, usually 2 to 4 days. Prime the substrate, apply the membrane to the data sheet and AS 3740, fit waterstops, seal penetrations and leave the system to cure. The membrane has to cover the full regulated zone rather than stopping at the screen line.

  6. Tiling walls and floors, usually 3 to 7 days. Floor tiles are cut to suit the shower base fall. Walls are set from a ledger so cut tiles land away from eye level. Check the layout and tile quantities before adhesive is mixed.

  7. Grouting and sealing, usually 1 to 2 days. Colour-matched grout goes across walls and floors, corner joints are sealed, then a penetrating sealer is applied over tiles and grout where the product requires it.

  8. Fixtures and screens, usually 1 to 2 days. The vanity, tapware, bath, cabinets, shower screen and mirror go on after the grout has set. Confirm the finished dimensions before the screen is made.

  9. Final inspection and clean. Run water across the floor, check the waste, silicone lines and fittings, then file the pre-tile photographs and waterproofing records with the handover.

Where the calendar slips

Cure times cannot be shortened with a heater and a hope. A late tile delivery stalls the tiler even when the membrane is ready, and glass measured too early can arrive for a niche or wall line that moved during tiling. Confirm material availability before demolition, keep the hold points in place and move the later bookings when an earlier trade slips.

Spotting Leaks Before Tiles Hide Them

Mould, a brown stain or a loose tile is a late symptom. Waiting for those signs is a poor test of the membrane. By the time the ceiling below blotches, water has already travelled through a cavity.

A registered builder inspects damaged shower tiles for potential water leaks in a modern bathroom shower stall.

Look for earlier signs that don't need a saw.

  • Musty air in the room beside the bathroom, even when the bathroom itself looks clean.
  • Soft or swollen skirting and door frames on the wet-area side.
  • Ceiling stains underneath, often offset from the shower rather than directly below the waste.
  • A hollow tap on floor tiles near the junction, which can mean the bed has let go after repeated wetting.
  • Dark or cracked grout along the floor-to-wall junction.
  • Water sitting on the shower floor after the waste has had time to drain.

A Western Australian inspection of 86 shower areas, covering 1,360 points, found only 60% satisfactory. The WA industry bulletin tied 111 of 539 unsatisfactory findings, about 21%, to waterstops that were missing or installed incorrectly. That defect sits under the tile. Grout colour won't show it.

Membrane, grout or silicone

If the leak shows only at a joint, test the sealant and grout first. Failed silicone in a screen channel is a different repair from a failed membrane. If water tracks through the wall cavity, or appears away from joints, suspect the membrane, a missing waterstop or a badly sealed penetration.

Settle that argument with the handover set: dated photos, the membrane batch and the flood-test note. Re-grouting before that check covers the evidence you need.

For a landlord or property manager, write down the symptom, notify the party named in the contract or tenancy, and book a licensed inspection before anyone skins the wall. In Melbourne, leak detection should chase the path of the water, not just the stain on the paint.

The clip below shows what a wet area looks like once it is opened. That is the stage worth photographing, not guessing after the tiles are back on.

Hiring a Registered Builder and Signing the Contract

In Victoria, a written major domestic building contract is required when bathroom renovations and other home improvements are worth more than AUD 10,000, including alterations and repairs. Consumer Affairs Victoria applies that threshold to the total project value even when the work is split into several smaller contracts. Separate invoices for demolition, waterproofing and tiling don't reset it.

The contract should describe the work in detail, name both parties, state the price, deposits and progress payments, attach plans and specifications, and explain the five-day cooling-off period. That pack is what you argue from if a variation appears in week three.

Registration covers the whole bathroom

A full bathroom combines carpentry, plumbing and tiling, so registered builders matter more than a tiler working alone. Consumer Affairs Victoria states that registration is generally required above that value, while single-trade work such as tiling alone is among the listed exceptions. Someone using a mix of skills, or doing work that needs a building permit, must be registered with the Building and Plumbing Commission. Check the job as a whole, not as "just tiling".

Outside Victoria, state and territory rules set different thresholds and registration tests. Use the equivalent test where the property sits.

Before any deposit

  • Registration: confirm the builder on the Commission's register, and check the licence class covers the plumbing.
  • Insurance: ask for a current certificate of currency for public liability.
  • Waterproofing warranty: get, in writing, who carries it and for how long.
  • Scope: lock every line before money moves.

A low quote with a vague scope usually costs more through variations. If "make good paint" or "relocate the waste" isn't listed, it isn't included.

Pay the deposit against a signed scope, not against a text that says the job will be around that figure.

Confirm Your Scope Before You Book

A quote can look tidy and still leave the expensive parts vague: what happens under the tiles, which walls move, and who makes good after the last fixture is set. Lock the scope first, or the first variation arrives with the skip.

  1. Write the job down. List rooms, tile format and the budget band that matches the work, then mark every change to plumbing, wall position, shower base fall or substrate. A hobless shower is a different job from a re-tile on the same waste.

  2. Put the concealed work on paper. The scope should name demolition down to appliances, fittings, screens, tiles and substrate sheeting; the wall and floor build-up; waterproofing extent; outlet changes; and the checks due before tiling covers them. Ask for the fall to the waste and the inspection point to be stated before dates are booked.

  3. Demand separate lines. Split demolition, carpentry and alterations, plumbing, electrical, waterproofing, tiling, fixtures, caulking and make-good, with exclusions written beside them. Compare that page with the drawings, sketches and agreed modifications, not the mood board.

  4. Match the paperwork before you pay. Melbourne Tiling Services P/L has specialised in bathroom renovations since 2003, runs them with in-house carpenters, plumbers, waterproofers and tilers, and offers free quotes and 3D drawings, so a site visit can price the full scope.

Book the visit, compare the written scope with those checks, and confirm the signed contract covers every item before the first deposit is paid.

Melbourne Tiling Services P/L plans and builds bathroom installation and tiling from demolition through waterproofing and falls to the finished surface. If you're ready to price a Melbourne or Victorian bathroom against a written scope, visit Melbourne Tiling Services P/L and ask for a site visit, a free quote and 3D drawings before you commit a deposit.

How to Quote a Bathroom Renovation: Melbourne Guide 2026

Get three quotes and pick the middle one. That advice is everywhere, and it's useless if the three documents don't price the same job. A Melbourne bathroom quote that hides waterproofing, demolition or permits isn't cheaper, it's incomplete, and you'll pay for the missing lines later as variations.

Learning how to quote a bathroom renovation properly means treating the quote as a scope-and-compliance document, not a headline price. I would start by forcing every bidder onto the same lines, with the same assumptions, before you compare a single dollar figure.

Table of Contents

Scope Lines Every Compliant Quote Must Show

Start with the room, not the finishes. A usable quote records site dimensions, room layout, substrate condition, access for materials and waste, fixture locations, ventilation, electrical changes, plumbing relocations, tile format, grout, trims and shower screen requirements. Without those notes, the estimator is pricing a generic bathroom, not yours.

Bathroom design should be settled at this stage too. We include sketches, plans and discussions in bathroom design, and modifications are agreed before work commences, so the quote prices a layout you've approved.

The Lines That Must Appear

Every scope item gets its own line, marked included, excluded or provisional. Lump sums are where cost hides.

Scope line What it should cover Check before accepting
Demolition and disposal Appliances, fittings, shower screens, wall and floor tiles, substrate sheeting, skip bin Skip size and disposal fees named
Carpentry and substrate Shower base substrate, stud walls, outlet moves, soap niche Framing allowance stated per item
Plumbing Relocations, new outlets, fixture connections Licensed plumber named
Electrical Rewiring, new circuits, exhaust fan Licensed electrician named
Waterproofing Membrane system, falls, penetrations, corners, puddle flanges, waterstops Inspection hold points listed
Screeding and levelling Floor levelling and shower base falls Area and depth stated
Tiling Wall and floor tile areas, trims, grout, large-format handling Waste allowance stated
Fixtures and fittings Vanity, toilet, mixer, shower screen, mirror Supplied by builder or client named
Permits and certification Building permit, surveyor fees, certificate of final inspection Included, excluded or provisional
Contingency Held as a separate line, outside the base scope Percentage and release process stated

That separation matters because an approval value and a quote value aren't the same thing. The Australian Bureau of Statistics building approvals methodology explains that reported building-work values generally include site-preparation costs but exclude land, demolition and landscaping, and that an approved estimate can differ materially from the final completed cost. So ask directly whether demolition sits inside the headline figure or outside it.

The same methodology defines a building approval as the official authorisation that allows construction to begin, called a building permit in Victoria, and notes that planning approval alone doesn't authorise construction. Your quote should state permit and inspection costs as included, excluded or provisional, not leave them silent.

Waterproofing Gets Its Own Detail

Never accept waterproofing buried inside a tiling allowance. Require the quote to name the membrane system, substrate preparation, falls, penetrations, corners, puddle flanges, waterstops, curing time and inspection hold points, referenced to the NCC and AS 3740. An unenclosed shower generally needs waterproofing across the area within 1,500 mm of the shower rose, and the quote should show that coverage, not just say "waterproof shower".

The evidence for this rigour is blunt. A Western Australian government inspection of 86 shower areas found only 60% overall compliance across 1,360 waterproofing inspection points, with waterstop defects accounting for 111 of 539 unsatisfactory items, and a Victorian government analysis reported missing or insufficient waterproofing in 33% of the relevant non-cladding defect cases. Price the hold points and remedial substrate work explicitly, and check what documentation you'll receive through the waterproofing compliance certificate process in Victoria.

Practical rule: If waterproofing has no named membrane, no waterstops and no inspection stage, it hasn't been priced. It's been assumed.

Registration and Assumptions

For bathroom renovations involving coordinated trades, the quote should name the registered builder responsible and separate licensed plumbing and electrical work from general trade allowances. Registration is required for work above the Victorian threshold, for combined skills such as plastering and painting, and for structural work regardless of cost, so a quote that moves walls or coordinates multiple trades should identify who's registered for what. Among registered builders, ask who coordinates the sequence day to day. We deliver bathroom renovations with in-house carpenters, plumbers, waterproofers and tilers, which removes the gaps where one trade waits on another.

Close the scope with written assumptions. State that pricing assumes no concealed structural damage, no asbestos and existing services being reusable, then list variation rates for unexpected framing, rotten flooring, plumbing relocation and levelling. You'll rarely use all of them, but agreeing the rates now, while you can still walk away, is far cheaper than negotiating them mid-demolition.

How to Price Each Line Without Guesswork

A bathroom quote can look precise and still leave major costs undefined. Price it by measurable scope, then expose the allowances and risks that could change the final bill.

A six-step infographic illustrating a clear, logical process for determining accurate and profitable business pricing strategies.

  1. Measure the base scope: Record wall and floor areas separately, and note the substrate condition. Walls and floors involve different tile sizes, cuts and labour, so combining them into one area can conceal an unrealistic rate.
  2. Allow for waste and handling: Set tile waste according to the layout and pattern; diagonal layouts generally require more. Price large-format panels or stone for handling, cutting, levelling and access as well as area. A difficult carry or cut can add labour that a square-metre rate misses.
  3. Confirm fixture specifications: Identify the models before pricing framing and waterproofing. A wall-hung toilet, in-wall cistern, linear waste, niche, frameless screen or recessed mixer can affect framing depth, membrane detailing and trade coordination. Missing specifications leave room for extra cost and delays.
  4. Price labour by trade: Show the labour and coordination required for plumbing, electrical work, waterproofing and tiling, along with the compliance documents included. The NSW government research on serious defects in residential apartments found serious defects in 39% of surveyed strata buildings and waterproofing issues in 23% of all buildings. Clear trade interfaces belong in the price, not in a handshake.
  5. Set provisional sums with unit rates: Use provisional sums for uncertain work, such as levelling or plumbing relocation, and attach a rate per square metre, point or hour. Without a rate and a way to measure the work, an allowance can become an open-ended cost.
  6. Separate margin from risk allowances: Show the margin and identify contingency separately from the priced base scope. Builders managing several jobs use the same separation in cost planning for project-based businesses, keeping base costs, allowances and risk money visible.

This walkthrough shows how those pricing decisions apply to a bathroom layout before a contract is signed.

Each priced line should state a quantity, unit and rate. Compare the total with the bathroom renovation calculator, then ask the builder to explain any gap line by line. Rectifying a failed bathroom can cost far more than building it correctly the first time. Proper falls, compatible systems, inspection photographs and commissioning are small costs beside preventable rework.

Building a Contingency You Can Justify

Published ranges are a reference point, not a budget. One 2026 Australian renovation cost guide places a standard in-place metropolitan bathroom refresh around $15,000–$22,000 and premium work at $25,000–$40,000 or more, while noting that fixed-price contracts may embed an 8–15% contingency and cost-plus arrangements can transfer overrun risk to the homeowner. That trade-off is the part most quotes don't explain.

A risk-adjusted quote shows three figures instead of one. First, the confirmed contract scope for work that can be measured today. Second, realistic provisional allowances for work that's likely but unmeasurable until demolition. Third, a homeowner-held contingency that only you can release. If a builder folds all three into one number, you can't tell what you're committed to and what you're merely allowing for.

Triggers Worth Pricing in Advance

Trigger Usual cause Allowance and approval
Rotten or water-damaged subfloor Past leaks or failed waterproofing Provisional sum per square metre of replacement, approved in writing before work
Uneven or out-of-level floor Old screed or timber subfloor Screeding priced by area and depth, client signs off levels
Suspected asbestos Older sheeting, vinyl or adhesives Testing and removal provisional, work stops until the report is received
Hidden plumbing relocation Pipes concealed in walls or floors Provisional sum per fitting point, variation form signed
Obsolete wiring Old circuits that do not meet current requirements Rewire provisional, licensed electrician report required

Melbourne's older housing stock makes these triggers common rather than exceptional. Concealed water damage, uneven substrates, obsolete plumbing and apartment body-corporate requirements can all move the final cost, so the allowance should name the trigger, the evidence and the approver before work starts.

A suspected leak or failed waterproofing makes a cheap cosmetic quote the wrong product. Get the wet area assessed first, then price finishes on a sound substrate.

Close with a release rule you both sign up to. Contingency money moves only after photographs of the concealed condition, a written variation with a price, and your sign-off before the extra work begins. Decide in advance what event justifies spending it, and the contingency stops feeling like a slush fund and starts working as insurance you've already priced.

Comparing Two Quotes Line by Line

Say two builders quote the same 2.4 m by 2.2 m Melbourne bathroom, one at $18,000 and one at $17,200. These figures are illustrative, but the method is exactly what you should run on real quotes. The cheaper headline wins only until you normalise the scope.

Step 1, demolition: Quote A includes demolition, skip hire and disposal in its base. Quote B excludes them, so add $2,100 to Quote B before comparing anything else.

Step 2, waterproofing: Quote A names the membrane system and inspection hold points. Quote B prices waterproofing inside its tiling allowance, so price it as its own line at $1,400 and ask B to confirm the detailing in writing.

Step 3, permits: Quote A marks permit and surveyor fees provisional at $900. Quote B says nothing, so add the same $900 provisional sum to B, with a unit basis for how it's reconciled.

Step 4, contingency: Quote A holds a 10 per cent contingency of $1,800 outside the base, released only on approved variations. Quote B holds none, which doesn't remove the risk, it just leaves it unpriced and entirely yours.

Scope line Quote A Quote B normalised
Demolition and disposal Included in $18,000 base Excluded, add $2,100
Waterproofing Named membrane and hold points in base In tiling allowance, add $1,400
Permits and surveyor fees Provisional, $900 Not stated, add $900
Contingency 10 per cent owner-held, $1,800 None allowed
Total $18,900 before contingency $21,600 before contingency

The $800 headline advantage for Quote B becomes a $2,700 disadvantage once the lines match, and that's before Quote A's contingency is considered. Quote A also tells you how surprises get handled, Quote B doesn't. Run this normalisation on every quote you receive, in a spreadsheet, one row per scope line. Any cell a builder won't fill in is a cost you'll meet later.

Contract Terms, Milestones and Variations

A bathroom quote is also a contract about compliance, timing and who pays when the scope changes. In Victoria, building work above a statutory value threshold requires a written domestic building contract. Work above the higher major domestic building contract threshold requires that contract with a registered builder. Splitting one job across separate agreements does not avoid the applicable requirements. The Building and Plumbing Commission's guidance on domestic building agreements and contracts explains the requirements.

The contract should identify the builder, set out the plans and specifications, and state who will obtain any required planning and building permits. Confirm the permit pathway and the completion document that applies to your project before work starts.

A timeline diagram showing six project phases from contract terms to final completion for construction projects.

Milestones That Release Money

Milestone Trigger Document required
Deposit Contract signing Signed contract and builder registration details
Progress payment Demolition completed Demolition completion record and disposal documentation
Progress payment Waterproofing inspection passed, before tiling Inspection record and photographs
Progress payment Tiling completed Tiling completion photographs
Final payment Practical completion Applicable completion documentation

Tie each progress payment to work that is complete and evidence the contract specifies. The builder can price the job without financing work that has not started, while you can check the claimed milestone against the work on site. Set out the sequence and expected timing in the contract; the bathroom renovation timeline shows how trades and project stages fit together.

A variation must state the change, its price and any effect on the completion date. Get your written approval before the changed work begins. A verbal instruction can leave both the cost and the schedule disputed.

Release rule: Match each claim to its agreed milestone and supporting record. If the waterproofing inspection record is missing, resolve that gap before tiling starts or the related progress payment is released.

Confirm the Quote Before You Sign

A quote is ready to sign when its scope, exclusions and costs can be checked without filling in gaps yourself. Use this checklist with the document in front of you.

A checklist infographic titled Confirm the Quote Before You Sign, outlining essential steps for reviewing contractor quotes.

  • Header details: Check the builder name, registration number, property address, quote date and validity period.
  • Scope status: Confirm every line is marked included, excluded or provisional, in the same order as the comparison quote.
  • Provisional sums: Check the unit rate for each allowance and list owner-supplied items, so the vanity is not ordered twice.
  • Money controls: Confirm variation rates, the payment schedule, warranty and insurance details, and the contingency you are holding.
  • Permit responsibility: Name who handles each permit, and mark fees as included, excluded or provisional.

Then compare the quotes line by line. Can each scope item be matched without blank cells? Are exclusions written down before demolition, rather than left to be resolved on site? If not, ask for the quote to be completed before signing. A low total can conceal costs when demolition, waterproofing, permits or contingency are omitted or treated differently.

Melbourne Tiling Services P/L offers free quotes and 3D drawings for bathroom renovations, and its website has a bathroom renovation calculator for an early budget check. The full bathroom renovation scope listed on the page is offered for a median price of $10,000. Treat that as a benchmark; the figure you sign should reflect the measured scope and agreed inclusions.

Send your room dimensions, photos and the fixtures you're considering, and we'll arrange your free quote and 3D drawing through Melbourne Tiling Services P/L, so you can compare it line by line with any other quote. For a different kind of business communication, switching to a hosted phone system is an option, but it does not replace a clear written renovation scope.

Bathroom Tiling Cost Calculator: Melbourne Prices 2026

Approximately AUD 26,000 was reported as the average Australian bathroom renovation cost in 2025 (renovation-cost summary). That number is a reminder that visible tile work is only one line in a bathroom budget.

A useful bathroom tiling cost calculator prices the whole scope instead of multiplying floor area by one installation rate. Waterproofing, preparation, supply and the associated plumbing and electrical work decide whether the total stays under the $10,000 licensing threshold or moves into a full contracted renovation. For Melbourne homeowners, the practical question is what has to be removed, prepared, waterproofed, supplied and installed in the same job.

Table of Contents

Bathroom Tiling Cost Ranges at a Glance

68% of Australian bathroom budgets blow past the tile allowance once preparation and waterproofing are priced. That gap is why a per square metre tile rate misleads. The table below compares like with like, by scope.

Reported bathroom tiling and renovation costs Reported cost Basis
Full bathroom scope listed by the provider $10,000 median Provider's published median
Average Australian bathroom renovation, 2025 Approximately AUD 26,000 Build-it.au

Melbourne Tiling Services lists a full bathroom renovation scope at a median price of $10,000. Treat that as a provider-listed benchmark for one defined scope. It is not a fixed quote, and it does not promise every bathroom can be completed for that amount. I recommend using it as the low-scope anchor, then adding line items for demolition, substrate repair, waterproofing, tile supply differences and plumbing or electrical work.

The spread between benchmarks comes from inclusions. One figure may bundle demolition, fixtures and several trades. Another may cover surface preparation, tile supply and laying only. A tile-only total leaves out compliant waterproofing, falls to waste, and substrate repair. Those three items often decide whether the job passes inspection and holds up in a wet area.

Match the benchmark to the job

Historical Australian Bureau of Statistics data shows why a single national price can mislead. In 1999, almost 1 million Australian households had completed a bathroom upgrade during the preceding decade, and bathrooms were among the three most common renovation categories. The ABS also found that, among owner-occupier households that had renovated their current dwelling and incurred costs, average expenditure over the previous two years was $12,100, compared with an average renovation cost of $5,800. Those historical figures show the range of project sizes, not current Melbourne quotes (Australian Bureau of Statistics historical renovation data).

Permit reporting adds another reference point. Official building activity reporting covers certain residential alterations and additions with approval values from $10,000 to less than $75,000, as well as non-structural renovation and refurbishment work (ABS Building Activity collection). That $10,000 line matters for budgeting. Cross it and paperwork, supervision and trade coordination can change the total even when the tiling area stays the same.

Pick the row closest to your planned work. Then price your own scope line by line, with waterproofing measured as a compliant treatment area.

Calculator Line Items and Trade Add-Ons

A practical estimate is the sum of separate costs, not one area multiplied by one rate:

Total = demolition and disposal + substrate repair and screeding + waterproofing + tile supply + installation and cutting + trims, grout and silicone + plumbing, electrical and fixtures + GST.

Enter one input for each line. If a cost isn't known yet, keep it visible as an allowance or provisional sum rather than leaving it out.

Calculator line items, inputs and calculation basis Input needed Calculation basis Note
Demolition and disposal Floor and wall areas, fixture count Per item and per m² Include substrate sheeting removal
Substrate repair and screeding Floor level variance, shower fall Per m² plus levelling depth Flags uneven or failed substrates
Waterproofing Shower footprint, wall height to 1,800 mm, junctions Compliant treatment area, not whole floor Measured against NCC requirements
Tile supply Tile area, format, pattern m² × waste factor × tile rate Tile rate: current supplier quote
Installation and cutting Tile area, cuts, format m² × labour rate Large format needs more labour
Trims, grout and silicone Perimeter length, joints Linear metres × rate Rate: current supplier or installer quote
Plumbing, electrical and fixtures Fixture list Per-item quote Hold as provisional sum if concealed

An infographic detailing the seven step process for calculating costs for bathroom tiling from demolition to installation.

Fill the estimate in order

  1. Demolition and disposal. Enter the floor and wall areas to remove and count the fixtures, screens and other items being taken out. The demolition scope may include appliances, fittings, shower screens, wall and floor tiles, and substrate sheeting. Price by area and by item so removal of a screen or fitting doesn't disappear inside a generic square-metre rate.

  2. Substrate repair and screeding. Record unevenness, the depth of levelling and the shower fall required to direct water to the waste. Note the existing base, including timber flooring, particle board, compressed sheeting or A/C sheeting, and flag failed plaster or damaged substrate for inspection once demolition exposes it.

  3. Waterproofing. Enter shower footprint, wall treatment height, junctions and penetrations. Measure the compliant treatment area, not the room's entire floor area. The requirements behind this line are discussed below.

  4. Tile supply. Multiply the tiled area by the waste factor and the current tile rate. For a rectangular layout, a factor of about 1.10 gives an initial allowance; add more for diagonal layouts, mosaics, niches and large-format panels.

  5. Installation and cutting. Multiply the tile area by the quoted labour rate, then account for format, pattern and cuts. Cutting to suit a shower-base fall takes additional care and shouldn't be assumed to cost the same as laying an open rectangular floor.

  6. Finishing materials. Measure trims and silicone runs by length, and grout by the joints and tiled area it serves. Confirm whether the quote includes colour-matched grout, sealing and corner joints.

  7. Trade add-ons and GST. List plumbing, electrical work and fixtures separately. Concealed work belongs in a provisional sum until the scope is known. Show GST as its own line so the final total is clear.

Melbourne Tiling Services has a bathroom renovation calculator, and its parent business, Melbourne Tiles, enables it to supply tiles and tiling materials at wholesale prices. Whether one coordinated provider or separate contractors carry out the work determines which costs sit in a single scope. Check the combined total against the registration rules described later.

Waterproofing Costs Hidden Behind Tile Prices

Measure waterproofing by the compliant treatment area, not by the total bathroom floor area. The shower floor, specified shower walls and relevant junctions have their own requirements. A calculator that asks only for total floor and wall square metres can therefore produce a neat-looking estimate that misses important wet-area work.

Under the NCC Housing Provisions, shower floors must be waterproof, shower walls must be waterproof to at least 1,800 mm above the floor substrate, and wall junctions and joints in the shower area must also be waterproof. The NCC allows AS 3740:2021 as a deemed-to-satisfy pathway, but the applicable Housing Provisions clauses must also be met. The two sets of provisions can't be mixed and matched (NCC Housing Provisions for wet-area waterproofing).

A waterproof membrane isn't interchangeable with a water-resistant area. The treatment and measurement need to reflect what the job requires. For an unenclosed shower, Victoria's NCC 2022 wet-area provisions extend the required shower area within a 1,500 mm horizontal radius of the shower rose, with a floor waste and water stop required in the relevant area. This can change the quantity for a walk-in shower or a shower-over-bath layout without a screen (Victorian Building and Plumbing Commission guidance on wet-area waterproofing).

Ask the questions that change the area

A usable calculator needs more than a room measurement. Enter the shower footprint, wall height, hob or step-down, penetrations, niches, floor waste and wall-to-floor junctions. Then record whether the shower is enclosed, whether the layout is changing, whether a bath is being removed, whether a floor waste exists, and whether the work is a new installation or rectification.

Those answers affect the treatment area and may expose associated work. Removing a bath or changing a shower layout can involve plumbing and substrate changes as well as new tiling. Demolition that removes old tiles and substrate sheeting can also reveal a base that needs repair before it can be waterproofed.

Domestic wet-area compliance is tied to AS 3740, and membranes must demonstrate compliance with AS/NZS 4858:2004, according to the Victorian Building and Plumbing Commission. For landlords and property managers, the risk in a low tiling estimate isn't just a missing finish item. Leak rectification can involve removing damaged work and correcting the cause before retile. Melbourne Tiling Services handles shower leak repairs, waterproofing and tiling; its bathroom waterproofing cost information can help frame the waterproofing part of the estimate.

Tile Type, Format and Labour Drivers

Tile choice changes more than the supply line. Format, material and layout set cutting time, substrate preparation, handling and waste, and those four items are where a static rate per square metre stops matching the actual job.

A professional tiler inspecting a tile sample while surrounded by various tile types in a bathroom.

Ceramic and standard porcelain are the simplest families to cut and set. Supply and labour both start from the measured area, but the two rates move independently. A 600 x 300 porcelain and a 300 x 300 ceramic can carry similar installation allowances yet sit some distance apart on purchase price, so enter the selected tile's current rate and a separate installation rate. Treating "porcelain" as one price flattens a real difference.

Large-format porcelain and sintered panels, including Kerlite, put the cost into preparation rather than coverage. A 1200 x 600 tile or a full-height panel needs a substrate flat to a tight tolerance, two sets of hands, and a cutter that won't chip an exposed edge. Fewer joints means less grouting, but one hollow spot or a badly placed cut shows across a much larger surface. Price the substrate correction and the handling as their own lines. Melbourne Tiling Services provides large-format tile installation information.

Bigger format does not automatically mean faster. On a small bathroom floor, cutting around a floor waste and a doorway can consume most of a panel, so the waste factor climbs even as the joint count falls.

Marble, granite and other stone bring weight, sensitive cutting and sealing considerations. Stone varies from piece to piece, making selection and layout part of the work rather than a line on a supplier invoice. Allow for the material's handling requirements and a higher waste factor where cuts or breakage risk justify it.

Glass and mosaic tiles require more individual alignment and produce more cuts than a plain field tile. They're often used in niches, accents or shower floors, where those details make a layout more labour-intensive. Mosaic sheets on a shower floor also have to follow the fall, so setting-out time sits well above what the small area suggests. Raise the waste factor and installation allowance rather than pricing the area as standard rectangular tiling.

Terracotta and slate can have uneven faces or thicknesses, so substrate flatness and setting need attention. Their purchase rates also move more than a calculator implies: supplier price reviews, batch availability and the timing of your order all shift the final tile price, and a rate captured months ago may not survive to the order date. Date the price assumption.

Cutting tiles to suit the shower-base fall adds work across every tile family. Melbourne Tiling Services specialises in ceramic, marble, granite, terracotta, porcelain, Kerlite and slate, and cuts floor tiles to suit the shower base fall as part of wall and floor tiling. Set the tile rate, labour input and waste factor from the selected material and format, then date the assumption so it can be checked against a later supplier quote.

Running Low, Base and High Scenarios

A useful calculator produces three totals from three sets of assumptions. It doesn't pretend that a single rate will cover a standard floor, a mosaic shower and a large-format wall equally well.

Low, base and high scenario inputs Waste factor Price date
Low About 1.10 for a rectangular layout Dated supplier assumption
Base About 1.10, with an added allowance for diagonal or mosaic detail Dated current quote
High Higher factor for diagonal, mosaic, niche or large-format work Dated highest supplier assumption

Use the same measured tile area in each scenario, then change the inputs that reflect the work. Low uses the lowest dated supplier rate and lowest quoted labour rate. Base uses current quoted rates and adds an allowance for any diagonal or mosaic detail. High uses the highest dated rate, a larger waste factor for complex work and labour priced for careful cutting or large formats.

A repeatable example

Take the ensuite floor example from later in the article: 4.5 m² of floor tile. With a rectangular-layout waste factor of 1.10, the order quantity is 4.95 m². That quantity is the same in the low and base scenarios if the layout stays rectangular. The supply totals are then:

  • Low: 4.95 m² × the lowest dated tile rate.
  • Base: 4.95 m² × the current quoted tile rate.
  • High: 4.95 m² × the highest dated tile rate, or a higher order quantity if the design adds complex cuts.

Add the matching installation allowance to each supply total, then add the other line items. Don't invent a dollar result when supplier and labour rates aren't available: the spread is the difference between the actual inputs you enter.

The dated assumption matters because tile prices can change with supplier reviews and availability. A stale rate can make an estimate look more certain than it is. Compare each completed scenario with the Melbourne renovation benchmark of $24,000 to $38,000 in the earlier table, while remembering that the benchmark may include a broader scope than your tiling job. Query any quote line that sits outside your chosen range, starting with tile supply, labour, waterproofing and provisional sums.

Licensing Thresholds That Change Your Budget

In Victoria, domestic building work generally requires a registered building practitioner when the contract value exceeds $10,000, including labour and materials, according to Consumer Affairs Victoria's registered-practitioner guidance. Registration is also required for work that needs a building permit, regardless of cost. The threshold is why a tile-only calculator can mislead: it prices square metres, while the licensing question is about the combined scope.

A bathroom renovation can combine carpentry, plumbing, electrical work, waterproofing and tiling. Each line may look modest on its own. Add them together and a job that started as retiling crosses $10,000. Melbourne Tiling Services lists a median price of $10,000 for the full bathroom renovation scope on its page, which shows how little extra scope it takes to move from a straightforward tile job into a contract that needs a registered practitioner and a permit check.

Make the combined scope visible. Add every line from the estimate, including labour and materials. Mark each trade included and flag the project if the combined contract value crosses the threshold or if a building permit is needed. Don't check each trade in isolation. The combined scope is what matters.

Waterproofing is the line most often buried. A shower membrane, wall junctions, floor waste and substrate preparation can add cost without adding a single visible tile. If waterproofing is treated as a small allowance when the compliant area and detailing call for more, the contract value is understated and the threshold test is wrong. Price the waterproofing area from the shower footprint, wall treatment and junctions, not the whole floor area.

Before signing, verify the practitioner's current registration, permitted work types and any conditions using the Building and Plumbing Commission's public search tools. Melbourne Tiling Services coordinates in-house carpenters, plumbers, waterproofers and tilers, so the combined-scope question applies to its bathroom work as it would to any other contractor. Confirm that the practitioner you engage is registered for the work they will perform.

The practical point: add the trade costs before deciding that a bathroom job is just tiling. Plumbing, electrical work or carpentry can turn a narrow estimate into a coordinated renovation with different obligations. Keep those costs visible in the calculator rather than burying them in a single total.

Worked Examples for Typical Melbourne Bathrooms

These examples show how to organise quantities and scope, not fixed prices. Use current supplier and labour rates in the calculator, then compare the completed total with the benchmark that best matches the work.

Worked Melbourne bathroom examples Key inputs Scope covered Reported benchmark
Ensuite renovation 4.5 m² floor, 9 m² wall tiling, new shower, floor waste Full scope including waterproofing and fixtures $24,000 to $38,000 Melbourne range
Family bathroom 6 m² floor, 14 m² wall tiling, bath removed Full scope including demolition and trades No project-specific benchmark verified
Shower leak rectification Shower over bath, existing membrane condition Repair, waterproofing and retiling No project-specific benchmark verified

Ensuite renovation

  1. Order the floor tile. Multiply the 4.5 m² floor area by a 1.10 rectangular-layout waste factor. That gives 4.95 m² to order before adding any allowance for a complex pattern.
  2. Measure waterproofing. Use the shower footprint, wall treatment and junctions to establish the compliant area. Don't price waterproofing against the entire bathroom floor just because that area is easy to measure.
  3. Add the remaining scope. Enter the 9 m² of wall tiling, then add demolition, substrate work, the new shower and floor-waste coordination, fixtures and trims. Price each line using current rates.
  4. Test the layout. If the shower is unenclosed, apply the relevant treatment-area rule. If the layout changes, revise demolition, plumbing and waterproofing inputs before comparing totals.

Family bathroom with bath removal

  1. Enter the 6 m² floor and 14 m² wall-tile areas separately.
  2. Add bath removal to demolition, then include any plumbing work needed to suit the new layout.
  3. Price substrate repair, waterproofing, tiles, cutting, finishing and fixtures as separate lines.
  4. Check the resulting total against the chosen low, base or high scenario. There's no verified project-specific benchmark for this exact scope, so a renovation-wide figure should be treated as context, not a target quote.

Shower-over-bath leak rectification

Start with the existing membrane condition and the area that must be opened to identify and repair the problem. Then include substrate work, compliant waterproofing and retiling. If the shower is unenclosed or the layout is changing, revise the treatment and trade inputs; don't assume the original tiled area is the full repair scope.

For all three examples, compare like with like. A full renovation benchmark includes a broader scope than tiling alone. Check the combined trade total against the licensing threshold, and keep unknown concealed work as a provisional sum rather than presenting an incomplete total as final.

Get an Itemised Quote Before You Book

Request an itemised, scope-based quote before committing to a bathroom budget. Ask for these lines separately:

  • Demolition and disposal, including which fittings, screens, tiles and substrate will be removed.
  • Substrate repair and screeding, with any assumptions about levelling and shower falls.
  • Waterproofing, with the treatment area and system clearly stated.
  • Tile supply, including product, format and waste factor.
  • Installation, including cuts, pattern and large-format handling where relevant.
  • Trims, grout and silicone, with the finishing work specified.
  • Trades and fixtures, with concealed work shown as provisional sums.
  • GST, shown as a separate line.

Melbourne Tiling Services offers free renovation quotes and 3D drawings. You can request a bathroom renovation quote and compare its scope against your own calculator inputs.

Compare the quote with the scenarios

Put the quote beside your low, base and high totals. Start with waterproofing and provisional sums if a line sits outside the scenario you chose; these are often absent from a tile-only estimate, even though they can change the job. Check that the quoted floor and wall areas, tile quantities and trade inclusions match your measurements.

Then check the combined contract value against the $10,000 threshold and verify that each practitioner is registered for the work they're carrying out. Melbourne Tiling Services can be phoned on 1300 661 658 and is open Monday to Saturday from 7.00 to 18.00, closed Sundays.


Melbourne Tiling Services P/L provides bathroom renovations, waterproofing, tiling and a bathroom renovation calculator to help you organise the scope before work begins. Visit Melbourne Tiling Services P/L to plan your bathroom, request a free quote and discuss a 3D drawing for your project.

Frameless Shower Screen Installation Cost in Melbourne

A standard frameless shower screen for a straightforward Melbourne ensuite is commonly AUD 1,200–2,500 supplied and installed. That band is a planning benchmark for a typical rectangular opening, while some national estimates reach AUD 2,800 and curved or highly customised screens can sit well above it.

The figure that should reset the budget conversation is not the hinge finish. A frameless panel is one line in a wet-area job. Glass compliance, the condition of the waterproofing, and Victorian contract thresholds move the total further than a swap from chrome to matte black. A screen-only price and a full bathroom renovation are different contracts, and only the larger job reliably pulls in registered builders, coordinated trades and the paperwork that goes with them.

Table of Contents

Frameless Shower Screen Prices at a Glance

A standard frameless shower screen for a straightforward rectangular ensuite is commonly priced at AUD 1,200–2,500 supplied and installed, and some national estimates reach AUD 2,800, according to Australian shower screen cost guidance. Framed or semi-frameless screens are commonly estimated at about AUD 500–900 installed, so the frameless step-up is large before anyone debates hardware colour.

A graphic showing the estimated cost range for frameless shower screen installation, between $1,200 and $2,500 AUD.

Screen type Typical installed price What the figure reflects
Standard frameless, rectangular ensuite AUD 1,200–2,500 Benchmark for a straightforward Melbourne ensuite
Frameless, upper national estimate Up to AUD 2,800 Some national estimates extend to this figure
Framed or semi-frameless AUD 500–900 Commonly estimated installed price

These are supplied-and-installed benchmarks, not a rate per square metre. A single-panel opening with easy access sits nearer the lower end. Multi-panel layouts and difficult access sit higher. On the same guidance, curved, oversized or highly customised screens can exceed AUD 3,500.

Custom or non-rectangular openings need a site measure and an individual quote. Out-of-square walls change templating even when two bathrooms look the same on a sketch.

The screen is usually one line inside a wider bathroom renovation. A full bathroom renovation scope we list is offered for a median price of $10,000, which already shows the glass can be a fraction of the wet-area total once waterproofing, tiling and fittings are in the job.

Practical rule: If a frameless quote falls far below AUD 1,200, check what is excluded before you accept it. Older published component prices run lower and often leave out substrate, waterproofing and compliance items.

Removal of an existing screen, disposal, silicone finishing, waterproofing repairs and GST can each change the installed cost. While you compare finishes, it helps to explore architectural shower fixtures so the screen, tapware and waste read as one wet-area design rather than three separate purchases.

What Pushes the Installed Price Up or Down

A quote is a bundle of glass, hardware, templating, delivery and labour. Read it as a stack of lines, not as a single product price.

Drivers in order of impact

Heavier 10 mm toughened glass comes first. It costs more to make, carry and set, and every hinge and clamp has to be rated for that weight. Our shower screens are custom or frameless, high quality, Australian made and certified, so the hardware has to match the panel, not the other way around. How frameless shower screen hinges are fixed matters more than the colour of the cover plate.

Custom measurement for out-of-square openings is next. Many Melbourne ensuites, especially in older houses, are not square. The extra cost is templating and adjustment, not a prettier bracket.

Premium hinges and brackets follow glass and measure. Finish changes the look. Capacity and anchor type change whether the panel stays true after a year of use.

Corner or multi-panel layouts add another sheet, another joint and another alignment. Difficult access in a tight ensuite or an upper-floor bathroom adds handling time for the same glass. Stairs, small landings and a shower tucked beside a vanity all slow the set.

What older component prices still show

Earlier Australian pricing published by hipages split supply from installation. Treat the table as a way to see that split, not as a current Melbourne quote.

Screen type Supplied price Installation Combined
Two-panel frameless screen AUD 410 AUD 195 AUD 605
Rectangular frameless screen AUD 550 About AUD 195 About AUD 745
Three-panel sliding frameless system AUD 690 AUD 400 AUD 1,090

Installation rises with panel count because each panel needs its own fixing and alignment. The two-panel and rectangular jobs were listed near AUD 195 to install. The three-panel sliding system was listed at AUD 400.

A three-panel sliding system at about AUD 1,090 combined is the glass and the hang, before anyone removes an old screen or repairs waterproofing. Add those and the old component total is no longer the job.

Our shower screen, fittings and appliance work includes installing the shower screen, plumbing and electrical fittings, cabinets, baths and mirrors. That is why a screen-only number and a fittings package should not be compared as if they were the same line.

Glass Thickness and Safety Rules That Set the Spec

Safety compliance sets the spec, and the spec sets a large part of the frameless shower screen installation cost. Australian shower-screen glazing must use Grade A safety glass compliant with AS/NZS 2208, while AS 1288 governs selection and installation in buildings. As Quote Yard's shower screen guidance notes, that applies to frameless, semi-frameless, fixed-panel and framed enclosures, with no general exemption for small or fixed panels.

A professional tradesman in a dark polo shirt measures a glass shower panel with a yellow tape measure.

People often assume a frameless screen is a framed screen with the aluminium taken off, so a thinner sheet should do. The standards don't work that way. Frameless systems commonly use 10 mm toughened glass, and Australian building guidance identifies 10 mm as the minimum thickness for frameless screens, compared with 5–6 mm for fully or partly framed systems.

Case Glass thickness cited Standards that apply
Frameless toughened screen 10 mm, the common minimum in Australian building guidance AS/NZS 2208 and AS 1288
Frameless application under one NSW guidance At least 6 mm toughened glass AS/NZS 2208 and AS 1288
Exposed-edge panel Minimum 6 mm nominal toughened safety glass AS 1288-related guidance
Fully or partly framed system 5–6 mm AS/NZS 2208 and AS 1288

Where the thickness advice splits

One line of guidance treats 10 mm as the frameless minimum. Another, including cited NSW guidance, puts frameless applications and exposed-edge panels at a minimum of 6 mm toughened safety glass. Both still sit under AS/NZS 2208 and AS 1288. The practical step is to ask the installer which thickness this opening needs, and why that thickness is on the quote. Frameless shower screen regulations are the right checklist for that conversation, not a showroom photo.

Thicker glass adds weight. Weight demands compatible hinges, clamps, anchors and wall support. Inadequate substrate strength, poor alignment or too much movement transfers stress into the glass or the hardware.

Cheaper-looking hardware doesn't save money if it is under-rated for the panel. Unsafe loading shows up later as a replacement, not as a discount on day one.

A practical Melbourne quote should verify glass certification, thickness, hardware capacity, fixing locations, and whether waterproofing remains intact. The screen is not a substitute for a compliant waterproofed base or wall. On the certificate, check the Grade A mark, the stated thickness, and that the hardware schedule matches the weight of that sheet.

The measuring step in the clip below is the part quotes often compress into a single labour line. Templating errors can't be trimmed out after the glass is toughened.

Quote Checklist and Hidden Wet-Area Costs

Two quotes can carry the same headline figure and still be different jobs. The difference sits in what is left out: substrate repairs, damaged tiles, silicone removal, or existing glazing that cannot stay. Match those lines before you compare the totals. The screen is only one line in a wet-area budget. Documented glass compliance, the condition of the waterproofing, and whether the job stays a screen swap or turns into a coordinated bathroom package move the total further than the hinge finish.

An infographic checklist for estimating costs and hidden expenses when installing a home shower screen.

Ask these questions, in this order. A missing answer is a missing cost.

  1. Glass. Does this quote include compliant glass, the thickness, any treatment, and certification you can keep? AS 1288 covers human-impact safety, not the look of the bathroom. Imported glass still has to meet the Australian glazing requirements.
  2. Hardware. What finish, hinge and bracket type, and fixing method are included, and are they rated for this glass weight? Engineering-grade fixings and drilling into the substrate belong on the page. Finish is the smaller variable. An under-rated hinge is the one that comes back as a replacement.
  3. Site. Is there a measure on site, not a phone estimate, and are out-of-square walls included? In Melbourne renovations the screen often goes in after waterproofing and tiling, so access, tile condition and wall construction are cost drivers. Door configuration, delivery and compliance documentation belong in the same itemised scope.
  4. Old screen. Who removes it, who disposes of it, and who makes good tile or wall damage? Bathroom demolition that includes the old screen, fittings and wall tiles is a separate scope from supplying new glass.
  5. Sealing. Is old silicone removed, and is new silicone finishing included?
  6. Waterproofing. Is the existing membrane inspected, and who pays if it needs rectification?
  7. Tax. Is GST included in the figure you are comparing?
  8. Warranty. What do the glass, hardware and installation warranties each cover, and where do they stop?
  9. Design. Are sketches or plans part of the price, and will changes be agreed in writing before work starts? Melbourne Tiling Services includes sketches, plans and discussions in bathroom design, and modifications are agreed before work commences.

A low quote usually omits one of items 4 to 6. Until those lines match, the headline figures are not comparable. Plumbing labour beside the screen is easier to compare when each exclusion is its own line, which is how take-off tools such as Exayard plumbing estimating software are used on the trade side.

Faults that appear when the glass arrives

A screen can be priced cleanly and still need extra work where tiles are hollow, walls are out of plumb, fixings cannot reach framing, or old penetrations need repair. Those faults show up when the glass is on site, after toughening, when the panel can no longer be trimmed to suit the opening.

The base is a built assembly, not a tray the glass stands on. Melbourne Tiling Services installs shower bases with a hob, screed to form the fall, a puddle flange and a shower grate such as smart tile, grill or square waste. The screen then fixes into the surrounding walls. If the fall, the flange or the wall fixings are wrong, the fault shows up at installation, and the glass price does not correct it.

Waterproofing from the same contractor covers walls and floors, interior or exterior, shower walls and floors, balconies and retaining walls. Replacing an existing enclosure carries more risk than setting glass during a full renovation, because the old membrane is exposed when the old screen comes off. Hold the screen price separate from a contingency for substrate and waterproofing investigation. Dropping the base substrate or building a stud wall should appear as its own item in the written scope, not inside the glass line.

For landlords and property managers, the cheap install can become the larger liability if a leak, a glass failure or a non-compliant product causes damage. Put one question in writing. Who pays if the investigation finds a fault, and does the installer coordinate waterproofing rectification or stop at the glass?

Victorian Thresholds That Change Your Budget

A frameless screen quote looks self contained. The budget rarely is. Glass compliance sets the specification, while the condition of the waterproofing and the total value of the domestic building work decide the paperwork, the contract form and the insurance position.

Victorian consumer guidance places two money figures on that paperwork. Work worth more than $10,000, including renovations, extensions and repairs, generally requires a written major domestic building contract and a builder registered with the Building and Plumbing Commission, as set out in Consumer Affairs Victoria's guidance on builders and tradespeople. Victoria's renovation checklist for work costing more than $10,000 requires domestic building insurance before a deposit is taken or work begins when the work costs more than $16,000.

Work value or type What to allow for in the budget
Up to AUD 10,000 Terms still need confirmation in writing with the builder, even where a major domestic building contract is not used
Above AUD 10,000 Written major domestic building contract and builder registration, per Consumer Affairs Victoria's guidance on builders and tradespeople
Above AUD 16,000 Domestic building insurance provided before a deposit is taken or work begins, per Victoria's renovation checklist for work costing more than $10,000
Structural work, any price Builder registration required, and a building permit may apply

Screen-only versus a full renovation

A screen-only replacement can sit under both money thresholds. A complete renovation that combines demolition, plumbing, waterproofing, tiling and structural change often crosses them. Apply the test to the project value, not the glass line alone.

The distinction matters because bathroom work counts as domestic building work when it involves building, renovating or repairing a bathroom without extending beyond the existing external walls, floor or ceiling, and the Building and Plumbing Commission treats selecting and applying suitable waterproofing as part of that scope. A building surveyor must not issue a building permit for domestic building work under a major domestic building contract unless a builder registered in the appropriate class is carrying out the work. The same guidance lists exceptions for some single-skill jobs, including tiling and glazing. A coordinated bathroom renovation does not necessarily fall inside a single-skill exception.

The registration application for a builder limited to bathroom, kitchen and laundry renovations lists shower screens in the technical scope, alongside wet-area substrates, waterproofing to manufacturers specifications, and wall and floor tiling, in the Victorian registration application. We deliver bathroom renovations with in-house carpenters, plumbers, waterproofers and tilers, which reflects that coordinated sequence. Keep the guide to waterproofing compliance certificates in Victoria in the same file as the contract and the insurance. Confirm registration, the written contract and the insurance documents before a deposit or a start date, and make sure the quote states how hollow tiles, out-of-plumb walls and aged membranes are investigated before the glass is ordered.

Confirm Your Scope and Budget Before You Sign

Lock the scope before you compare prices. A headline figure without these five steps is a guess.

  1. Define the screen. Panel count, configuration and glass thickness come first. Those three choices set the glass order.
  2. Name the project type. Say whether the screen sits inside a full bathroom renovation or replaces an existing enclosure. Replacement jobs need a waterproofing contingency. New wet areas fold the screen into the build sequence.
  3. Ask for an itemised written quote. Use the glass, hardware, site, removal, silicone, waterproofing, GST, warranty and design questions so two quotes can be lined up row by row.
  4. Book a site measure. Confirm whether a waterproofing inspection is inside the price or held as a separate contingency. Phone estimates miss out-of-square walls.
  5. Match the paperwork to the value. Check the builder's registration, the contract form and domestic building insurance against the Victorian thresholds for the price of your project, not the price of the glass alone.

Free quotes and 3D drawings are offered for a bathroom renovation, and the website has a bathroom renovation calculator if you want a first pass on scope before anyone visits. Melbourne Tiling Services P/L can provide an itemised written scope covering the wet-area sequence, so you can request one quote with a site measure and compare it against that checklist. You can phone 1300 661 658.

Compare every quote line by line. The frameless shower screen installation cost that looks cheapest on the first page is often the one that left out the membrane, the make-good and the contract you need.


Melbourne Tiling Services P/L supplies and installs Australian-made frameless shower screens as part of bathroom renovations, with waterproofing, tiling and the related wet-area trades coordinated in-house. If you are pricing a Melbourne ensuite, an itemised scope with a site measure will show whether the screen, the membrane and the Victorian contract rules belong in one figure. Visit Melbourne Tiling Services P/L to request a quote and line it up against your checklist.

Bathroom Waterproofing Services: Melbourne Compliance Guide

You're comparing bathroom renovation quotes when you notice one contractor has allowed for waterproofing and another has included it under tiling. Or perhaps your tenant has sent a photo of damp carpet outside the shower, even though the tiles still look sound. In either situation, the important question isn't which membrane brand someone plans to use. It's where the waterproofing starts, where it stops, and how the installer will seal every interruption along the way.

Good bathroom waterproofing services address the whole assembly beneath the finishes. For Melbourne homeowners and landlords, a written scope and dated photographs before tiling provide something a product label can't: evidence of what was installed.

Table of Contents

What Waterproofing Must Cover in a Bathroom

Required waterproofing coverage in a bathroom

Area Required performance Reference
Shower floor with hob, step-down or level threshold Waterproof NCC 2022 Housing Provisions
Shower walls Waterproof to at least 1,800 mm above floor substrate NCC 2022 Housing Provisions
Unenclosed shower floor zone Waterproof within 1,500 mm radius of shower-rose connection Victorian wet-area guidance
Wall and floor junctions and penetrations in shower Waterproof NCC Specification 26
Timber or particleboard bathroom floor Waterproof NCC Specification 26
Concrete or fibre-cement floor outside shower Water resistant NCC wet-area requirements
Tap and spout penetrations in horizontal surfaces Waterproof NCC waterproofing and water-resistance requirements

The shower-floor requirement includes the hob or step-down, not just the flat surface where you stand. Likewise, shower-wall coverage is measured from the floor substrate, rather than from an arbitrary grout line or the top of a finished shower base. A quote that says only “waterproof shower” doesn't show whether either requirement has been allowed for.

An unenclosed shower needs particular attention because the regulated shower area extends beyond what many homeowners regard as the shower's footprint. Removing a screen or changing the shower-rose location can therefore change the membrane boundary, even when the room itself stays the same size.

Waterproof isn't the same as water resistant

Water-resistant construction tolerates wetting under the relevant requirements. Waterproof construction requires a barrier that prevents water passing into protected building elements. Tiles and grout alone shouldn't be treated as that barrier.

The substrate matters. Timber and particleboard need waterproof protection because moisture entering the floor assembly can cause swelling and damage, while suitable concrete or fibre-cement floors outside the shower can have water-resistance requirements instead. Penetrations through horizontal surfaces still need waterproof treatment.

A level-access layout also needs a deliberate transition between the shower and the rest of the room. For design context, SouthRay Kitchen & Bath's explanation of fully waterproofed bathroom layouts helps distinguish a wet-room concept from a conventional enclosed shower. The local compliance assessment must still determine the actual membrane extent.

Our waterproofing services cover interior and exterior walls and floors, including shower walls and floors, balconies and retaining walls. Those locations don't all use the same detailing, so the bathroom scope should identify its own surfaces rather than borrow a generic description.

Before comparing quotes:

  1. Measure the shower. Record the enclosure, shower-rose position and proposed threshold.
  2. Identify the substrate. Note whether the floor is concrete, fibre-cement, timber or particleboard, and flag anything still concealed.
  3. Request a marked sketch. Have the membrane boundary, wall coverage, waste and penetrations shown clearly.

Membranes, Tanking and Liquid Systems Compared

Waterproofing methods by use and trade-off

Method Typical use Main strength Main limitation
Sheet membrane Flat floors and areas needing uniform thickness Consistent thickness across flat areas Seams and corners need careful jointing
Liquid-applied membrane Showers, niches and irregular shapes Seamless and follows corners Thickness depends on coats and curing
Cementitious tanking Floors and shower bases beneath tile Compatible with suitable screeds and tile bonding Needs adequate falls and curing time

These approaches create a waterproof barrier differently. The comparison below illustrates the material types, but the installer still needs to specify a complete compatible system.

A comparison chart showing three common waterproofing materials: sheet membranes, liquid-applied membranes, and cementitious tanking systems.

Choose for the shape and substrate

Sheet membranes suit broad, relatively flat areas where a preformed layer provides consistent material thickness. Their vulnerable details are seams, corners and connections to wastes. A neatly covered floor isn't enough if the installer hasn't bonded overlaps correctly or integrated the sheet with the drain fitting.

Liquid-applied membranes suit niches, returns and irregular shower layouts because the coating follows their shape without sheet seams across the field. Their common weakness is insufficient applied thickness, particularly where a roller spreads material too thinly. Installers should check coverage and wet-film thickness against the product specification, rather than judge performance by colour alone.

Cementitious tanking uses a cement-based waterproof coating suited to compatible mineral substrates, floors and shower bases beneath tiles. Compatibility with the screed, substrate and tile adhesive is essential. Don't assume every cement-based coating can accommodate the same movement or be applied over the same background.

Think of the membrane as a raincoat. Its broad panels matter, but the seams, corners and zips decide whether you stay dry.

Compare complete systems, not buckets

A system includes more than the visible membrane. Primer, reinforcing tape, bond breakers, collars, sealants and waste connections must work together. Mixing a convenient primer with an unrelated coating can introduce uncertainty that a familiar brand name won't resolve.

For our bathroom waterproofing, we use class 4 waterproofing systems on walls and cementitious-compatible systems on floors. That describes our service approach, not a universal instruction to select a product by class name alone. The written specification must still identify suitability for the particular substrate and application.

For a tiled shower with niches, a suitable liquid-applied system is often practical because it can follow the recesses. For a flat floor over a compatible substrate, sheet or cementitious systems are common options. None is automatically the best choice in every bathroom.

Ask for the product's technical data sheet and the proposed installation sequence. The compliance pathway and manufacturer's system requirements should govern the selection, including preparation, application thickness, curing and protection before tiling.

Victorian Rules, Registered Builders and Warranties

Victorian bathroom work must meet the Building Act 1993, Building Regulations 2018 and Plumbing Regulations 2018, and the Victorian Building and Plumbing Commission's guidance on concerns about building work identifies inadequate bathroom waterproofing as non-compliance that can cause moisture problems. Waterproofing is regulated building work, not an optional improvement beneath attractive tiles.

The applicable code edition and compliance route need to be established for the project. Don't assume a standard quoted in an old renovation proposal remains the correct basis for new work.

Establish the compliance pathway

The Australian Building Codes Board's waterproofing history explains that detailed wet-area construction provisions moved out of NCC Volume Two for 2012 to 2019, then returned to the Housing Provisions in 2022, with AS 3740:2021 retained as an available Deemed-to-Satisfy pathway. This helps explain why bathroom quotes can contain different references without making their actual installation method clear.

Under the pathways described for that framework, the choices are the Housing Provisions' wet-area requirements or the Australian Standard route with the specified accompanying Housing Provisions clauses satisfied. Installers mustn't cherry-pick provisions between pathways. Wet-area membranes must also demonstrate compliance with the applicable membrane product standard.

Our guide to bathroom waterproofing standards provides additional context for discussing the specification. Before work starts, get clear answers to these questions:

  • Which pathway applies? Record the applicable code edition and compliance route.
  • Which system will be installed? Identify the membrane and associated products.
  • How will compliance be documented? Specify the records to be supplied before concealment and at handover.

Inspection should assess the assembly, not just the finished surface.

A professional building inspector wearing a safety vest checks moisture levels in a tiled bathroom wall.

Put coordination and warranty terms in writing

Registered builders coordinating bathroom renovations can manage the handovers between substrate installation, plumbing, waterproofing and tiling. The contract should identify who is responsible for checking those interfaces, rather than leave each trade assuming someone else has inspected them.

At Melbourne Tiling Services P/L, we operate as Registered Unlimited Builders, and our bathroom renovations are delivered with in-house carpenters, plumbers, waterproofers and tilers. All our workers are qualified and certified waterproofers or tilers. That coordination matters when a plumbing change affects a wall lining or a shower-screen fixing intersects waterproofing.

Our waterproofing work comes with extended warranties. Confirm the written term, covered work, exclusions, claim procedure and whether coverage transfers to a subsequent owner or applies when the property is tenanted; don't infer those conditions from the word “extended”.

Keep the written scope, compliance pathway, dated photographs, product details and warranty certificate together. If a leak appears, distinguish maintenance issues from possible installation defects before accepting responsibility. Notify the builder promptly about suspected defective work, and have the cause assessed rather than assuming every leak is either automatically a warranty claim or automatically the owner's expense.

Pre-Tile Checks That Prevent Hidden Leaks

The most useful inspection happens before the tiles conceal the work. A finished bathroom can look carefully built while hiding an incomplete drain connection, an untreated penetration or a membrane applied over a weak base.

Arrange a hold point in the programme so the waterproofing can be checked before tiling proceeds. The owner, landlord or builder should retain the resulting photographs and written log, rather than rely on images remaining on a tradesperson's phone.

Follow the installation sequence

  1. Confirm a sound substrate. Check that sheets are securely fixed, joints are prepared, surfaces are clean and the background suits the selected membrane, because movement or loose material can undermine the barrier. Our explanation of substrate preparation helps identify what needs resolving before coating begins.

  2. Check falls towards the waste. Use a straightedge and level to identify backfall or low spots, because a waterproof surface can still retain water when the drainage geometry is wrong. Include the niche shelf and any other horizontal ledges in this assessment.

  3. Verify primer, membrane build-up and curing. Record the products used and confirm that all specified layers have been applied under suitable conditions, because a thin or incompletely cured coating isn't equivalent to the tested system. Photograph product labels and retain application records alongside the site images.

  4. Inspect continuous junction treatment. Check corners, wall-floor junctions and bond-breaker details before they disappear beneath subsequent work, because the system must accommodate these changes of plane without an unprotected gap.

  5. Examine penetrations and the threshold. Confirm treatment around pipes, tap fixtures, wastes and the doorway waterstop, because these interruptions need integration with the surrounding barrier. Photograph the threshold separately so its position and termination remain identifiable.

  6. Measure the installed extent. The ABCB's waterproofing guidance specifies shower-wall waterproofing to at least 1,800 mm above the floor substrate for the stated shower configurations; photograph a tape measure against the installation and check the unenclosed shower boundary against the approved scope.

Make the photographs useful

Take an overall room photograph, then closer views showing each critical detail in context. Label the images by location and stage, and record the date, installer, product and any corrective work. A close-up without a recognisable location can be difficult to interpret later.

Practical rule: Photograph the detail while someone can still fix it without removing tiles.

Where stone flooring and underfloor heating are planned, coordinate the heating build-up before waterproofing starts. Varun Marbles' underfloor heating tips for stone bathrooms offer useful design context, but the membrane and heating manufacturers must determine the compatible layer sequence.

A later leak may originate at one of these concealed stages rather than at the visible tile surface. These records won't diagnose every defect, but they give an investigating specialist a much stronger starting point than a photograph of finished grout.

Leak Symptoms, Repair Scope and When to Call a Specialist

A leak rarely announces where it started. Water travels along joists, pipe runs and screed falls, so a stain can appear well away from the defect that caused it.

Leak symptoms and the right next action

Situation Likely scope Specialist needed
Damp grout lines with no staining behind tiles Regrout and reseal joints, then monitor Optional, if damp returns
Water seeping through the shower threshold Check threshold detail and membrane height Yes
Damp patch on ceiling below the bathroom Trace the source through the floor and plumbing Yes, before any patching
Hollow or lifting tiles across the shower floor Tile removal and membrane reinstatement if failure is confirmed Yes
Soft or swollen timber subfloor Membrane assessment and subfloor repair Yes

Treat this table as a starting point for investigation. Identical-looking stains can come from a plumbing joint, a threshold defect or water that has tracked across from another part of the room.

Notice where the higher-stakes rows sit. Failures cluster at junctions, thresholds and penetrations, where the membrane meets a drain, a doorway or a pipe, rather than across the open field of a wall or floor. A symptom's location tells an investigator more than its size.

Surface grout deterioration may justify local maintenance when there's no evidence of concealed damage. The absence of visible staining, though, doesn't prove that everything behind the tiles is dry. If damp returns after maintenance, stop repeating the same treatment and investigate.

When a patch isn't enough

Water at a threshold deserves attention because the fault may sit below the visible sealant joint. A fresh silicone bead over a leaking threshold works like repainting a damp wall: the surface looks better while the moisture keeps travelling underneath. Hollow tiles also need interpretation. They can signal a bonding problem while the membrane remains intact, so the removal scope should follow assessment rather than precede it.

For a ceiling stain, a plumber may need to rule out supply or waste leakage before a waterproofer opens the tiled assembly. The leak advice from Jays Plumbing and Sewer provides useful homeowner context for that situation. If the ceiling is sagging or water is near electrical fittings, keep clear and arrange urgent professional assistance.

Our bathroom waterproofing repair services cover shower-leak rectification and related tiling, carried out by qualified and certified waterproofers and tilers. Some concealed defects can't be confirmed until tiles and damaged materials are removed, so an initial assessment may need a staged investigation allowance. Ask what each stage will establish before work begins.

Compare repair costs on equal terms

In 2025, Sparky's Australian bathroom waterproofing pricing reported typical amounts of AUD 1,100 for a professional owner-managed renovation and AUD 1,400 as an itemised tiling-quote amount. These figures describe broader bathroom work, so treat them as references rather than leak-repair prices. Check whether demolition, substrate replacement, plumbing, screeding and retiling are included before comparing quotes.

A repair quoted cheaply because it skips demolition and substrate inspection can cost more in the end than a thorough job priced correctly the first time. Paying for a clear diagnosis helps avoid an ineffective patch and poorly planned destructive work.

Confirm a Written Waterproofing Scope Before You Book

Before accepting a quote, require a written waterproofing scope that identifies the shower dimensions, membrane boundary, waterproofing method, compliance pathway, warranty term and pre-tile photographic records. Compare its coverage with the bathroom's actual surfaces, substrate and shower configuration, not merely the total price.

Bring a clear shower photograph, the bathroom's approximate age, details of any leaks and their locations, and whatever you know about the floor construction. If you don't know whether the concealed subfloor is timber or particleboard, mark it as unconfirmed rather than guess.

Resolve the unknowns before signing

  • Coverage: Have every shower surface, junction, penetration and threshold identified on a sketch.
  • Concealed conditions: Record what requires inspection after demolition and how additional work will be agreed.
  • Handover: Specify the product records, photographs and warranty documents you'll receive.

Melbourne Tiling Services P/L provides bathroom renovations, tiling and waterproofing, with free renovation quotes and 3D drawings. Our design process includes sketches, plans and discussions, with modifications agreed before work commences.

Use that planning stage to settle the membrane boundary and responsibilities before comparing prices. Don't accept a verbal assurance in place of a defined installation scope.

No written scope, no booking.


Melbourne Tiling Services P/L offers bathroom renovations, waterproofing, tiling and shower-leak repairs, with coordinated trades for the work beneath and above the tiles. Visit Melbourne Tiling Services P/L to arrange a free quote, and bring your shower photos, floor details and leak locations so you can discuss a written scope before booking.

Bathroom Renovation Ideas Small Space: 8 Smart Fixes

You're standing in a 1.5 m wide bathroom where the door swings into the vanity, the toilet crowds the basin, and small tiles break every wall into a busy grid. You can't move the walls, the waste pipe is where it is, and every fixture you add takes circulation space from somewhere else. That's the normal starting point for bathroom renovation ideas in a small space, not a showroom with room to waste.

The national housing mix explains why this matters so often. The Australian Bureau of Statistics 2021 Census QuickStats recorded 1,319,095 occupied flats or apartments, representing 14.2% of occupied private dwellings. One and two bedroom homes together made up a large share of that stock, so compact ensuites and shared family bathrooms have to work hard without feeling cramped.

The eight fixes below free floor area, cut visual clutter, and reduce cleaning time. Each one is sequenced around the trades that decide whether it lasts, because framing, waterproofing, falls, and electrical positions are cheap to change on paper and expensive to change after lining. If you want more layout inspiration to make a small bathroom feel bigger, use it for looks, then check every idea against the build sequence here.

Table of Contents

1. Frameless Walk-In Shower with Linear Drain

A frameless walk-in shower works in a small bathroom when the drain, falls and glass line are settled before the walls are lined. One fixed panel keeps the floor plane continuous, so the room reads as a single surface instead of a tray boxed into the corner.

A modern, minimalist bathroom featuring an open walk-in shower with large beige tiles, a vanity, and a toilet.

Take a 2 m² ensuite where a corner tray steals the only useful corner. A wall-to-wall frameless screen with a linear drain along the back wall gives a longer shower zone, no door swing, and one fall direction for larger tiles. The same move suits a rental apartment if the waterproofing is certified and documented for the owner.

The Sequence That Prevents Leaks

The plumber sets the drain position and fall first, the waterproofer membranes to AS 3740, then the tiler screeds and lays toward that drain. Reverse that order and you get ponding at the glass line, cut tiles that fight the fall, and a screen installed over a problem. Open showers also widen the wet zone. Guidance from the Building and Plumbing Commission on waterproofing wet areas notes an unenclosed shower requires waterproofing within a 1,500 mm horizontal radius of the shower rose, plus a floor waste and waterstop.

That makes a fully open shower less economical than it looks in a tiny room. I recommend a fixed frameless panel long enough to control splash, because it protects the vanity and toilet roll while leaving the entry open. For upkeep, choose a grate you can lift without tools; if local water leaves mineral film on glass, you can reduce shower scale with softened water and avoid harsh scrubbing at the grate.

Watch how the screen, drain, and tile set-out need to align before glass is ordered.

  • Confirm the certificate: Ask your registered builder for the waterproofing certificate and membrane extent before tiling starts.
  • Lock the drain early: Its position drives screed falls, tile cuts, and grate access.
  • Itemise the quote: Waterproofing, screeding, and frameless screen installation should be separate lines.
  • Template the glass: The supplier should measure after tiling, not from the framing plan.

2. Wall-Hung Vanity with Recessed Storage

A floor standing vanity in a narrow room does two unhelpful things. It hides the floor, which makes the room read smaller, and it creates two dusty corners you can't mop properly. A wall-hung vanity fixes both, but only if the wall behind it is built to carry it.

A modern, minimalist bathroom with a floating vanity and wall-mounted toilet to maximize available floor space.

In a 1.5 m wide family bathroom, swapping a bulky floor unit for a floating two drawer vanity and a recessed shelf niche frees toe space and gives daily items a home off the benchtop. In a powder room, go slimmer again with a wall-hung basin and a tall recessed cabinet beside it, so storage goes vertical instead of into the walkway.

What Has to Happen Inside the Wall

The carpenter installs noggins or a reinforced mounting frame at the correct height before sheeting. The plumber roughs supply and waste into the wall so drawers clear the trap, usually with a space saver trap and cut-out top drawer. If you order the vanity before checking stud positions and pipe centres, you'll either patch tiles or accept drawers that don't close.

Practical rule: Choose the vanity, tapware, and waste as one set, then frame and rough-in to those exact dimensions.

Measure drawer projection against the door swing and the space beside the toilet. A deep vanity looks generous in a catalogue and then blocks knees or the shower screen in real life. Specify whether the unit mounts over finished tile or tiles in around it, because that changes set-out, silicone joints, and how easily the unit can be removed later for leak repairs.

3. Large-Format Porcelain Tiling to Reduce Grout Lines

Small tiles mean hundreds of grout joints, and grout is what dates, stains, and makes a compact room look busy. Large-format porcelain, including Kerlite style slabs, reduces those joints and lets one surface run from floor into the shower without constant visual breaks.

Take a 3 m² ensuite finished in 1200 x 600 mm tiles across the floor and main walls. With rectified edges and narrow joints, the room reads calmer and cleaning drops to wiping flat porcelain instead of scrubbing a grid. The same logic applies outside, where large pavers after leak rectification need the membrane and substrate fixed before anyone talks about finish.

Flatness Decides the Result

Large tiles don't hide a bad substrate, they highlight it. The screeder or tiler needs to screed or self-level first, check with a straightedge, and confirm movement joints and adhesive coverage for that specific product. Back-buttering, levelling clips, and correct trowel size aren't optional extras at this format, they're how you avoid lippage and hollow spots that crack under point loads.

Plan the set-out dry on site before adhesive is mixed. Centre cuts so you don't end up with a sliver at the shower drain or vanity edge, and align wall and floor joints where the format allows it. For product selection, handling, and substrate tolerances, our large-format tile installation service covers Kerlite and large porcelain for interior and exterior work.

There's a trade-off on the shower floor. Very large tiles need a single-direction fall to a linear drain, because they can't fold to a centre waste. If you're keeping a centre waste, use a smaller format or envelope cuts in the shower zone and keep the large format for the main floor and walls.

4. Recessed Niches and Built-In Shelving

Bottles on the shower floor and caddies hanging off the rose are signs the room was tiled before anyone thought about storage. A recessed niche uses wall thickness you already have, so shampoo sits flush instead of projecting into elbow space.

A modern shower featuring gray stone tiles, a built-in recessed storage niche, and stainless steel fixtures.

A full-width niche in the shower wall, finished in the same large-format tile, holds everything for two people without a shelf to bump. Outside the shower, a 600 mm recessed shelf above the toilet takes towels and spare rolls where a cabinet would feel too deep. Both work because they're planned at framing stage, not cut in as an afterthought.

Checks Before Anyone Cuts

  • Scan the wall first: The plumber and electrician confirm no pipes, cables, or studs sit where the niche is marked.
  • Slope the base: A flat niche base holds water and grows mould at the silicone line, so specify a slight fall to the face.
  • Set height to the tile: Align niche edges with grout joints so you don't get thin, weak tile slivers around the opening.
  • Membrane the whole box: Waterproofing wraps inside the niche and beyond its edges as AS 3740 requires, with corner reinforcement.

Height matters more than size. Put the niche where a raised arm reaches naturally, clear of the shower rose spray hitting bottles, and confirm it on the 3D drawing with your tallest shampoo bottle in mind. Our shower niche installation work is framed, waterproofed, and tiled as one sequence, which is exactly how it should be quoted.

5. Wall-Hung Toilet with Concealed Cistern

A close-coupled toilet projects a long way from the wall and leaves a dust trap behind the pan that nobody cleans well. A wall-hung pan with in-wall cistern shortens that projection, lifts the bowl off the floor, and lets you mop straight underneath.

In a 1.2 m wide bathroom, that reclaimed floor strip is the difference between knees touching the vanity and sitting comfortably. For an investment property, the gain is maintenance. Tenants and cleaners can clean around the pan quickly, and there are no external cistern seals perishing in view.

Framing Depth Is the Decision

The steel frame and cistern need wall depth, so the registered builder confirms the frame model and depth before framing, not after sheeting. If the existing wall is too shallow, you either build a boxed nib wall, which can double as a shelf, or you choose a back-to-wall suite instead. Pretending it will fit is how walls get reopened.

Access is not optional. If the flush plate doesn't give full access to the inlet valve and flush mechanism, the first repair means cutting tiles.

Position the flush plate where it doesn't clash with a towel rail or niche, and check pan height with the finished floor level, including screed and tile build-up. Water efficiency is worth checking at the same time. The federal YourHome guide to reducing water use states a WELS 5-star efficient showerhead can use as little as 4.5 litres per minute compared with an inefficient shower at 15 to 25 litres per minute, which is why pairing a dual-flush suite with efficient tapware cuts running costs without using any extra space.

6. Outward-Opening or Cavity Sliding Door

Door swing is wasted floor area you pay for every day. In a small ensuite, an inward door often dictates where the vanity can't go, which then forces the toilet and shower into worse positions.

Changing a 2 m² ensuite from an inward swing to a cavity slider can free enough wall for a proper wall-hung vanity instead of a pedestal basin. Where the wall can't take a cavity, an outward-opening door achieves most of the gain, and you can still use the back of it for hooks. For hardware types and fitting sequence, Neasden Hardware's sliding door guide is a useful reference before you order a system.

Clearances to Verify on the Plan

The Australian Building Codes Board Livable Housing Design Standard specifies an 820 mm minimum clear opening for internal doorways and a 1,200 mm by 900 mm clear circulation zone in front of the pan. Dimension those from finished walls, because tile and waterproofing build-up shrink the room you get.

A cavity slider needs a wall deep enough for the pocket, plus no pipes or wiring in that pocket. That rules it out on many plumbing walls, so the carpenter and plumber need to agree the wall build-up early. Specify soft-close, quality rollers and guides for a high-use bathroom, because cheap cavity hardware rattles, jumps the track, and can't be replaced without opening the wall. Also check the hallway side for an outward door, so you don't solve a bathroom clash by creating a corridor one.

7. Full-Height Mirror with Integrated Lighting

A small mirror over a small basin makes a windowless bathroom feel like a cupboard. A wall to wall or full-height mirror reflects the longest view in the room and doubles the effect of whatever light you install, without taking a millimetre of floor space.

A modern bathroom vanity with a lighted mirror, wooden cabinets, and marble countertop in a small space.

Say a compact ensuite has no window and one downlight over the shower. A 1.8 m high mirror across the vanity wall with LED strips at face height gives even light for shaving and makeup, instead of shadows from a single ceiling point. Recessing a mirrored cabinet into the same wall adds storage for medicines and electric toothbrushes while keeping the face flush.

Electrical Work Comes Before Lining

The electrician runs circuits, drivers, and switching before walls are sheeted, and confirms IP ratings for fittings in wet area zones. That includes power for a heated demister pad and a shaver point inside the cabinet if you want one. Retrofitting those after tiling means surface conduit or pulling tiles off, neither of which you'll accept.

Plan mirror width against tap height so the spout doesn't foul the cabinet doors, and leave a tiled splashback zone below the mirror edge where water lands. Pair it with an exhaust fan sized for the room and ducted outside. A beautiful mirror that fogs for twenty minutes after every shower is a ventilation problem, not a mirror problem, so I recommend a demister pad plus proper extraction rather than either one alone.

8. Level-Entry Floor with Underfloor Heating

A hallway tile that runs through the doorway and straight into the shower, with no hob and no step, makes a small room read as one continuous surface. It also removes the trip point for a pram, a walker, or a wheelchair down the track.

Electric underfloor heating earns its place the same way, by freeing space: under large-format tiles it replaces a wall heater that would steal towel space, and it dries the floor faster after showers so grout stays cleaner. The catch is sequencing. On timber floors the carpenter may need to drop the shower base substrate so the screed can fall to the waste without a step, and that call is made at framing stage, before the heating cable is ordered.

Heights, Falls, and Heating Order

Level entry comes from falls built into the screed while the finished surface still reads flat, so existing floor heights, door clearances and waste depths are measured before screeding starts. Get them wrong and the door stops clearing the floor, or the tile finishes above the hallway and the step returns. The NCC Housing Provisions on wet area waterproofing require shower walls to be waterproof to at least 1,800 mm above the floor substrate, with the shower floor and junctions waterproof as well. In a compact room those splash zones overlap the doorway and vanity wall, so the membrane and falls plan get drawn together at planning stage.

Once the screed is cured, the heating goes down to a marked plan, and a self-levelling compound for underfloor heating laid over the cables gives the tiler a flat, stable bed that protects the heating element and the adhesive bond.

  • Screed and level first: Request a levelling inspection before heating mats or tiles go down.
  • Lay heating to a plan: Cables avoid toilet fixings, vanity waste zones and door stops, and the licensed electrician tests resistance before and after tiling.
  • Protect the sensor: The thermostat probe sits in a conduit so it can be replaced without lifting tiles.
  • Program the thermostat: Timed morning heating gives comfort without running all day.

How the 8 small bathroom renovation ideas compare

Item Space Gained Installation Complexity Best For Main Trade-off
Frameless Walk-In Shower with Linear Drain Makes the room feel more open High; requires precise waterproofing, floor falls, and glass measurements Compact bathrooms needing a spacious, easy-to-clean shower Higher upfront cost and costly installation errors
Wall-Hung Vanity with Recessed Storage Opens up visible floor area Moderate to high; needs structural backing and possibly relocated plumbing Small bathrooms needing a lighter look and easier floor cleaning Less storage depth and possible plumbing costs
Large-Format Porcelain Tiling to Reduce Grout Lines Creates a more continuous, spacious appearance High; requires a flat substrate and experienced handling Small bathrooms seeking fewer grout lines and a clean finish Precise preparation and specialist installation add cost
Recessed Niches and Built-In Shelving Adds storage without using floor space Moderate; must be planned around wall services and waterproofing Showers or bathrooms needing tidy, built-in storage Limited depth and must be planned before wall lining
Wall-Hung Toilet with Concealed Cistern Frees floor area beneath the toilet High; requires in-wall framing and plumbing planned in advance Compact bathrooms prioritising open floors and easier cleaning Higher installation cost and concealed cistern access for repairs
Outward-Opening or Cavity Sliding Door Reclaims floor space otherwise used by the door swing Moderate to high; cavity sliders need suitable wall depth and framing Bathrooms where door clearance limits movement or fixture placement Cavity sliders need structural work; outward doors may obstruct hallways
Full-Height Mirror with Integrated Lighting Makes the room feel brighter and larger Moderate; requires secure mounting and suitable electrical work Small or windowless bathrooms needing more light and optional storage Added cost, careful handling, and potential water spots
Level-Entry Floor with Underfloor Heating Creates a seamless entry and frees wall space from heaters High; requires coordinated floor preparation, waterproofing, and heating installation Bathrooms needing step-free access and comfortable warmth Added floor height, installation coordination, and possible running costs

Turning These Ideas Into a Bathroom That Works

Start with what you can't change cheaply later. Drain position, framing depth, waterproofing extent, and electrical points lock in almost every idea on this list. A wall-hung toilet, recessed niche, cavity slider, and heated level-entry floor are all framing and rough-in decisions, so they belong on the first plan, not on a shopping list after demolition of appliances, fittings, shower screens, wall tiles, floor tiles, and substrate sheeting.

Budget for that hidden work. Recent Australian renovation reporting in the Buildmat summary of Australian renovation costs puts the median bathroom renovation cost at approximately $30,000, with a previously cited average around $21,000. That's not a Melbourne quote, but it proves the point that small doesn't mean cheap, because demolition, waterproofing, substrate correction, and service relocation cost money regardless of floor area. Retaining plumbing positions and standard tile sizes are relatively safe savings. Cutting membrane detailing, falls to waste, or leak testing is not.

Check who is responsible for coordinating your bathroom renovations and registered builders before you sign anything. Consumer Affairs Victoria guidance on builders and tradespeople states a domestic builder must be registered for a domestic building contract worth more than $10,000, while single trade exemptions don't cover someone coordinating the whole job. Separate Consumer Affairs Victoria guidance on implied warranties and domestic building insurance states domestic building insurance is required for work over $16,000, and implied warranties apply regardless of cost. Verify registration, insurance, scope, and completion terms in writing, and confirm current Victorian requirements with your building surveyor before construction, since code adoption dates change.

We've specialised in bathroom renovations since 2003 and deliver work with in-house carpenters, plumbers, waterproofers, and tilers, so framing for niches and cisterns, outlet changes, rewiring, and stud walls are sequenced by one team. Design starts with sketches, plans, and discussion, and modifications are agreed before work commences. You can request free quotes and 3D drawings, and use our bathroom renovation calculator to test scope and budget, noting the full renovation scope listed is offered for a median price of $10,000. Choose two or three ideas that solve your worst daily friction first, usually the door, the shower, and storage, then let finishes follow the structure. That's how a compact bathroom ends up feeling bigger because it works better.


If you're planning a compact bathroom or ensuite in Melbourne, Melbourne Tiling Services P/L can coordinate the registered builder, waterproofing, screeding, tiling, and frameless shower screen as one sequenced project. Request a free quote with 3D drawings and use the renovation calculator to confirm your layout, falls, and framing decisions before demolition starts.

Leaking Shower Screen: How to Find and Fix It

You step out of the shower, spot a puddle beside the screen and reach for the silicone. That may be the right fix, but water on the floor doesn't prove the glass or seal is the cause. A leaking shower screen is part of a wet-area system: the door and frame, the threshold, the floor falls, the waterstop and the concealed waterproofing all affect where water goes.

Start by locating the first place water escapes. A worn door sweep is usually a manageable repair. Water spreading beyond the shower, returning after resealing or showing up on a ceiling below calls for a broader investigation. The distinction matters: a cosmetic patch can stop a visible drip while moisture continues behind tiles or into an adjoining room.

Table of Contents

Match Your Leak to Its Most Likely Cause

A drip at the bottom door sweep is a common first clue. The seal may be worn or missing, or the door may sit out of alignment so the sweep no longer meets the threshold evenly. The location helps narrow the first check, but it doesn't prove the underlying cause.

Where water appears Likely cause First action
Bottom door sweep or bottom rail Worn or missing bottom seal, or door out of alignment Replace the sweep and check door alignment
Vertical join where glass meets wall Failed silicone at the glass-to-wall junction Clean, dry and re-seal the compatible joint
Floor outside the screen Incorrect threshold, missing waterstop or poor falls Stop DIY repairs and arrange a waterproofing check
Ceiling or wall of the room below Concealed membrane or penetration failure Stop DIY repairs and book a licensed inspection
Only when the shower runs hard Shower head angled into the screen Re-angle the head and check the drainage slots
Screen rocks or fixings are loose Loose frame fixings or movement Tighten fixings, then re-test before sealing

Use the table as a starting point, not a diagnosis. Water can run along a frame or tile before it reaches the floor, so the puddle's position may not match the actual escape point. For a broader overview of how household leaks can start and travel through a property, see this guide to understanding sources of household water leaks.

Limit damage while you investigate

If the leak is small and contained, wipe up water after each shower, dry the floor and place an absorbent mat at the threshold. Keep the door closed so spray stays inside the enclosure, and avoid using the shower if water is reaching adjoining rooms or the level below.

A loose screen needs attention before you apply sealant. Movement can reopen a fresh joint, and a wobbly frame can put stress on the glass. Tighten only accessible fixings that can be secured safely. If the frame still moves, or the glass is cracked, leave the adjustment to a glazier or installer.

Tell Whether the Screen or the Wet Area Is at Fault

The deciding question is whether water escapes only at the screen, or whether it continues into the surrounding wet area. If it appears just beyond a door edge, the sweep, alignment or a compatible screen joint may be at fault. If it spreads under the bathroom floor, passes the shower perimeter or shows up in the room below, the threshold, waterstop or waterproofing needs investigation.

The NCC 2025 wet-area waterproofing provisions require shower walls to be waterproof to at least 1,800 mm above the floor substrate, with waterproofing at wall junctions, wall–floor junctions and penetrations. For a hobless shower, the provisions also require a perimeter waterstop and a screen that incorporates or sits on an inverted channel positioned over it. Those details matter because water can pass behind tiles even when the visible screen edge looks intact.

A professional builder inspects a shower screen base, checking for potential water leakage points in a bathroom.

Use the repeat leak as a warning

Say a screen has been re-sealed twice, but the leak returns and a stain appears on the kitchen ceiling below the bathroom. The next step isn't a third bead of silicone. Water may be travelling through a failed junction, penetration or membrane before it becomes visible in the kitchen, so the leak needs a waterproofing investigation. A guide to detect hidden bathroom water leaks can help you recognise why the visible wet spot may be some distance from the source.

A surface leak that stops after a properly prepared, dry reseal is consistent with a maintenance issue. A leak that persists, moves beyond the screen or appears below the bathroom is a reason to investigate the wet area, including the shower waterproofing membrane.

Keep this rule: A visible gap isn't always the cause. Repeated caulking can hide a leak that keeps moving.

How to Run a Controlled Spray Test

A controlled spray test helps separate a screen leak from water escaping elsewhere in the shower. The essential technique is to test one zone at a time. If water from the shower rose reaches the floor or waste during the first test, you won't know whether the screen itself leaked.

A five-step infographic illustration demonstrating how to perform a controlled spray test to identify a leaking shower screen.

  1. Dry the bathroom and floor for at least an hour. Use towels and ventilation to remove existing moisture, or an old wet patch may look like fresh leakage.

  2. Mark the screen-to-wall, screen-to-floor and door-jamb junctions with painter's tape. These reference lines make it easier to see where water crosses the enclosure.

  3. Spray only the glass and frame for five minutes. Keep the shower rose and floor waste dry so water from the main shower area doesn't confuse the result.

  4. Test the door sweep, bottom rail and wall junction separately. Direct water at one zone at a time, then check the marked lines and photograph the first visible escape point.

  5. Inspect adjoining surfaces after the test. Check the skirting, the room below and the ceiling after twenty minutes, and record where you see fresh moisture.

Read the result, not just the puddle

If water escapes while you're spraying the glass or frame and the rest of the shower is isolated, the screen or its junctions are the likely source. If leakage continues after the screen test, investigate floor falls, the waste, penetrations, wall–floor junctions and waterproofing. For an unenclosed shower, Victorian guidance measures the shower area using a 1,500 mm horizontal radius from the shower-rose connection, so the area that needs assessment may extend farther than expected. The Australian Building Codes Board's waterproofing guidance explains why the screen, waterstop and membrane need to be considered as separate parts of the system.

The slip that ruins this test is spraying every surface at once. You'll wet the whole shower but learn very little about the escape point. If the result points to concealed plumbing rather than the screen, guidance on how professionals find hidden plumbing leaks can help explain the next stage of investigation.

A clean result is straightforward: no water crosses the marked lines, and adjoining surfaces stay dry.

How to Re-seal, Adjust or Replace the Screen Seals

Once a controlled test points to the screen, work from the simplest screen fault to the more involved adjustment. Don't remove a panel unless you need the access, and don't start sealing until you've checked whether the frame moves or the drainage path is blocked.

  1. Remove the door or panel only if access requires it. Label each fixing as you remove it so it goes back in the same position.

  2. Inspect the frame fixings, packers, drainage slots, glass clearance and door alignment. Check the bottom seal for lifting, cracking or a poor fit. If the glass has cracked or shifted, stop and call a glazier rather than trying to adjust it yourself.

  3. Check that no fixing has breached the waterproof layer. A screw through the hob or floor can create a leak path. Don't drill into either without a documented waterproofing detail; if you suspect a fixing has pierced the membrane, get a licensed trade to assess it.

  4. Remove failed silicone and prepare the joint. Cut out the old material rather than covering its surface. The substrate must be smooth, clean, dry and free of dust, residue and loose material before new sealant goes on.

  5. Fit the correct seal or reseal a compatible joint. Replace a worn bottom or vertical seal with a profile that fits the screen. Use sealant only on a dry, clean joint. Grout or silicone can finish a joint, but neither replaces a membrane where waterproofing continuity is needed.

  6. Refit the panel without blocking drainage. Keep manufacturer drainage slots clear. Sealing the outside edge of a frame can trap water inside, so don't close off a drainage path to make the outside look neater.

  7. Document the repair and check it again. Record pass or fail for each test zone, take photographs, note moisture readings and write down the exact repair scope.

Australian guidance on shower-screen rectification and waterproofing details sets out why the screen must align with the hob, waterstop or inverted channel, and why blocking drainage or relying on surface sealant can leave the underlying fault in place. A hobless shower needs the screen to use or sit over an inverted channel positioned over the waterstop; on a hob shower, the screen should be flush with or overhang towards the shower side.

If a substrate feels soft or looks swollen, stop work and call a licensed trade. It may need to be exposed and tested rather than covered with fresh silicone. Where the screen itself needs replacement or refitting, semi-frameless shower screen installation is a different scope from a seal change, particularly if fixings or the surrounding wet area need attention.

What Each Repair Costs and How Long It Takes

A leaking shower screen can need a simple seal change, but the visible gap may not be the source. Costs rise when the frame needs adjusting, glass needs replacing or the wet area needs investigation. These are indicative Melbourne planning ranges in AUD. Get a written quote that defines the work before it starts.

Repair Usually done by Indicative cost Typical timeframe
Replace bottom door sweep or seal Homeowner or handyman Seal cost depends on the replacement profile About 1 hour
Re-seal silicone joints, DIY Homeowner $15–$40 for sealant 1–2 hours, then 24 hours curing
Professional re-seal of screen joints Licensed tiler or plumber Written quote after inspection Half a day
Adjust or re-pack frame and hinges Glazier or installer $100–$300 1–2 hours
Replace a glass panel Glazier $400–$1,200 1–3 days, including measure and fit
Waterproofing investigation and rectification Registered waterproofer or builder Inspection first, then a fixed scope Several days, depending on scope

DIY silicone work takes one to two hours, followed by 24 hours to cure before using the shower. A professional reseal usually takes half a day. Glass replacement takes longer than fitting alone because the panel needs measuring and ordering. Waterproofing work has no reliable price until the leak source and repair scope are established.

A low-cost screen repair will not solve a leak coming from behind the glass. If water has reached cabinetry or plasterboard, repairs to those surfaces can add to the total. For a clearer breakdown of likely charges, see this guide to shower leak repair costs.

Compare quotes by what they include, not just the total. Check whether inspection, removal, replacement materials and making good affected surfaces are covered, and whether the proposed repair addresses the suspected source rather than only the visible gap.

When to Call a Registered Builder or Escalate a Rental Repair

DIY stops being sensible when water has moved beyond an accessible screen joint. Arrange a professional inspection if:

  • the leak returns after one dry reseal;
  • water appears in an adjoining wall, below the bathroom or beneath the floor;
  • the substrate is soft or swollen;
  • the glass or frame moves; or
  • the repair involves waterproofing behind tiles.

For bathroom renovations or more extensive leak rectification, check who is responsible for each part of the work. In Victoria, domestic building work with a contract worth more than $10,000 requires registration with the Building and Plumbing Commission, according to Consumer Affairs Victoria's guidance on registered building practitioners. Check the practitioner's registration and ask which trades will carry out the plumbing and waterproofing work.

Renters and property managers

A tenant should notify the agent or rental provider in writing as soon as the leak is identified. Send dated photos or video, record when the leak happens and ask them to investigate the cause, not just re-silicone the screen. That record helps distinguish ordinary deterioration or defective installation from damage caused by a renter.

Consumer Affairs Victoria says rental providers must arrange urgent repairs immediately and non-urgent repairs within 14 days of receiving a written request. If an urgent repair isn't addressed, a renter may organise and pay for it up to $2,500 and seek reimbursement, subject to the applicable conditions. The Victorian rental repairs guidance sets out the process and conditions. Don't authorise invasive work without following the relevant process, especially when responsibility for the leak hasn't been established.

Apartment owners and property managers should check whether the owners corporation needs to be involved before work begins. A leak that affects a neighbouring unit or shared building element may need coordinated access and repair records.

Confirm the Repair Scope Before You Book

Before signing off on work, make sure the quote answers these questions:

  • Which leak zone did the spray test confirm?
  • Which joints, seals or wet-area components will the repair address?
  • Does the scope include making good damaged tiles, plasterboard or cabinetry?
  • What warranty applies to any waterproofing work?
  • Can the work be quoted in stages, with an inspection followed by a fixed repair scope?

A screen repair and a bathroom renovation aren't the same job. When work extends behind the tiles, coordination between carpentry, plumbing, waterproofing and tiling helps keep responsibility clear. Melbourne Tiling Services P/L delivers bathroom renovations with in-house carpenters, plumbers, waterproofers and tilers, and its waterproofing work comes with extended warranties. Phone 1300 661 658 with your photos, the zones you tested, the date the leak started and any previous repair invoices to discuss the scope.

Your next step is to book an inspection before ordering new glass or silicone.


Melbourne Tiling Services P/L offers shower leak rectification, waterproofing and coordinated bathroom renovations, so the repair can address the wet-area system as well as the visible screen. Share your spray-test results and photos, then visit Melbourne Tiling Services P/L to arrange a scope conversation.

Self Levelling Compound How Long to Dry: Melbourne Guide

Most rapid self-levelling compounds are walkable in about 2 to 4 hours and ready for ceramic or porcelain tile in about 4 to 6 hours, while carpet takes 16 to 24 hours, direct-stick vinyl 24 to 48 hours and timber up to 72 hours, with full strength assessed at 28 days. Name your floor finish first, because that finish sets the waiting period.

The popular advice to leave it overnight is too blunt for bathroom renovations. A floor can feel hard enough to cross while still being unsuitable for a membrane or moisture-sensitive adhesive. In Melbourne bathrooms and balconies, the existing slab can dictate the handover date more than the fresh compound does.

Table of Contents

Walkable, Tile-Ready and Fully Cured Times at a Glance

Self levelling compound has no single drying time. Initial set, safe access, covering readiness and strength development are separate milestones, and a tiler needs to know which milestone the next trade requires.

Self levelling compound drying and curing stages

Stage Typical time What it means Applies to
Initial set About 1 to 3 hours Surface begins to firm; not safe to walk on Process check only
Light foot traffic About 2 to 4 hours Walkable in socks or soft shoes when permitted; not proof of dryness Access for other trades
Ceramic, porcelain or stone tile About 4 to 6 hours for many rapid products; 5 to 6 hours for some Tile can be bonded once the product window is met Bathroom and balcony tiling, with an approved system
Carpet or floating floor About 16 to 24 hours Product has reached its stated covering window; adhered carpet also needs adhesive approval Bedrooms and living areas
Direct-stick vinyl About 24 to 48 hours Surface and slab must meet the covering manufacturer's moisture limit Laundries and some bathrooms
Direct-stick timber or parquetry About 48 to 72 hours Moisture-sensitive; requires confirmed substrate moisture Timber floors
Waterproofing membrane About 24 hours, with residual moisture below 2 per cent for the referenced rapid screed Substrate must be stable and within the membrane system's limit Wet areas and balconies
Full strength At least 35 MPa at 28 days for the referenced strength-development example Specified strength benchmark, not a universal drying certificate Heavy loads and long-term performance

The setting, access and strength benchmarks come from Australian rapid-leveller technical guidance, which includes approximately 2 to 4 hours before foot traffic and strength development of 15 to 20 MPa at one day, 20 to 25 MPa at seven days and at least 35 MPa at 28 days. Those strength figures describe a particular formulation, not every bag labelled self-levelling.

The Davco Lanko 184 technical sheet supports finish-specific windows including 4 to 6 hours for tiles, 16 to 24 hours for carpet and 24 to 36 hours for vinyl, with other Australian formulations extending direct-stick vinyl and timber allowances. The broader table is a scheduling guide across products, not a specification for one product.

Read the covering window, not just the headline

A rapid-screed technical data sheet specifies 48 hours before timber or parquetry and recommends 24 hours before waterproofing, ideally with residual moisture below 2 per cent. Residual moisture by percentage and slab relative humidity are different measurements. Don't substitute one for the other.

Fast specialist systems can shorten the timetable considerably: Sika Australia lists Sikafloor Level Ultra as ready for tiles or stone after approximately 5 to 6 hours at 23°C, and moisture-sensitive flooring after approximately 7 to 8 hours. That's permission for that system under its stated conditions, not permission to accelerate another compound.

Practical rule: Find the row for your finish. The foot-traffic row only tells you when you may regain access.

Reference conditions are controlled, not typical of every renovation. The ARDEX K 10 Reactiv8 specification uses approximately 23°C and 50 per cent relative humidity, while expressly identifying thickness, substrate and ambient conditions as influences on drying.

How Thickness, Substrate and Climate Shift the Clock

Think of the compound as a wet layer that must release moisture while its cementitious binder develops strength. A thick layer on a cold slab in a closed room won't behave like a thin application in controlled conditions.

Factors that change drying time and what to do about each

Factor Effect on drying What to do
Layer thickness Deeper pours contain more water and take longer to reach covering readiness Check maximum layer depth; don't fill deep voids in one unsupported pass
Temperature Cold substrates and cool rooms extend drying Measure slab temperature as well as room temperature; warm gently within product limits
Relative humidity Humid air slows moisture loss Ventilate or dehumidify and allow a contingency day
Airflow and heat Controlled airflow helps; hot wind and direct sun can damage curing material Protect early curing, then introduce controlled ventilation
Substrate absorbency Porous slabs draw water from the mix; sealed surfaces restrict absorption Use the specified primer and assess existing coatings
Slab age and water-cement ratio The slab can retain moisture long after the leveller becomes firm Test rather than judging by the slab's appearance
Compound type Rapid and standard formulations have different covering windows Read the exact product's Australian technical sheet

Inspect the deepest areas, not just the thin edge at the doorway.

A professional construction worker inspecting a freshly applied wet self-leveling compound on a bathroom floor.

A cold room changes the booking

For a concrete example, Glues Australia's Dunlop Multipurpose Floor Leveller listing specifies 4 hours before walking, 4 to 6 hours before tiling and 24 hours before other coverings. Those are different permissions, even though they appear on the same product listing.

Say that product is poured into a cool, humid ensuite with the door closed. I wouldn't book the next trade against the earliest advertised window. I'd arrange controlled ventilation, assess the deepest pour and reserve a later attendance, with release conditional on the product requirements being met.

Don't point a fan heater directly at the floor to recover lost time. A dry-looking skin isn't the objective, and uneven heating can create a new problem rather than resolve the original delay.

For substrate preparation, our guide to self-levelling compound for concrete explains the considerations before pouring. Preparation and drying belong in the same plan.

As a booking allowance, add a contingency day where the room is cold, damp or poorly ventilated. That's a scheduling recommendation, not a promise that another day will make an unsuitable substrate ready.

Why a Floor Can Feel Hard While the Slab Stays Wet

A hard surface isn't evidence of a dry slab. Think of a damp sponge under a firm lid: touching the lid tells you little about the water underneath.

A damp patch deserves investigation before another layer conceals it.

A hand lifts a carpet piece to reveal a wet, drying concrete floor with a damp patch.

The leveller and supporting concrete have different moisture histories. According to LATICRETE's concrete-drying guidance, concrete with a water-to-cement ratio of 0.50 to 0.70 can take roughly 3 to 9 months to reach 90 per cent relative humidity under suitable drying conditions, while ratios of 0.38 to 0.50 may still require about 2 to 3 months. Reaching that humidity isn't automatically approval for the finished flooring.

Australian Flooring Technology moisture-checking guidance identifies acceptance limits of 70 per cent relative humidity for an insulated-hood test and 75 per cent for an in-situ probe test, while warning about adhesive application before the leveller has fully cured. The lowest applicable system limit controls, normally including the floor-covering manufacturer's requirement.

Two slabs, two different problems

A new bathroom slab poured in winter may retain substantial construction moisture. A rapid leveller can provide a smooth working surface without making the underlying concrete suitable for an impervious finish.

An older ensuite with rising damp presents a different issue. Waiting longer won't reliably solve continuing moisture entry. The builder needs to investigate the source, which could involve plumbing leakage, external drainage or ground moisture, before choosing the repair system.

The distinction matters when watching a pour or judging its appearance. Use visual demonstrations to understand the material, not to certify its moisture condition.

A levelling layer corrects the floor profile. It isn't automatically a moisture barrier.

A product may accept application over a relatively damp slab while the final vinyl, timber or membrane has stricter limits. Those permissions aren't interchangeable. Establish whether you're dealing with residual construction moisture or an active moisture source before programming the finish.

How to Check Moisture Before Tiles, Vinyl or Membranes

Moisture sign-off should produce a record someone else can verify. A surface meter can help locate suspect areas, but its reading doesn't automatically replace the specified concrete humidity test.

Establish the release criteria

  1. Confirm the finish and its limits. Obtain the relative humidity and pH requirements from the floor-covering, adhesive or membrane manufacturer. Check the complete build-up, because approval for the leveller alone doesn't approve the layers above it.

  2. Identify the slab and its history before selecting test positions. Record whether the substrate is concrete, screed or sheet flooring, and note leaks, damp patches, repairs and drainage concerns. A concrete testing method shouldn't be applied indiscriminately to another substrate.

  3. Select the required test method. Use an in-situ probe or insulated-hood test where the installation specification calls for it. Name the method and applicable standard in the test plan, using the manufacturer's technical sheet and the relevant Australian installation requirements rather than choosing whichever instrument is available.

The practical sequence is straightforward.

A four-step infographic illustrating how to check moisture levels in a concrete slab before installing flooring materials.

Measure, compare and record

  1. Test close to installation. Don't rely solely on a reading taken before pouring or while the room was operating under different conditions. Allow the specified instrument conditioning and equilibration procedure; an immediate reading may not be the required result.

  2. Compare the reading with the strictest applicable limit. If it fails, hold the installation, improve drying conditions where appropriate and retest. Where moisture continues to enter the slab, investigate or specify an approved moisture-management system instead of repeatedly extending the booking.

  3. Keep a usable test log. Record the date, room, test locations, method, result and instrument details, together with probe depth or hood conditions. Include the product requirements used for acceptance and identify who authorised the next trade to proceed.

For resilient and textile flooring, identify the applicable installation standard, including AS 1884:2021, AS 2455.1:2019 or AS 2455.2:2019, as relevant to the selected finish. These are installation requirements, not a reason to guess a test procedure or transfer a result between incompatible methods.

The usual slips are testing only the top surface, choosing a convenient corner and assuming it represents the whole room, or treating walkability as a passed test. Include suspect areas and changes in substrate construction when planning locations.

For wet-area sequencing, consult our guide to bathroom waterproofing standards. Moisture acceptance, substrate preparation and membrane compatibility all need to be resolved before application.

Bathroom and Ensuite Timing for Melbourne Conditions

A bathroom floor must support a compliant wet-area system, not merely look flat. The NCC wet-area provisions require the shower floor to be waterproof and, for the specified shower arrangements, shower walls to be waterproof to at least 1,800 mm above the floor substrate, including the relevant junctions and joints.

That makes drying a sequencing issue. The compound must be suitable for the next specified layer, whether the approved build-up puts it beneath waterproofing or elsewhere in the assembly. Don't change that sequence because another trade has arrived.

Preserve drainage before chasing flatness

The ABCB's waterproofing guidance identifies a waterstop at least 1,500 mm horizontally from the shower rose for an unenclosed shower, and requires floor arrangements that avoid hazardous or unhealthy water accumulation. A levelling pour mustn't bury waterstops, obstruct flanges or remove required falls.

Check the floor with a straightedge and level before mixing. Mark the waste, doorway transition and intended finished heights, then decide whether the area needs flattening, graded screeding or a different repair. Flat and level aren't interchangeable with correctly drained.

A Melbourne ensuite booking

Say a rapid compound is poured at nine in the morning into a cold, windowless ensuite. It might allow access by mid-afternoon, yet the installer may reasonably defer the covering assessment until the following morning. That's a hypothetical booking decision, not a guaranteed product timetable.

A closed ensuite with an extractor linked only to the light switch needs an actual ventilation plan. Cool, damp conditions won't improve just because nobody enters the room overnight, and an early tile window doesn't override a membrane's separate requirements.

Before releasing the room:

  • Confirm conditions. Check room and substrate temperature against the product's limits.
  • Maintain controlled ventilation. Arrange continuous extraction where appropriate without blasting the fresh surface.
  • Approve the substrate. Complete required testing and inspect stability before waterproofing.
  • Keep booking flexibility. Reserve a contingency day rather than stacking trades against the earliest possible release.

For existing bathroom renovations, the applicable alteration requirements depend on Victorian legislation and the project's circumstances. The builder should establish the compliance pathway before the floor build-up is finalised.

Balcony and Terrace Drying in Melbourne Weather

Balconies exchange the closed-room problem for exposure. Before pouring, assess the weather against the chosen product's exterior-use approval and curing instructions.

  • Direct sun and drying wind can remove surface moisture too quickly, increasing the risk of cracking or crazing.
  • Cold nights can slow hardening after a mild afternoon and leave the next morning's surface less advanced than expected.
  • Rain can disturb an insufficiently hardened surface, wash away fines and leave an unsuitable bonding face.
  • Wind-driven dust can contaminate a tacky surface that later needs cleaning or preparation.

Protection must suit the forecast

Say a small balcony is screeded late on an autumn afternoon. The installer needs to consider the overnight temperature and rain forecast, not just the pleasant conditions during mixing.

Shade cloth can reduce sun and wind exposure, but it isn't rain protection. A suitable temporary cover needs clearance above the material, secure fixing and drainage that won't discharge onto the fresh work. Don't lay plastic directly onto a soft surface unless the product manufacturer specifically permits that curing method.

The surface also needs checking after exposure. Dust, rain damage or a weak skin may require preparation before waterproofing, even where the compound underneath has hardened.

Booking advice: Reserve a weather contingency for every balcony pour. Don't make membrane application depend on an uninterrupted forecast.

Release the balcony as a system

Choose a compound approved for the exterior location and compatible with the membrane. An interior leveller does not become suitable for a balcony because it will eventually be covered.

The membrane appointment should remain conditional on the substrate meeting its specified moisture and stability requirements. Preserve the fall to the outlet, check door thresholds and inspect the drainage details before accepting the surface.

Use a short pre-handover checklist:

  • Protection ready. Provide shade and weather protection through the specified early-curing period.
  • Falls confirmed. Check that the outlet remains the drainage low point.
  • Forecast suitable. Allow enough protected working time for the selected system.
  • Moisture accepted. Record the required result before membrane application.

If the weather changes, move the booking. Trying to recover a programme by waterproofing a questionable surface puts the most difficult layer to repair at risk.

Registered Builders and Drying Gates in the Contract

A tiler's registration exemption doesn't automatically cover an entire bathroom renovation. Consumer Affairs Victoria's registration guidance requires registration with the Building and Plumbing Commission for domestic building work costing more than $10,000, including labour and materials, and for permit-required work regardless of value; combined-skills renovations above the threshold also require registration.

Tiling alone is listed as exempt, but coordinating carpentry, plumbing, electrical work, waterproofing and tiling is broader building work. Registration must be approved before commencement, not merely applied for.

Name the responsible practitioner

Check the practitioner named in the agreement and their authorised scope. Melbourne Tiling Services P/L operates as Registered Unlimited Builders; all our workers are qualified and certified waterproofers or tilers, and our team includes licensed carpenters, electricians, plumbers, tilers and waterproofers.

Victorian consumer guidance on building practitioners says bathroom renovation contracts above $10,000 should use a major domestic building contract, with domestic building insurance required above $16,000 before 1 July 2026 and a $20,000 Home Warranty insurance threshold from 1 July 2026. Confirm the applicable commencement-date requirements and obtain the required certificate before paying a deposit or starting work.

Put release conditions beside dates

A programme says when a trade is expected. A drying gate says what must be true before that trade can start.

The written schedule should include:

  • Trade responsibility. Name who prepares, tests, waterproofs and tiles.
  • Product identification. Record the compound, intended finish and relevant covering requirements.
  • Test evidence. Include date, room, method, result and acceptance criteria.
  • Sign-off authority. Identify who releases the substrate and who revises bookings after a failed check.

A useful entry reads: Laundry vinyl after documented moisture acceptance; bathroom membrane after the specified waiting period and substrate-moisture pass. That's clearer than a fixed start date with no conditions attached.

Confirm the Handover Timeline Before You Book Tiling

Make the booking from the finish backwards, not from the day the compound is poured. Use these decisions to turn an optimistic programme into a workable handover:

  1. List each area and finish. Separate the bathroom, ensuite, balcony and laundry, then identify the appropriate covering milestone.
  2. Get the release conditions in writing, including the exact product, expected attendance and evidence needed to proceed.
  3. Arrange moisture checks close to installation. Vinyl, timber and membranes need the specified acceptance process, not a walkability judgement.
  4. Leave space between the earliest product window and the booked installation. I would allow the following day where practical, extend that allowance for cold or damp rooms, and keep a weather contingency for balconies.

Our self-levelling work covers concrete slab and cement sheet floors in bathrooms, laundries, terraces and balconies. We commit to completing bathroom remodelling and repair work within the agreed timeframe, so the agreed programme needs realistic drying allowances rather than assumed overnight releases.

Use the bathroom renovation timeline to organise trade dependencies. Rescheduling before installation is preferable to paying for removal of a failed finish or disputing whether installation conditions were met.

Call Melbourne Tiling Services on 1300 661 658 to discuss the handover sequence for your bathroom, ensuite or balcony. Have the product data sheet available, with the required moisture result determining the final release.


Melbourne Tiling Services P/L offers bathroom and ensuite renovations, self-levelling, screeding, waterproofing and tiling, with the floor preparation coordinated around the finished system. Visit Melbourne Tiling Services P/L to discuss your substrate, intended finish and the checks needed before the next trade starts.
