Ceramic Floor Tile Installation: A Homeowner Guide

You've chosen the tiles, cleared the room and watched enough installation videos to feel confident. Then the first tile rocks on the floor, the cut around the toilet doesn't line up, or a bathroom renovation reveals a damp substrate underneath. That's when ceramic floor tile installation stops looking like a weekend decorating job and starts looking like the precision trade it is.

In Melbourne homes, the visible tile is only the final layer of a system. The substrate, falls, waterproofing, adhesive coverage, movement joints and grout all determine whether the finished floor stays sound. A homeowner can handle some straightforward dry-area work, but wet areas, structural changes and larger projects deserve a much more cautious decision about whether registered builders and specialist trades need to be involved.

Table of Contents

Planning Your Ceramic Floor Tile Installation

Most homeowners worry about chipping an expensive tile. The more serious risk is installing a complete floor over a surface that was never suitable in the first place. A good plan protects the tiles, but it also protects the adhesive bond, drainage, room transitions and future maintenance.

Map the job in six phases:

  1. Inspect the subfloor. Identify whether you're working over concrete, screed, timber or an existing finish. Check for movement, cracks, contamination, dampness and changes in level.
  2. Correct the substrate. Fill defects, remove weak material and establish a suitable, sufficiently flat plane before adhesive is mixed.
  3. Plan waterproofing and movement. Bathroom renovations require waterproofing and drainage decisions before tiles cover the work. Larger floors and exposed areas also need movement joints placed deliberately.
  4. Set out the tiles. Dry-fit rows from the room's main sightlines. A layout that leaves narrow slivers at a doorway will look poor even if every tile is technically bonded.
  5. Fix the tiles. Select an adhesive compatible with the tile, substrate and conditions, then spread it with the appropriate trowel and bed the tiles consistently.
  6. Grout and finish. Allow the adhesive to cure according to its product instructions, then grout, clean and seal where the selected materials require it.

A five-step infographic showing the planning process for a ceramic floor tile installation project.

Decisions to make before buying tiles

Tile format affects more than appearance. Large-format ceramic and porcelain products make a room feel calmer, but they expose substrate irregularities and are harder to handle. Mosaics suit shower gradients and curved details, yet their many joints demand accurate setting and careful cleaning.

Buy the tile, adhesive, grout, trims and movement-joint materials as one system. Check the manufacturer's installation requirements rather than assuming a general-purpose adhesive will suit every surface. For a complex bathroom, establish who is responsible for waterproofing certification, falls, plumbing interfaces and final tile fixing before work starts.

Practical rule: A tile isn't a levelling tool. If the floor is wrong before adhesive goes down, the finished surface will show it.

Subfloor Preparation and Waterproofing Essentials

A sound tile floor begins with a sound base. Dust, paint, old adhesive, loose screed and movement beneath the surface can prevent a reliable bond, while a floor that looks flat by eye may still be unsuitable for large-format tiles.

For thin-bed ceramic tile installation, guidance associated with AS 3958.1 states that a concrete floor shouldn't vary by more than 5 mm over 3 m, while wall substrates shouldn't vary by more than 4 mm over 2 m. The practical sequence is simple, though the correction work can be demanding: inspect, measure with a straightedge, repair defects, level where necessary, then recheck before fixing begins. The detailed principles of substrate preparation for tile work are worth understanding before you commit to adhesive.

A professional construction worker applying blue waterproof sealant to a wooden floor with a paint roller.

Flatness is different from level

A floor can slope gently and still be flat enough for tiles. A floor can also be level but contain humps and hollows that leave adhesive coverage inconsistent. That distinction matters in bathrooms, where the finished surface must fall towards the waste rather than sit perfectly level.

Large-format products are especially unforgiving. A tile may bridge a hollow, leaving a void beneath its centre, or pivot over a high spot and create lippage at the adjoining edge. Use a long straightedge and mark problem areas before choosing between patching compound, grinding, screed or a levelling system.

Waterproofing comes before the finish

The National Construction Code requires wet-area waterproofing to comply with AS 3740, and AS 3740:2021 sets minimum requirements for waterproofing materials, design and installation in domestic wet areas across relevant building classes, as explained in Australian wet-area waterproofing guidance.

In Victorian shower work, the VBA guidance requires a shower floor to fall towards the waste at a minimum of 1:80 and no more than 1:50, with shower walls waterproofed to 1800 mm above the floor substrate. These details must be checked before tiling. A tile and grout layer isn't a substitute for a correctly installed membrane, sealed penetrations and properly formed junctions.

The floor should drain without ponding, the membrane should be compatible with the substrate and adhesive system, and the waterproofing should be allowed to cure as specified. If a bathroom renovation involves moving wastes, rebuilding the shower base or altering wall linings, bring the appropriate licensed trades into the project rather than trying to hide defects under tile.

Laying Tiles and Mastering Cuts

Once the base has passed inspection, mark the layout before opening the adhesive. Find the main visual axis of the room, dry-lay several rows and check how the pattern meets walls, cabinetry, doorways and floor wastes. The centre of the room isn't always the best starting point. A bathroom may look better if the most visible wall receives full or balanced cuts, while a hidden vanity edge takes the smaller pieces.

Spread only as much adhesive as you can cover within its open time. Comb the bed in one direction, then press and slide each tile into place rather than dropping it onto the ridges. For larger formats, back-butter where the adhesive system requires it and lift an occasional tile to check coverage. Hollow corners and weak edges are common when the installer relies on a few adhesive dabs instead of a properly compressed bed.

Choose the trowel notch from the adhesive and tile manufacturer's instructions, not from habit. A small ceramic wall tile and a thick large-format floor tile don't place the same demands on the adhesive bed. Keep joints consistent with spacers or a suitable levelling system, but don't use clips to force tiles over an uneven substrate.

Cuts decide whether the job looks professional

A manual cutter works well for clean, straight cuts on compatible ceramic tiles. Use a wet saw with a suitable diamond blade for harder products, narrow strips, mitres and cuts close to visible edges. Hole saws help with pipe penetrations, while an angle grinder can shape difficult cuts, but it creates dust and can chip glazed faces if handled aggressively.

Measure each cut at the actual location. Walls aren't always square, and a tile measured from the opposite side of the room can be wrong by enough to ruin the fit. Leave the specified perimeter gap rather than wedging tiles tightly against walls, cabinets or fixed structures. That space is part of the movement strategy and is later covered with an appropriate flexible sealant or trim.

A clean layout can make an ordinary tile look expensive. A poor layout can make a premium tile look like a rushed repair.

Grouting and Sealing for Durability

Grout isn't there to compensate for bad setting. It fills the designed joints, helps keep debris out and gives the floor its finished appearance, but it can't repair poor adhesive coverage, uneven edges or movement beneath the tiles.

Wait until the adhesive has cured according to the product instructions. Mixing too much grout at once often leads to rushed application, while adding extra water later can weaken colour consistency and leave a powdery surface. Work the grout firmly across the joints, hold the float diagonally to the tile edges and remove excess before it hardens.

Cement-based grout suits many domestic floors when the joints, tile surface and exposure are appropriate. Epoxy grout costs more and requires disciplined application, but it can provide strong resistance to staining and moisture in demanding areas. The decision depends on the tile, joint width, cleaning expectations and the installer's ability to work within the product's pot life. The differences are set out clearly in this comparison of epoxy grout and cement grout.

Cleaning is part of the installation

Wash the surface in controlled passes with a damp sponge, rinsing frequently. Too much water can pull pigment from cement grout, while leaving residue on the tile face creates a stubborn haze. Textured ceramic surfaces need extra attention because grout can lodge in their profile.

After the grout has firmed, polish remaining film with the method recommended by the manufacturer. Don't use an acidic cleaner on a surface or grout that the product instructions say could be damaged by acid. Protect the floor from traffic, dirt and trades until the grout and any sealant have reached their specified cure.

Not every ceramic tile needs sealing. Some cementitious grouts do, while many glazed ceramic surfaces don't. Seal the materials that require it, test an inconspicuous area first and maintain the floor with products compatible with the grout and tile. In Melbourne's damp winter conditions, good ventilation and prompt removal of standing water matter just as much as the initial finish.

Common Mistakes to Avoid

The expensive failures usually begin before the first tile is placed. A rushed installer may focus on the visible pattern while ignoring the substrate, drainage and movement conditions that carry the load underneath it.

Where installations go wrong

  • Skipping the straightedge check: Excessive variation leaves voids, lippage and unstable corners. Correct the base before spreading adhesive.
  • Treating waterproofing as tile preparation: A membrane must be designed and installed as part of the wet-area system. Grout lines won't stop water reaching a failed junction.
  • Forgetting movement joints: Australian guidance tied to AS 3958:2023 limits external floor joint spacing to 4.5 m. Internal floors need joints where a dimension exceeds 9 m, with spacing no greater than 4.5 m. In direct sunlight, internal floors exceeding 6 m also require that spacing. These requirements are explained in Australian movement-joint guidance.
  • Blocking the perimeter: Tiles jammed tightly against walls have nowhere to accommodate movement, especially where sunlight, temperature changes or structural movement affect the floor.
  • Rushing cure times: Early foot traffic can disturb alignment and weaken the developing bond. Keep other trades off the surface until the adhesive and grout are ready.
  • Ignoring slip performance: A tile's appearance doesn't tell you enough about wet safety. Australian guidance distinguishes testing for new and existing surfaces under AS/NZS 4586 and AS 4663, and practical residential wet-area targets commonly sit around P3 to P4, with higher ratings needed for more exposed locations, as outlined in Australian ceramic tile testing guidance.

The right response to a defect is to investigate its cause, not cover it with more grout or silicone. Cracking, tenting, hollow sounds and persistent dampness usually indicate a system problem that needs proper diagnosis.

When to Hire a Registered Builder

A homeowner can reasonably tackle a small, uncomplicated dry-area floor when the substrate is sound, no plumbing or structure is changing, and the installation remains within their skill level. Measuring, dry-laying, cutting a few straight edges and grouting carefully are manageable tasks. The risk rises sharply when the project includes a shower, balcony, extensive demolition, structural alterations or several trades working in sequence.

Project situation DIY may be reasonable Professional coordination is safer
Dry room with a sound concrete base Small format, simple layout and accessible edges Large-format tiles, extensive levelling or difficult thresholds
Bathroom floor refresh Only where waterproofing remains intact and no wet-area system is disturbed New shower base, membrane, waste, falls or wall waterproofing
Whole bathroom renovation Cosmetic work with no trade interfaces Plumbing, electrical, carpentry, waterproofing and tiling together
Commercial or large residential floor Rarely suitable without the right equipment and experience Detailed set-out, movement planning, scheduling and compliance records

Victorian registration rules need careful reading. A person or company generally must be registered with the Building and Plumbing Commission for domestic building work worth more than $10,000, but an exception applies to work involving only one type of work, including wall and floor tiling, according to the BPC practitioner search and guidance. If the job combines skills such as plastering and painting, registration may still be required.

That exception doesn't turn a wet-area renovation into a simple tiling job. Victorian consumer guidance says builders or tradespeople carrying out work worth more than $10,000 must be registered with the BPC, and an unregistered builder means you can't obtain Home Warranty insurance. Homeowners should verify registration before signing a major domestic building contract through Victorian builder and tradesperson guidance.

For bathroom renovations, use a registered builder or properly coordinated licensed team when the scope goes beyond isolated tiling. You're paying for sequencing, documentation and accountability, not merely someone to spread adhesive.

Essential Tools and Next Steps

The right tools don't rescue a poor plan, but the wrong tools make accurate work much harder. Start with measuring and inspection equipment, then add cutting and mixing tools suited to the selected tile.

Useful equipment includes:

  • Inspection tools: A long straightedge, tape measure, level, pencil, chalk line and moisture-checking approach suitable for the substrate.
  • Preparation tools: Scrapers, grinders where appropriate, patching tools, buckets and cleaning equipment.
  • Setting tools: The specified notched trowel, margin trowel, rubber mallet, spacers, levelling components and a mixing paddle.
  • Cutting tools: A quality manual cutter for straight ceramic cuts, plus a wet saw or diamond hole saw for harder materials and penetrations.
  • Finishing tools: Rubber grout float, sponges, sealant gun, profiling tools and protective knee pads.

A detailed tiling tools guide can help you match equipment to the tile format instead of buying a random kit. Large-format work may also require safe handling equipment and a second person, while dusty cutting needs proper site controls.

A practical start-to-finish checklist

  1. Confirm the tile, adhesive, grout and sealant are compatible.
  2. Inspect the substrate and measure flatness with a straightedge.
  3. Resolve cracks, hollows, contamination and unsuitable surfaces.
  4. For wet areas, confirm waterproofing, penetrations and falls before tiling.
  5. Dry-lay the pattern and decide where cuts will fall.
  6. Allow for perimeter and movement joints in the set-out.
  7. Cut a small batch, test the fit and protect visible edges.
  8. Spread adhesive within its open time and check coverage by lifting tiles.
  9. Protect the installation during curing.
  10. Grout, clean, seal where required and follow the maintenance instructions.

Costs and timelines depend on demolition, substrate repairs, tile format, access, waterproofing and the number of trades involved. A cheap quote that excludes preparation or treats waterproofing as an afterthought isn't a saving. It's a transfer of risk to the homeowner.

Ceramic tiling is one part of a bathroom system. If the project includes a shower rebuild, leak rectification, self-levelling, screeding or coordination with plumbers and electricians, Melbourne Tiling Services P/L provides ceramic and other floor tiling alongside bathroom renovation and waterproofing services across Melbourne and greater Victoria.


Melbourne Tiling Services P/L can assess the substrate, coordinate wet-area waterproofing and install ceramic floor tiles as part of a broader bathroom or ensuite renovation. Visit Melbourne Tiling Services P/L to discuss your layout, request a quote and decide which parts of the work are safe to handle yourself.

Tiling a Bathroom: Guide for Renovations

A mid-range bathroom tiling and renovation project in Melbourne typically costs around $10,000, and waterproofing compliance under AS 3740 isn't optional if you want to avoid expensive leaks. If the room is already open, this is the moment to treat tiling as part of the whole wet-area system, not just the finish you see.

Most homeowners start with tile samples and end up dealing with falls, membranes, junctions, and registration rules they didn't expect. That's where a bathroom can shift from a cosmetic refresh to a regulated renovation, especially once you're working in a Victorian home with mixed substrate conditions, older framing, or a shower that's never been detailed properly.

Table of Contents

Planning a Bathroom Renovation with Tiling in Mind

A typical Melbourne bathroom renovation starts with a simple question, what tiles look good? In practice, the core question is what the room needs beneath the finish so the bathroom stays dry, straight, and compliant for years. Melbourne Tiling Services P/L notes that a mid-range project is commonly around $10,000, which is a realistic figure when you factor in preparation, waterproofing, and labour rather than just the tile box itself.

A four-step infographic illustrating the bathroom renovation planning process, including assessment, regulation, materials, and layout.

Start with the room, not the sample board

A good renovation begins with assessment. If the floor is out, the walls are bowed, or the shower recess has hidden moisture, tile choice comes second to rectification. That's why many practical renovation checklists begin with a moisture audit, then move to product selection and layout planning.

The best way to think about tiling a bathroom is as a sequence of linked trades. Screeding, waterproofing, tiling, plumbing, and sealing all rely on each other, so a shortcut in one stage usually shows up later as cracked grout, lippage, or leaks. For a useful overview of the renovation flow, the bathroom renovation process guide is a solid starting point before you lock in scope.

Practical rule: tile selection should follow substrate assessment, not the other way around.

A renovation also needs enough room in the budget for the hidden work. Waterproofing, levelling, and careful layout planning don't look dramatic on day one, but they're what stop the bathroom becoming a repair job two years later. If you're comparing ideas with other homeowners, the bathroom remodel projects page is useful because it shows how tile work sits inside the broader renovation process, not outside it.

Cosmetic refresh or compliant renovation

A cosmetic refresh can mean new grout, a few replacement tiles, or a surface-level update. A compliant renovation means the wet area is treated as a controlled system, with substrate preparation, membrane continuity, and correct detailing around doors, floors, and junctions. Those are not the same job.

In older Melbourne homes, this difference matters even more because old walls and floors often aren't ready for straight, large-format tile work without correction. If the room is being fully renewed, the tile budget should be set with contingencies for levelling and waterproofing, not just the decorative finish. That's what separates a neat-looking bathroom from one that can handle daily use.

Understanding Waterproofing Standards and Defect Risks

A bathroom can look finished while moisture is already moving behind the tiles. In Melbourne renovations, waterproofing is the part of the build that protects the structure, not a coating added for appearance. AS 3740:2021 sets the domestic wet-area benchmark, while the National Construction Code also includes waterproofing requirements. Tile installation is therefore one stage in a compliant wet-area system, not a substitute for membrane work AS 3740:2021 standard.

What the membrane has to do

The membrane must remain continuous beneath the tiles and connect correctly at wall-to-floor junctions, drains, pipe penetrations, and door frames. Australian technical guidance specifies waterproofing shower walls to 1500 mm above the shower floor or 25 mm above a fixed shower screen. The shower floor must be fully covered, the membrane must extend 150 mm beyond the shower threshold onto the bathroom floor, and adjacent walls must rise 100 mm above the bath rim technical waterproofing guidance.

These measurements control where water can travel. Grout is not the waterproof barrier, so a neat grout line cannot correct a gap, poorly sealed penetration, or broken membrane.

Wall-to-floor junctions and service penetrations deserve particular attention. Bond breakers, compatible tapes, and correct sequencing allow the membrane to move and seal as intended before adhesive is applied. Once tiles cover the surface, defective preparation becomes difficult to see and expensive to investigate.

If the membrane is wrong, the tile isn't the problem, it's the camouflage.

Inspection evidence supports that concern. Western Australia's General Inspection Report Six recorded compliance at only 58% of inspection points against the Building Code of Australia and AS 3740-2010 WA inspection report. For Victorian homeowners, the figure is a practical warning to document the membrane stage and use an appropriately qualified waterproofing contractor.

Why failure is expensive

Waterproofing defects often require more than replacing a few tiles. Demolition, drying, substrate repairs, membrane rectification, and retiling can affect adjoining rooms and delay the renovation. NSW strata defect research found waterproofing in 42% of buildings with serious defects, while Queensland Home Warranty data put bathroom claim rectification close to AUD 25,000 in 2024–2025 defect analysis.

That cost changes the renovation decision. Saving on membrane preparation can create a much larger legal and construction bill if water reaches framing, finishes, or neighbouring property. Complete the waterproofing, allow the system to cure as specified, and check the details before tiling proceeds. The bathroom waterproofing standards guide provides practical context alongside the standard.

The Step-by-Step Tiling Workflow from Substrate to Finish

A professional construction worker uses a notched trowel to spread thin-set mortar on a subfloor for tiling.

A bathroom can look ready for tiles while the work underneath is still unsuitable. The floor may need new falls, the walls may be out of plane, and the waterproofing may not yet form a continuous system. Follow the sequence carefully, because a tile finish cannot correct a moving substrate, poor drainage, or missing membrane details.

Prepare the substrate first

Start with the base required by the entire tile system, not just the surface visible beneath the tiles. Remove loose material, correct uneven areas, and establish the required falls before waterproofing begins. In a shower, water must run to the waste rather than collect in low spots.

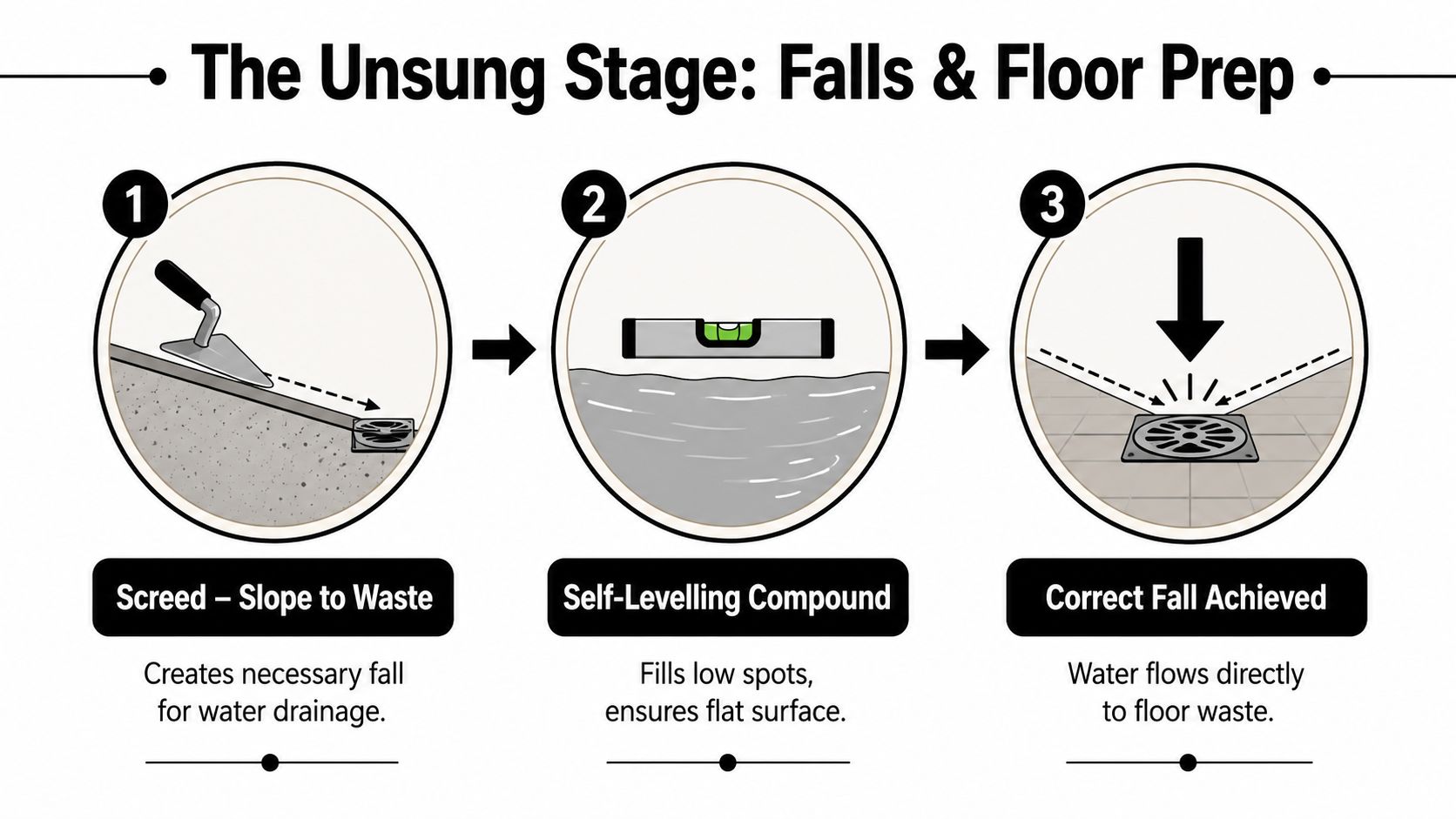

Screeding and self-levelling set the plane for the room. They are practical preparation work, particularly with large-format tiles, which show humps and hollows more readily than smaller formats. Check the substrate for stability, cleanliness, and suitable moisture conditions before applying the membrane.

Waterproof before the first tile

Australian practice places waterproofing before tiling. AS 3740 is the domestic benchmark for wet areas, so the tiles must follow a compliant substrate rather than compensate for a weak one. The membrane provides the water protection, while the tile is the wearing surface.

Check bond breakers at wall-to-floor junctions and seal penetrations around taps, mixers, outlets, and wastes. Where the system allows it, complete a post-installation water test before tiling starts. A short verification stage is far less disruptive than removing finished tiles and repairing concealed damage.

Set out the tiles with the room in mind

Set-out determines whether the finished bathroom looks planned or improvised. Balance edge cuts, align visible joints with the room, and check how the pattern meets niches, shower entries, vanity splashbacks, and fittings. Review the layout from standing height, because a plan that looks tidy on paper can produce awkward narrow pieces in the room.

Adhesive selection and trowel technique also affect the result. Use a spread suited to the tile size, and work in sections small enough to prevent the adhesive skinning before the tile is bedded. Check coverage, keep faces aligned, and control lippage as you go. Do not leave all corrections until the grout stage.

For homeowners comparing formats or planning professional work, large-format tile information explains the preparation behind a clean finish. Melbourne Tiling Services P/L provides bathroom tiling, screeding, self-levelling, waterproofing, and wet-area renovation services. Those stages need to work together, because a neat surface finish depends on the substrate and waterproofing beneath it.

Choosing Between Large-Format Tiles and Traditional Formats

Large-format tiles look sharp because they reduce grout lines and create a cleaner visual field. Traditional formats feel more forgiving, especially in older homes where walls and floors are rarely perfectly true. The choice is less about style and more about the condition of the room you're tiling.

A comparison infographic between large-format tiles and traditional tiles, showing their advantages and best applications.

The trade-off is flatter surfaces versus easier handling

Large-format tiles demand flatter substrates and tighter handling tolerance. That means more time spent preparing the room before the tile setter even opens a box. In an older Victorian bathroom, that prep can be the difference between a clean finish and a frustrating patch-up.

Traditional ceramic and porcelain tiles are more forgiving on slightly uneven surfaces and easier to work around awkward geometry. They can also be simpler to replace if one section gets damaged. If the bathroom has lots of corners, a niche, or a tricky shower recess, smaller formats often give more control.

Cost and budget pressure in Melbourne

Victorian tiling prices vary widely. Reported installed bathroom-floor tiling is around $50 to $120 per square metre, shower tiling is $60 to $150 per square metre, and waterproofing adds another $30 to $60 per square metre Victorian tiling price benchmarks. Those figures help explain why tile size isn't a pure design decision, it changes the labour and preparation load as well.

Rule of thumb: if the room isn't flat, large-format tiles can make the problem more expensive, not more attractive.

That doesn't mean large slabs are a bad choice. It means they're a better fit for rooms where the substrate has already been corrected and the layout is planned with movement joints, waste, and cut positions in mind. If you want to compare how a specialist approaches this side of the job, hire a large tile installer in Cumming is a useful example of how professional installation is framed around handling tolerances rather than just the look of the tile.

When to Hire Registered Builders for Your Renovation

In Victoria, bathroom work gets serious fast once the price rises and the scope includes waterproofing, plumbing coordination, and structural interfaces. Bathroom renovation work valued at $5,000 or more must be carried out by a registered building practitioner, and the registration must be either Domestic Builder: Unlimited or Domestic Builder: Limited for bathroom work Victorian registration threshold. That's not bureaucracy for its own sake, it's the system that helps keep wet-area work accountable.

Why registration matters

A registered builder brings the right trades together in the right order. Tilers, plumbers, carpenters, electricians, and waterproofers need to coordinate around the membrane, the falls, and the finish layer. If one trade jumps ahead of another, the whole room can end up with a fault that only shows after the tiles are down.

Registered-builder status also matters for insurance, documentation, and sign-off. Industry listings in Melbourne routinely identify renovation firms as registered builders, which shows how concrete that credential is in the local market Melbourne bathroom company guidance and Melbourne renovation profiles. In practice, that credential is part of the risk control, not just the branding.

Where DIY ends

DIY can work for small, low-risk surface updates if the room is dry, stable, and already compliant. It stops making sense when the job involves waterproofing, falls, penetrations, or a full strip-out. Once the work moves into regulated wet-area construction, the cost of getting it wrong can outweigh the savings very quickly.

A simple way to judge it is this, if the project would be painful to demolish and redo, it's probably not a DIY candidate. Bathrooms are unforgiving because the final look hides the part that matters most. If you want that hidden work handled by one team, Melbourne Tiling Services P/L is one option for bathroom renovations, wet-area waterproofing, screeding, self-levelling, and full tiling coordination in Melbourne and greater Victoria.

Finishing Touches and Quality Checks for Long-Term Durability

Grout and sealant are the last line of defence, but they're not a substitute for good waterproofing. The finish should be checked for hollow spots, uneven joints, poor cuts, and any sign that the membrane or tile bed was disturbed during installation. If those issues show up early, they're still fixable without opening the whole bathroom again.

A practical finishing routine also means choosing products suited to wet areas and keeping maintenance simple. If you're unsure how to treat a porcelain surface or what needs sealing, Neasden Hardware sealer advice is a useful reminder that not every tile needs the same maintenance approach.

Keep the bathroom dry where possible, clean up grime before it settles into grout lines, and watch for movement around corners or shower edges. That kind of attention protects the room long after the final clean-up is done.


If you're planning tiling a bathroom in Melbourne and want the job handled as a proper wet-area renovation, Melbourne Tiling Services P/L can help with waterproofing, screeding, self-levelling, large-format tile work, and full bathroom renovations. Visit Melbourne Tiling Services P/L to discuss your room, your budget, and the right scope before the first tile is set.

Bathroom Renovation Steps: A Practical 2026 Guide

You're crouched in front of a tired 1990s bathroom in a Melbourne weatherboard, laptop open to a tradie quote, start date booked, and a council permit deadline approaching. The tiles look like the main problem, but the risk sits behind them. If demolition, plumbing, electrical work, waterproofing, inspections and tiling happen in the wrong order, a renovation that looked straightforward can turn into rework, delays and arguments about who pays.

The safest bathroom renovation steps in Victoria follow a compliance-driven sequence. Design decisions come first, registered builders and permits are checked before work starts, and waterproofing must be completed and certified before tiles cover the evidence. The finish matters, but the order protects the budget.

Table of Contents

Why the Order of Bathroom Renovation Steps Matters

A bathroom renovation isn't a single leap from old tiles to a finished room. It's a chain of trade checkpoints, and each one depends on the work before it. The waterproofing inspection must happen before tile adhesive is mixed. Pipework and wiring rough-in need to be set to the finished wall positions before the substrate is closed. A registered builder may become the legal gatekeeper once the work involves structural changes or permit-triggering alterations.

That sequence is what separates a controlled project from an expensive strip-out followed by guesswork. An out-of-order renovation commonly creates rework, failed flood tests and warranty disputes. A clear plan turns the job into a series of passable stages, rather than asking the homeowner to trust that everything under the tiles will work forever.

An infographic illustrating the seven chronological steps for a successful bathroom renovation project timeline.

Start with the room, not the finishes

The first useful document isn't a mood board. It's an accurate measure-up.

Record the room dimensions, ceiling height, window and door swings, floor joist direction and substrate type. Note where the existing toilet, basin, shower and bath sit, but don't assume those positions are suitable for the new design. Check access for materials, the location of the main switchboard, drainage constraints and whether adjoining walls or floors show signs of moisture damage.

The design can then move into a 3D concept that fixes the functional decisions early:

  • Fixture locations: Set the toilet, vanity, bath and shower positions before rough-in pricing.
  • Shower geometry: Confirm the screen size, entry direction, niche locations and whether a hob-less design affects drainage.
  • Tile module: Choose the tile format and layout early, because large-format panels, mosaics and feature borders require different set-out and preparation.
  • Services: Mark exhaust fans, heated towel rails, mirror demisters, lighting, shaver outlets and underfloor heating before walls are lined.

A 3D drawing is valuable because it gives the plumber and electrician real positions to price against. “Move the shower somewhere over there” isn't a scope. A dimensioned plan is.

Practical rule: Design the layout first, select the products second, and only then ask trades to price the work.

Fixture selection should be equally deliberate. Confirm the toilet suite, basin, tapware, shower mixer, shower head, screen, accessories, mirror and storage before demolition. A tap that looks right online may have a different spout projection, waste connection or wall-set requirement. A freestanding bath may require floor access and extra plumbing coordination. A frameless screen needs accurate finished dimensions, not an optimistic opening measured before tiling.

Put every trade into the written scope

The quote should identify who handles demolition, disposal, framing, plumbing, electrical work, waterproofing, screeding, tiling, painting, glazing and final cleaning. It should also state the waterproofing area in square metres, screed volume, tile supply and laying rates, fixture allowances and builder margin.

That level of detail makes competing quotes comparable. It also gives you a reference when demolition exposes an old pipe, damaged substrate or non-compliant previous repair. The written scope should be signed before demolition day, with changes documented as variations rather than discussed casually on site.

For a broader checklist covering the essential renovation steps for homeowners, use a planning resource that prompts decisions about layout, services, selections and construction preparation. The important point is not to collect more inspiration. It's to close decisions before the first wall is opened.

Budgeting, Quotes and the Real Cost Bands

A bathroom quote only becomes useful when every builder is pricing the same room, the same products and the same level of compliance. One contractor may include demolition, disposal, waterproofing and painting, while another may leave those items as allowances. The cheaper total can then be nothing more than a thinner scope.

The broader Australian renovation market helps explain why the bathroom sequence matters financially. A 2026 report estimated Australians spent more than AUD 50 billion on home renovations, with bathroom and kitchen projects together accounting for over 60% of that spending. The same report placed a full bathroom renovation nationally at about AUD 10,221 to AUD 20,443, with Melbourne at roughly AUD 10,500 to AUD 21,000. These figures are described in the 2026 Australian renovation-market report, and actual costs still depend heavily on access, selections and concealed conditions.

The following bands are practical comparison categories, not fixed prices. The verified Melbourne range above is a useful reference point, but a detailed custom scope can move above it when the layout, structure or finishes become more demanding.

Cost Driver Cosmetic Refresh Mid-Range Full Reno Premium Custom
Main scope Surface and fixture updates Full strip-out and replacement Bespoke layout, premium finishes and complex detailing
Plumbing Usually retained Some alterations Relocated or extensively altered
Tiling Limited or selected areas Walls and floor Large-format, stone, intricate or feature work
Waterproofing Confirmed where wet areas are opened Full wet-area system Detailed open-shower or custom system
Trade coordination Limited Builder-managed High coordination across design and specialist trades

Read the line items, not just the total

A proper quote should separate demolition and disposal, waterproofing per square metre, screed, wall and floor tile supply and laying, plumbing rough-in and fit-off, electrical rough-in and fit-off, shower screen, painting, builder margin and contingency.

A single scope change can affect several of those lines. Moving a shower may alter drainage, wall framing, waterproofing, screeding, tiling and electrical coordination. Large-format tiles can change adhesive, handling and laying requirements. A freestanding bath can affect plumbing, floor preparation and access.

Storage decisions deserve the same practical attention as tile colour, particularly in compact Melbourne apartments. Space-saving ideas such as the Endless Storage small apartment solutions can help you think about storage beyond a larger vanity.

Keep a homeowner-held contingency for concealed conditions and agreed changes. Don't treat an allowance buried in a builder's price as permission to change the scope without a written variation. A bathroom renovation calculator can help organise the early scope before you compare formal quotes.

When You Need a Registered Builder and a Permit

The first legal question isn't “Which tile do I like?” It's “What exactly am I changing, and who is authorised to coordinate it?”

In Victoria, domestic bathroom work valued over AUD 10,000 generally requires a registered domestic builder, as outlined in Victorian bathroom renovation regulation guidance. If the project exceeds AUD 16,000, the builder must also provide domestic building insurance. Those thresholds should be considered alongside the actual scope, not used as a shortcut to split one substantial project into smaller informal jobs.

Structural changes, significant plumbing alterations and work involving the building fabric can move a project into the building permit stream. Relocating the bathroom footprint, moving a load-bearing wall or cutting into the subfloor requires more scrutiny than replacing a vanity in the existing position. Curbless showers and open wet areas also demand careful planning because the falls, drainage and waterproofing must be resolved before finishes conceal the work.

Check the practitioner before signing

A registered builder should help assemble the project documentation, which may include:

  • Building permit material: Confirm the relevant application, plans and surveyor requirements.
  • Structural information: Obtain engineering input when walls, joists or other structural elements are affected.
  • Wet-area design: Specify a waterproofing system aligned with AS 3740-2021 and the actual shower configuration.
  • Insurance documentation: Confirm the required domestic building insurance where the project value reaches the applicable threshold.
  • Trade credentials: Verify the practitioners responsible for plumbing, electrical and waterproofing work.

The Victorian Building Authority and Building and Plumbing Commission process for bathroom, kitchen and laundry renovation registration asks applicants for industry qualifications, project work evidence, a technical referee report, police or criminal history checks, photo identification, declarations and payment, as shown in the domestic builder renovation application form. As a homeowner, you should check the builder's registration before signing and understand who is responsible for permits, inspections and certificates.

Owner-builders need to be particularly careful. If you're coordinating the work yourself, check whether an owner-builder certificate of consent applies before taking responsibility for the project. A cash price from an unlicensed renovator isn't equivalent to a registered building practitioner managing a compliant domestic building contract.

The permit and registration question also applies to the demolition phase. Demolition is a paid stage with its own risks, not a free favour added by the tiler.

Strip out methodically

Start with a written strip-out checklist:

  1. Remove existing tiles and screed.
  2. Disconnect and remove the vanity, shower screen, bath, cistern, towel rails and mirror.
  3. Remove tile backer board down to studs or brickwork where the scope requires it.
  4. Photograph the exposed substrate before sealing the room.
  5. Check for rot, movement, old leaks, damaged framing and asbestos-containing materials in older homes.

Protect the rest of the house with ram board on floors, plastic zip-wall sheeting across doorways and sealed returns along the hallway. Have the electrician isolate and lock off the bathroom circuit. Disconnect plumbing at the fixture valves where possible, rather than shutting down the whole house unnecessarily.

Don't wet dusty demolition waste. Cap exposed pipework, sweep and vacuum the room, and arrange a skip or bagged waste pickup so the next trade reaches a clean, safe slab ready for rough-in. The photographs matter because they record pre-existing conditions and can settle later questions about damage beneath the old bathroom.

An infographic detailing the AUD 10,000 threshold, required permits, and penalties for unlicensed building work in Victoria.

Permit responsibility should be confirmed in writing, not assumed from a builder's casual comment. For specialist coordination, compare the documented scope with the services described by Melbourne bathroom renovation specialists before work begins.

Plumbing and Electrical Rough-In

Once demolition is complete, the plumber and electrician work before the walls are closed. Their measurements must relate to the finished wall face, tile thickness and final fixture positions, not the old pipe and cable locations.

The plumber should establish drainage falls and in-wall water lines first. The electrician then runs the required circuits and protection, exhaust fan ducting and lighting cable. Both trades need to coordinate penetrations through studs and keep clear of niches, mixers, shower screens and tile edges.

Lock in these details now:

  • Niches and shelves: Their height and depth affect framing, waterproofing and tile cuts.
  • Large-format tiles: The set-out can determine where plumbing penetrations land.
  • Heated towel rails and underfloor heating: Confirm power, controls and sensor positions before lining.
  • Shaver outlets and mirror demisters: Allow for the cabinet or mirror dimensions rather than adding a socket as an afterthought.
  • Ventilation: Confirm the exhaust path and ceiling access before the plasterboard or fibre-cement sheeting closes the cavity.

Book the building surveyor's rough-in inspection before wall sheeting goes up. In Melbourne, a missed inspection slot can hold up the next trade and interrupt the entire programme. Photograph every pipe and cable against the wall, mark the heights and store those records with the renovation documents.

Keep the site dry and don't let the tiler cover an unresolved inspection. A later repair may require cutting through a finished waterproofing system, which is exactly the kind of avoidable disruption that proper bathroom renovation steps are designed to prevent.

Waterproofing the Compliance Milestone

Waterproofing is the legal and practical gate before tiling. In Victoria, it must be completed and certified before tile adhesive is applied, and licensed practitioners are expected to provide an Installation Certificate. The relevant wet-area guidance references AS 3740-2021, including a minimum 1:80 fall for wet areas, as outlined in the Victorian waterproofing fact sheet.

Prepare the substrate first. Fibre-cement sheeting needs the correct primer, screeds must be cured, corners need bond-breaker treatment, and door thresholds require an appropriate water stop. Australian bathroom guidance calls for shower waterproofing across the floor and up the walls to at least 1,800 mm, or 50 mm above the shower rose, whichever is higher, with the floor graded so water drains without pooling. The waterproofing and tiling guidance provides that coverage reference.

For an unenclosed shower, Victorian guidance requires waterproofing to extend 1.5 metres from the shower rose connection. The shower floor must also maintain a continuous fall to the waste. These requirements become more demanding with open entries, linear drains, niches and minimal-threshold designs, because there's less tolerance for poor set-out.

The application method depends on the chosen system. A liquid membrane may require two coats with the manufacturer's curing interval, while sheet systems need correctly treated joints and overlaps. Don't assume “it looks covered” is a compliance test. The waterproofer should document the product, preparation, coverage and certificate requirements.

Before tiling, arrange the required verification, commonly a 24-hour flood test or a non-destructive dry film thickness test, as described in Victorian waterproofing compliance guidance. Keep the certificate, test result and photographs in the handover file. A waterproofing compliance certificate in Victoria should be treated as a project checkpoint, not a decorative extra.

Screeding, Levelling and Tiling the Space

Once the waterproofing checkpoint is closed, screeding and tiling create the visible room. The screed has to direct water to the waste without rocking, ponding or creating a lip beneath the tile. A common site mix uses sand and cement with bond aid, compacted into wall-floor corners and finished with a steel float, but the installer must follow the specified system and substrate requirements.

Underfloor heating may require a self-levelling compound. The installer primes the substrate, pours to the specified depth and de-gasses the compound with a spiked roller so the finished surface doesn't trap voids around the heating loops. The floor must be ready for the selected adhesive and tile system, not merely appear flat from across the room.

Set out the walls before fixing

Wall tiling usually starts from a laser line and a planned module. A stack-bond layout gives a clean grid, while a brick layout shifts joints and can disguise minor variations differently. Large-format panels need careful handling, suitable adhesive coverage, butter-and-float fixing and a clip system where appropriate. Mitred corners, niches and feature bands should be set out before the first adhesive bed is mixed.

Floor tiles require a full adhesive bed, a notch size matched to the tile and proper support beneath the finished surface. Don't use grout to correct an uneven substrate. It won't solve lippage, movement or a poor fall.

Tile Type Adhesive Standard Grout Selection Fixing Method
Porcelain wall tile Flexible adhesive suited to the substrate and tile Cement or epoxy according to exposure Laser-line set-out with full coverage
Large-format porcelain Manufacturer-approved flexible adhesive Fine cement or epoxy where the wet-area specification requires it Butter-and-float fixing with levelling clips
Kerlite or thin large panel System-specific adhesive and substrate preparation Manufacturer-compatible grout or sealant Specialist handling, stable support and planned joints
Mosaic Flexible adhesive with careful bed thickness Epoxy or fine cement suited to joint width Full-bed fixing with sheet alignment
Natural stone Stone-compatible adhesive and substrate system Product-compatible grout, with sealing where specified Controlled coverage and protection from staining

Use epoxy grout in demanding wet zones where the system calls for it. Cement grout may suit drier areas when correctly selected and sealed. At every change of plane, use a flexible silicone detail rather than forcing rigid grout into a joint that needs to accommodate movement.

Shower Screens, Fit-Off and Final Trades

The final stage is where a well-sequenced renovation can still be damaged by poor coordination. The shower screen should be measured after the tiles have cured, using the actual finished opening rather than the pre-tile dimensions. Frameless and semi-frameless panels need channel or wall-pin fixings set into the tile and substrate, not grout joints.

Install the screen square and plumb, then apply silicone after the alignment is correct. A thick bead used to hide a leaning panel isn't a proper fix.

Use a fixed fit-off order

Plumbing fit-off comes next. Install tapware, mixers, wastes and shower heads, then pressure-test the connections before applying final silicone. The licensed electrician follows with the exhaust fan, IXL or heat-light combination, shaver points, mirror demister and other electrical fittings. The electrician should provide the Prescribed Certificate of Electrical Safety.

Painting and decorative finishes belong after the dusty work, but before the final clean. Non-tiled walls can receive suitable bathroom paint, while feature wallpaper should stay clear of areas exposed to direct water. Silicone all wet-area junctions, clean excess material, then allow the room to settle before the practical completion inspection.

A typical programme is best treated as a coordination reference rather than a promise:

Stage Gantt-style reference
Design, selections and approvals Weeks 1 to 2
Demolition and substrate inspection Early construction
Rough-in plumbing and electrical After strip-out
Waterproofing and compliance checks Before tiling
Screeding and tiling After waterproofing approval
Screen, plumbing and electrical fit-off Final construction stage
Cleaning and practical completion Handover

The exact programme changes with inspections, product availability, hidden damage and trade availability. Waterproofers rarely wait indefinitely for a tiler, and a late plumber can hold up sheeting, waterproofing and tile set-out. One missed trade can therefore affect several following bookings.

Verify the room before final payment

Run a short weekly site walk and keep updates in a shared WhatsApp thread or project folder. Ask who has booked the next inspection, which materials have arrived and whether a variation needs approval.

Before final payment, check:

  • Waterproofing: Certificate, product details and inspection records are present.
  • Drainage: Falls have been checked and water reaches the waste without pooling.
  • Tiling: Tile lippage, chipped edges, grout consistency and silicone joints are acceptable.
  • Ventilation: The exhaust fan operates correctly and discharges through its intended path.
  • Plumbing: Taps, wastes, mixers and shower heads have been pressure-tested.
  • Electrical work: The licensed sparkie has supplied the electrical safety documentation and test information.
  • Glasswork: The screen is square, plumb, stable and sealed at the required junctions.
  • Handover: You receive the compliance certificate, builder warranty, fixture warranties and tile batch numbers for future repairs.

Melbourne Tiling Services P/L coordinates bathroom renovations, waterproofing, screeding, self-levelling, tiling and frameless shower screens through registered builders and licensed trades. For a planned renovation with scope, sequencing and compliance checkpoints in place, visit Melbourne Tiling Services P/L to discuss the room, request a quote and organise design support.

Travertine Tile Installation: A Complete How-To Guide

You've found the stone, chosen the colour, and probably saved a dozen Melbourne bathroom images. Then the installer mentions waterproofing certificates, movement joints, substrate deflection and wet-slip ratings, and the project suddenly sounds less like a tile upgrade and more like building work. That reaction is understandable. Travertine tile installation is a compliance and detailing exercise first, and a visual craft exercise second.

The stone can look exceptional in a bathroom, ensuite, balcony transition or outdoor entertaining area, but it won't forgive a hollow screed, a back-fall, poor adhesive coverage or an unsuitable finish. The following guide focuses on the decisions that protect the finished surface, including the Victorian rules and practical controls that catch homeowners out.

Table of Contents

Is Travertine the Right Tile for Your Project

A Brunswick couple recently pulled up carpet in their 1990s bathroom after seeing travertine on a Houzz tour. They liked the warm variation and softened edges, but before any quote was prepared, three checks had to come first: substrate, environment and scope. Travertine should never be selected from a sample board alone.

An infographic titled Is Travertine the Right Tile for Your Project featuring three essential pre-purchase checks.

Check the substrate before buying stone

Concrete and timber floors behave differently. A concrete slab may provide a stable base, but it still needs assessment for cracks, hollows, contamination and movement. Timber floors need an approved fibre-cement underlay and added rigidity. Direct-sticking travertine over yellow tongue flooring is not a sound shortcut.

Natural stone also carries more dead load than a typical ceramic installation. Allow for approximately 40–60 kg/m² of stone load when checking the floor structure and have the floor assessed for a natural-stone installation where required. That figure is part of the pre-purchase decision, not something to discover after delivery.

Match the finish to the environment

A shower floor, balcony, heated slab, west-facing outdoor area and dry bathroom wall all present different risks. Moisture exposure demands compliant waterproofing and falls. Sunlight and temperature changes make movement detailing important. Bare feet and water make finish selection a safety decision.

Polished and some honed finishes can be a poor choice for wet floors. An Australian supplier lists honed travertine at 36X and tumbled travertine at 40X, with both described as presenting moderate wet-slip risk in the published product information at Bellstone's travertine Classico guide. That doesn't mean a finish is automatically suitable for every bathroom. The location, barefoot classification, slope and drainage still need to be assessed.

Define the renovation scope

A cosmetic wall upgrade is different from a wet-area reconfiguration. A bathroom renovation may involve plumbing, carpentry, waterproofing and building administration. A balcony job may involve structural movement, membrane replacement and body-corporate approval.

Travertine also has honest drawbacks. Filled pits can re-open, tumbled edges can chip, dark lots can change appearance under strong UV exposure, and honed stone can create a slip-rating problem in an ensuite shower. Those are manageable issues, but only when the specification acknowledges them.

A simple decision matrix helps:

  • Choose travertine when the substrate is suitable, the finish matches the exposure, and the wet-area or external detailing can be built correctly.
  • Choose with concessions when you're prepared to use a more textured finish, wider joints, additional preparation or a more involved maintenance plan.
  • Choose another surface when the floor can't be adequately stiffened, falls can't be achieved, the required slip performance isn't available, or the project scope is being treated as purely cosmetic when it isn't.

For design ideas and suitable natural-stone bathroom applications, review natural stone bathroom tiles in Melbourne.

Preparing the Substrate and Getting the Fall Right

Travertine exposes poor preparation quickly. A hollow beneath one corner can leave a tile rocking, while a back-fall can hold water against grout and movement joints. Substrate preparation and fall-to-waste must be treated as one job, because a flat-looking surface isn't enough if water doesn't travel to the waste.

A four-step infographic illustrating the process of preparing a concrete substrate for travertine tile installation.

Assess cure, moisture and rigidity

Concrete should be properly cured before tiling. Allow 28 days for concrete and six weeks for screeded areas, with a moisture reading below 75% RH, following the applicable product and project requirements. Those milestones are especially important under porous stone, where trapped moisture can affect bonding, appearance and later sealing.

A bonded screed commonly uses a 3:1 sand-to-cement mix, while an unbonded screed uses 4:1, with a minimum thickness of 15 mm. These figures should be checked against the specified system, substrate and manufacturer's instructions rather than treated as a universal recipe.

Timber floors need an approved fibre-cement underlay and additional rigidity. Don't rely on adhesive to compensate for floor movement. If the structure flexes, the stone and grout will often show the consequences through cracking, debonding or chipped edges.

Build falls instead of hiding them

Bathroom floors need deliberate falls to the waste. The supplied project specification calls for a minimum 1:80 fall in showers and 1:100 across the bathroom floor, while the finished surface shouldn't pond wherever a 1 m straightedge is placed. These requirements should be checked before, during and after the screed is installed.

Use screed rods, a laser level or a water level to establish the high points and waste lines. Check the direction of fall at doorways, shower entries, wall junctions and around linear drains. Travertine's natural variation can disguise small visual inconsistencies, but it won't correct a structural back-fall.

Site rule: A self-levelling compound corrects a surface. It doesn't replace a properly designed screed or create falls by itself.

Self-levelling compounds are useful where the substrate is sound and only needs surface correction. They're not a solution for a poorly formed bathroom base, insufficient drainage or an unstable timber floor. In Melbourne apartments, a slab can also be subject to body-corporate restrictions, so re-fall-screeding shouldn't proceed without the required approval.

Finally, plan for the stone's bedding requirements. Australian travertine specifications call for 100% adhesive coverage, so the substrate needs to be flat and true enough for full contact under every tile, including textured backs and larger pavers. A few dabs of adhesive won't provide the support travertine needs.

Waterproofing Wet Areas to Australian Standard

On a Melbourne bathroom or balcony, waterproofing is a compliance and detailing job before it becomes a tiling job. Tiles and travertine do not form the waterproof layer. AS 3740:2021 governs domestic wet-area waterproofing, alongside relevant National Construction Code provisions, so the membrane system, junctions and inspection must be settled before stone is installed.

The typical sequence starts with a compatible primer. Bond-breaker tape is installed at wall-to-floor junctions, internal corners and pipe penetrations before the membrane coats are applied. The first coat must reach the specified wet-film thickness, followed by the second coat in the opposing direction. Respect the product's drying times and compatibility requirements. For a practical guide to membrane selection, priming and bond-breaker detailing, see our wet-area waterproofing service.

Showers must be waterproofed across the floor and up the walls to at least 1,800 mm, or 50 mm above the shower rose, whichever is higher, as set out in Build.com.au's waterproofing and tiling reference. Floors also need grading that sends water to the waste without ponding.

Area Min membrane height Fall to waste Inspection required
Shower floor and walls 1,800 mm, or 50 mm above the shower rose, whichever is higher Minimum 1:80 in the shower Yes, before tiling
Bathroom floor Wet-area coverage as specified for the room Minimum 1:100 across the bathroom floor Yes, before tiling
Shower hob or junction Membrane detailing across junctions and up the hob Falls must direct water to the waste Yes, before tiling

Treat the certificate as part of the installation

In Victoria, arrange the required inspection before tiling and obtain the formal Installation Certificate from the licensed waterproofer. Site Pro Bathrooms' explanation of Australian waterproofing standards describes this process, but the certificate and inspection record should be checked against the applicable Victorian requirements and the project documentation. Travertine should not cover the membrane until the work has been inspected and recorded.

The waterproofed surface must also be flat enough for the stone bedding system. Travertine's textured back and weight make spot-fixing risky, while a prepared membrane surface allows the adhesive to achieve the contact required by the installation system.

The certificate matters years later. If a leak appears after the stone is covered, documentation helps identify who completed the waterproofing and which system was used.

Most membrane manufacturers condition warranty coverage on compatible primers, correct application and documented inspection. Retain the product data sheets with the certificate. DIY work often fails when a membrane is tiled before inspection, or when primers and membranes from incompatible systems are combined. The finished stone may look sound while moisture travels into adjoining walls, cabinetry or ceilings.

Choosing Adhesives, Grout and Movement Joints

Adhesive selection should follow the stone finish, colour, location and substrate. A light honed travertine generally benefits from a white polymer-modified cement-based adhesive, because grey adhesive can affect the appearance of porous or lighter stone. Tumbled travertine needs a different emphasis, with edge variation and wider joints influencing the setting and grouting approach.

For a vertical feature wall, a suitable non-sag adhesive can help hold tiles in position while the bond develops. That doesn't make mastics appropriate everywhere. Wet areas, exterior locations, flexible membranes, timber floors and heated screeds require products specified for those conditions.

Compare the installation choices

Travertine finish Adhesive type Grout joint width Movement joint spacing Bedding method
Smooth honed or polished White polymer-modified cement-based adhesive suited to natural stone 3–6 mm Internal floors generally no greater than 4.5 m where a floor dimension exceeds 9 m Full adhesive coverage, no spot-fixing
Textured or tumbled Suitable stone adhesive with enough working time for edge adjustment 6–10 mm External floors require joints at 4.5 m spacing in any dimension Full adhesive coverage, back-butter where needed
Vertical feature wall Compatible non-sag stone adhesive where approved for the location Joint selected for edge variation and movement Wall movement joints a minimum 6 mm wide Continuous supported bedding, not isolated dabs

The Australian Tiling Standards reference AS 3958.1 for installation and AS 3958.2 for tile selection. Australian guidance also treats movement control as a core requirement, with perimeter joints required on installations and intermediate joints used to accommodate substrate deflection and sunlight exposure. Those joints need to be set out before adhesive is spread, not improvised after the grout has hardened.

Use flexible silicone or another specified soft joint where the floor meets walls, hobs, frames or other changes of plane. Keep perimeter gaps clear of mortar, spacers, dirt and debris. A rigid grout bridge at these interfaces creates a path for movement to transfer into the brittle stone finish.

For cleaning and grout-care considerations after installation, expert advice from That Cleaning Crew is a useful complementary resource. It's better to choose the grout and cleaning routine together than to install a porous stone and discover later that the chosen cleaner attacks the surface or leaves residue in the joints.

Cutting, Laying and Grouting Travertine

The first laying decision happens before adhesive. Open the crate and dry-lay enough of the stone to understand the variation in colour, veins, pits and edge character. For a visible floor, I'll normally blend tiles from different boxes rather than allowing one darker group or strongly veined group to dominate a single area.

A four-step infographic illustrating the professional process of cutting, laying, and grouting natural travertine stone tiles.

Mark cuts from the actual set-out, not from a nominal measurement. A wet saw fitted with a continuous-rim diamond blade gives cleaner results through travertine than forcing a dry cut. Support the tile properly, feed it steadily and handle the cut piece carefully, because tumbled arrises and filled areas can break away at the final part of the cut.

Set the stone with full contact

Back-butter each paver with the flat side of the trowel. This fills irregularities on the back and helps the adhesive contact the entire tile. Spread adhesive on the substrate, comb it consistently, then use a butter-and-float action to bed the stone.

Press and move the tile slightly to collapse the ridges. Lift an occasional tile during the installation to confirm coverage rather than assuming it. Australian travertine specifications call for 100% adhesive coverage, and that requirement is particularly important where pavers are large, heavy or installed over a moisture-sensitive substrate.

Avoid spot-fixing. Isolated adhesive dabs leave unsupported areas beneath the tile, which can create drummy sections and concentrated stress. The goal is a continuous bed that supports the stone across its whole underside.

Respect fills, veins and tumbled edges

Travertine is not a uniform manufactured sheet. A filled pit may be sound in one tile and fragile in another. Veins can change direction through a cut, and the softened edges of tumbled formats can chip while spacers are inserted or grout is compacted.

Where cutting exposes a filled edge, pre-seal or stabilise it with a compatible product if the specification calls for that treatment. Don't drag metal tools across the face, and don't use a rubber mallet with force that could fracture a thin section. Small adjustments with suction handles, a straightedge and controlled hand pressure are safer.

The grout joint reflects the finish. Smooth honed or polished stone generally uses 3–6 mm joints, while textured finishes commonly use 6–10 mm joints, as described in Australian stone installation guidance. Wider joints give tumbled edges room to vary without making the finished layout look forced.

Grouting shouldn't begin until at least 12 hours after laying, according to an Australian travertine installation guide. Press grout diagonally across the joints, especially where the joint is wider, then clean in controlled passes so you don't pull material back out of the porous edges.

Allow the surface to dry and cure for at least 7 days before sealing or walking on the floor where the applicable stone guide specifies that period. Sealing too early can trap moisture and produce uneven colour or a cloudy finish.

Sealing, Slip Safety and Long-Term Maintenance

Sealing protects travertine from staining, but it doesn't turn the stone into a waterproof surface and it doesn't materially improve slip resistance. The wet-area decision should begin with the finish and its tested rating, then move to waterproofing, falls, grout and maintenance.

A penetrating silane or siloxane sealer is often chosen where the stone needs stain resistance while retaining a natural appearance. An enhancing sealer can deepen colour and emphasise veins, but it may change the appearance more noticeably on tumbled stone. On a correctly waterproofed substrate, a breathable penetrating system is generally preferable to a coating that traps moisture, subject to the manufacturer's instructions.

Set a maintenance plan before handover

Application Sealer type Reseal cycle Target slip rating, AS 4586 Maintenance note
Ensuite shower floor Penetrating natural-look sealer 1–2 years, depending on traffic and product Higher bathroom rating, commonly P3, P4 or P5 guidance depending on location Dry after use and inspect soft joints
Bathroom floor Penetrating or suitable enhancing sealer 2–4 years, depending on traffic and product Select to the tested wet-area requirement Use pH-neutral cleaner
Balcony or external transition Exterior-suitable penetrating sealer Product and exposure dependent Assess the required external rating, commonly within P3–P4 guidance Check joints, drainage and surface changes

The ratings and application context need to come from the tested product and the location, not from a sales description. Australian guidance notes that bathrooms and shower floors need higher slip resistance, and factory finish assumptions can be unreliable. The Aqua Mix travertine cleaning and sealing guide also highlights that sealing doesn't change slip resistance and that existing surfaces may require on-site wet pendulum testing under Australian standards.

Inherited installations sometimes need remediation rather than another coat of sealer. Options can include an acid-wash-and-seal process where appropriate, a compatible clear anti-slip treatment or mechanical micro-roughening. The correct choice depends on the existing finish, contamination, drainage and test results. Product marketing shouldn't replace verification.

For practical care of porous tile surfaces, this guide from J.G. Carpet Cleaning provides useful maintenance context, although every cleaner still needs to be checked for compatibility with travertine.

Use pH-neutral cleaners only. Vinegar and bleach can damage stone or grout, and shower floors benefit from microfibre drying after use. Inspect movement joints at least every 12 months, looking for gaps, splitting, mould growth or rigid grout replacing a flexible seal. For planned stone sealing work, see stone tile sealing services in Melbourne.

When to Bring in a Registered Builder or Tiling Specialist

Travertine becomes a poor DIY project when the work involves more than sticking tiles to a sound, dry surface. Structural waterproofing, balcony membrane replacement, multi-residential work and larger renovation scopes can require registered building professionals and coordinated trades.

In Victoria, bathroom renovations valued at $5,000 or more must be carried out by a registered building practitioner, according to the Victorian bathroom renovation guidance summarised by hipages. The relevant registration types for bathroom work are Domestic Builder: Unlimited or Domestic Builder: Limited to bathroom, kitchen and laundry renovations.

That requirement matters because bathroom renovations often include plumbing, electrical work, carpentry, waterproofing and tiling. It's not enough to hire someone who can lay stone if the project contract and building scope require registered coordination.

Know when the surface has already failed

Stop and investigate if you find:

  • Failed flood testing: Don't cover a membrane that hasn't passed the required checks.
  • Drummy tiles: Hollow-sounding areas can indicate poor bedding or debonding.
  • Efflorescence: Salt deposits can point to moisture movement through the system.
  • Deflection: A floor that moves beyond the specified natural-stone tolerance needs structural or substrate attention before tiling continues.

A specialist tiler adds more than a wet saw. The useful work includes sorting calibrated batches, mapping veins, controlling wet-cut dust, protecting exposed fills and setting out movement joints to the relevant Australian installation guidance. That preparation prevents the finished floor from looking patchy or carrying avoidable stress.

Ask every Melbourne contractor to price the same line items: substrate survey, moisture assessment, screeding or self-levelling, waterproofing certificate, slip-rating requirement, waste allowance for tumbled edges, movement-joint detailing, sealing plan and warranty terms. Melbourne Tiling Services P/L can coordinate registered building work, waterproofing, screeding, natural-stone tiling and broader bathroom renovation trades, so those items can be discussed as one scope rather than vague rates for laying tiles alone.


For a travertine bathroom, ensuite, balcony transition or remedial project, Melbourne Tiling Services P/L offers substrate preparation, compliant waterproofing, screeding, stone installation and sealing coordination across Melbourne and greater Victoria. Request a detailed quote that records the finish, fall, slip-rating requirement, movement joints, certificate process and maintenance plan before you order the stone.

Large Format Tile Guide for Melbourne Renovations

You're standing in a 1990s Hawthorn ensuite, looking at a cracked 200 x 200 mm ceramic floor and deciding what replaces it. A 600 x 600 mm porcelain tile feels like the sensible upgrade. A 1200 x 600 mm large format tile promises fewer grout lines and a calmer, more expensive finish. The decision looks visual in the showroom, but on site it becomes a question of flatness, waterproofing, handling, adhesive coverage and movement.

That's the part many renovation quotes gloss over. A large format tile can make a bathroom feel open and refined, but it won't hide a poor screed or a wavering wall. It will expose them. Australian guidance identifies large format work as more demanding because larger faces magnify substrate irregularities, while current market analysis places large-format products within the premium direction of Australia's expanding ceramic tile sector. Australian ceramic tile market analysis links the trend with fewer grout lines and faster visual coverage.

The practical trade-off is straightforward. You may reduce grout cleaning and create a stronger visual finish, but you'll usually allow more time for substrate preparation, more careful cutting and handling, and a tiler who knows how to move heavy porcelain panels without damaging them. This guide covers the definition, material choices, substrate decisions, installation sequence and Victorian compliance issues that determine whether the result lasts.

Table of Contents

Why a Melbourne Renovation Turns to Large Format Tile

Large format tile is a build-quality decision before it's a style decision. In that Hawthorn ensuite, the choice between 600 x 600 and 1200 x 600 shouldn't be made from a sample board alone. The existing floor may have movement, old adhesive, uneven screed or falls that no longer suit the new drainage layout.

A smaller tile can follow minor changes in a surface because each piece spans less area and the grout grid breaks up the visual effect. A large panel bridges those changes. If the floor dips, the tile may rock, lose adhesive contact or sit higher at one edge. If the wall bows, the finished face can show lippage, meaning an unwanted height difference between adjacent tiles.

Practical rule: If the substrate isn't flat enough for the tile, changing adhesive won't rescue the installation.

The Australian market is moving towards larger formats, particularly porcelain sizes such as 600 x 600 and 600 x 1200, but the growth of the category doesn't make every bathroom suitable for the biggest panel. Current Australian bathroom tile trend coverage also points to structured, matte finishes for wet areas, which matters because a polished large panel may look impressive while offering a poorer floor solution.

The cost calculation homeowners miss

The tile itself is only one part of the decision. A large-format quote may need to account for:

  • Substrate correction: Screeding, grinding, patching or self-levelling can take longer than fixing standard tiles to a serviceable surface.
  • Handling equipment: Suction cups, panel carriers and additional installers become important as the face and weight increase.
  • Cutting and wastage: A single plumbing cut or misplaced panel can affect a much larger piece than a standard tile.
  • Movement control: Perimeters, junctions and changes of plane need flexible detailing rather than rigid grout.
  • Repair access: Replacing one damaged panel is more involved because removal can affect surrounding finishes and the underlying waterproofing system.

A 30-kilogram panel isn't just a bigger version of a small floor tile. It's awkward, vulnerable at the corners and difficult to correct once adhesive has started to grab. Good outcomes are decided during measuring, substrate preparation and layout planning, long before the first panel is lifted into position.

What Counts as a Large Format Tile

In plain terms, a large format tile has a face large enough to demand different planning and installation control from ordinary modular tile. Australian industry guidance commonly defines the category from about 400 mm on one side, while another Australian reference frames the AS 3958 threshold around a tile with an edge exceeding 1.2 metres or a face area greater than 1 square metre. Australian large-format tile guidance describes the local shift from smaller modular formats towards larger tiles and sheets.

The terminology can feel inconsistent because suppliers, standards and technical bulletins use different thresholds for different installation concerns. For a homeowner, the useful point is that the risk profile changes as the face grows. A tile that spans more of a wall or floor needs more accurate flatness, suitable adhesive, controlled handling and a layout that respects the room rather than forcing the room to suit the tile.

Common Melbourne renovation sizes

The categories below reflect the formats regularly discussed in local bathroom and interior renovation work.

Size Typical Use Large Format per AS 3958?
600 x 600 mm Bathroom floors, laundries and general wall applications Depends on the applicable threshold
900 x 450 mm Walls, floors and benchtop-style layouts Depends on the applicable threshold
1200 x 600 mm Bathroom walls, feature floors and full-height applications Yes, where the 1.2 metre edge threshold applies
1200 x 1200 mm Open floors, feature walls and premium interiors Yes
3000 x 1000 mm Feature walls, panels and benchtops Yes

A 300 x 300 tile gives you a familiar grid of relatively small faces. A 1200 x 600 panel is roughly comparable to eight A4 sheets arranged as one broad surface, which explains why a small hollow or hump becomes much more visible across the installation.

Thickness doesn't decide whether a product is large format. A 3 mm Kerlite panel and a 20 mm porcelain paver both belong to the large-format conversation, but their structural demands, weight and adhesive systems differ substantially. Once a panel reaches the larger thresholds, lippage control, adhesive selection and handling equipment need to be specified before ordering materials.

Porcelain, Kerlite, and Stone Compared

Melbourne homeowners usually arrive at one of three material directions: dense porcelain, thin laminated porcelain such as Kerlite, or natural stone. All can produce a premium finish, but they don't tolerate the same substrate, fixing method or maintenance routine.

Porcelain is the practical all-rounder. It's available in formats from 600 x 600 through to very large slabs, with polished, matte and textured finishes. A conventional 9 mm porcelain may weigh around 17 kg/m², while a 20 mm paver can reach around 50 kg/m², so the same material family can impose very different loads. Those figures come from the product comparison described in the local Kerlite and porcelain service context at Melbourne Tiling Services' Kerlite tiling information.

Kerlite is a laminated porcelain panel commonly produced between 3 mm and 6.5 mm thick, with face sizes reaching 3000 x 1000 mm and a weight of roughly 7 kg/m². Its lower dead load makes it useful for wall cladding, shower walls and some overlay renovations, but the thin panel leaves little room for a poor background. It needs a compatible fibre-reinforced adhesive and a remarkably flat substrate.

Natural stone, including marble, travertine and bluestone, commonly sits around 20 mm to 30 mm in the applications considered here. It's heavier, may vary in thickness between batches and needs sealing. Stone can be superb on a feature wall or benchtop, but its porosity, maintenance and sensitivity to installation conditions make it a more involved choice in wet zones.

Property Porcelain Kerlite Stone
Typical build Dense ceramic body, often rectified Laminated, thin porcelain panel Natural material with variable thickness
Weight profile Ranges from moderate to very heavy Lower dead load Heavy
Finish options Polished, matte and textured Large printed and design-led surfaces Veining and natural variation
Best-fit rooms Bathrooms, laundries, floors and alfresco areas Wall cladding, shower walls and lighter overlays Feature walls and benchtops
Main risk Weight, handling and substrate flatness Background imperfections and adhesive compatibility Sealing, weight and batch variation

The quick rule is simple: choose porcelain when you need a durable general-purpose surface, Kerlite when low wall load and panel scale matter, and stone when natural variation is central to the design and the maintenance commitment is understood.

Substrate, Adhesive, and Joint Decisions That Decide the Outcome

A large-format bathroom survives because three systems work together: the background is flat, the adhesive transfers load across the face, and the joints allow controlled movement. None of those jobs belongs to the tile itself.

Australian baseline guidance under AS 3958.1 identifies maximum plane variation of 5 mm in 3 m for thin-bed ceramic tile installation on a concrete floor and 4 mm in 3 m for wall installation. Australian tiling standards guidance also reflects the stricter approach now used for large panels, where local technical guidance is moving towards 3 mm in 3 m and 1.5 mm in 500 mm from the high spot. Large-format Kerlite and gauged porcelain can turn a minor hump into a visible edge mismatch or a hollow zone.

Prepare the background before choosing the adhesive

Concrete screeds need to be sound, clean, appropriately primed and sufficiently cured. A timber floor may require a suitable fibre-cement tile underlay or another approved system before the membrane and tile build-up begins. Self-levelling compounds and screeds correct a substrate, but they don't remove the need to confirm compatibility with the waterproofing and adhesive system.

Adhesive selection should follow tile size, weight, substrate and movement. Australian large-format guidance treats those factors as engineering controls, not cosmetic preferences. Australian guidance on fixing large-format and heavy tiles gives examples of maximum weight capacities, including 60 kg/m² on mechanically prepared concrete, 32 kg/m² on sand/cement render and 32 kg/m² on Hebel block walls.

The same guidance recommends double-buttering or double-notching, with vertical notch direction to help collapse adhesive ridges and reduce voids, particularly on tiles over 300 mm. A C2 adhesive with S1 or S2 deformability is commonly selected for large-format porcelain where the product and substrate require it. The installer should be able to explain why that classification suits the specific tile, rather than just naming a bag of adhesive.

Joints are part of the structure

Rectified porcelain often uses narrow joints, commonly around 1.5 mm to 3 mm, but the minimum practical joint depends on tile calibration, warpage, layout and manufacturer requirements. Perimeters, structural transitions and changes of plane need movement detailing, generally with a flexible sealant rather than hard grout.

Ask a quote to identify the substrate correction method, adhesive class, coverage approach and movement-joint locations. Tile adhesive guidance for Australian installations is useful background when you're checking whether a proposal describes a complete fixing system or only lists the tile and labour.

Substrate Flatness Tolerance Adhesive Class Trowel Notch Movement Joint Spacing
Concrete floor Confirm project-specific large-format tolerance, with stricter local guidance where required C2S1 or C2S2 where specified Commonly 12 mm or U-notched Perimeter, transitions and designed field locations
Screed Flat, cured and compatible with the membrane system Deformable class suited to tile and background Selected for full transfer Perimeter and changes of plane
Rendered wall Within applicable Australian tolerance Product-approved deformable adhesive Sized to panel and background Corners, junctions and structural changes
Timber floor with underlay Underlay system must be stable and flat Adhesive compatible with tile and board Selected from coverage testing Perimeters and movement zones

Installing Large Format Tile in a Bathroom or Ensuite

A bathroom is a waterproofed assembly with a tile finish, not a tiled box. The sequence matters because a beautiful panel can't correct a failed membrane, an unsuitable fall or a contaminated background.

A six-step infographic guide detailing the professional installation process for large format tiles in wet areas.

Start with inspection and waterproofing

The installer should inspect the substrate, confirm flatness and resolve cracks, high points and low areas before priming. Wet-area falls need checking before the membrane is applied. Australian wet-area guidance states that shower floors must drain without pooling, and shower areas must be waterproofed across the floor and up the walls to at least 1,800 mm, or 50 mm above the shower rose height, whichever is higher. Walls around baths and laundry tubs require waterproofing to at least 150 mm above the fixture. Bathroom waterproofing and tiling guidance outlines these AS 3740:2021 requirements.

Flood testing and membrane inspection should happen before tile installation. The membrane, corners, penetrations, hob junctions and pipe collars need to be complete and compatible with the adhesive system. A membrane doesn't compensate for an uneven wall, so flattening generally belongs before waterproofing where the system permits, with any subsequent preparation carefully controlled.

Fix panels with full contact

Once the waterproofed background is ready, the installer dry lays the pattern, checks cuts around niches and wastes, and confirms that feature veining or bookmatching runs as intended. Adhesive is combed consistently, the panel is back-buttered, and suction-cup lifters help position the piece without twisting it into place.

The tile is then beaten in with suitable tools, joints are cleaned immediately and levelling clips or wedges may assist where the product and joint design allow. Large-format bathroom installation guidance describes a planar target of plus or minus 3 mm over 2 metres and the use of C2 adhesive with S1 or S2 deformability to reduce cracking risk and support full coverage.

Falls must be designed around the drain and tile geometry. The cited bathroom guidance uses 1:80 for bathrooms and 1:50 for showers as practical fall gradients. A large panel may work on a carefully designed bathroom floor, but a conventional multi-direction shower fall often suits smaller pieces better. Internal corners and changes of plane should receive flexible silicone, not rigid grout.

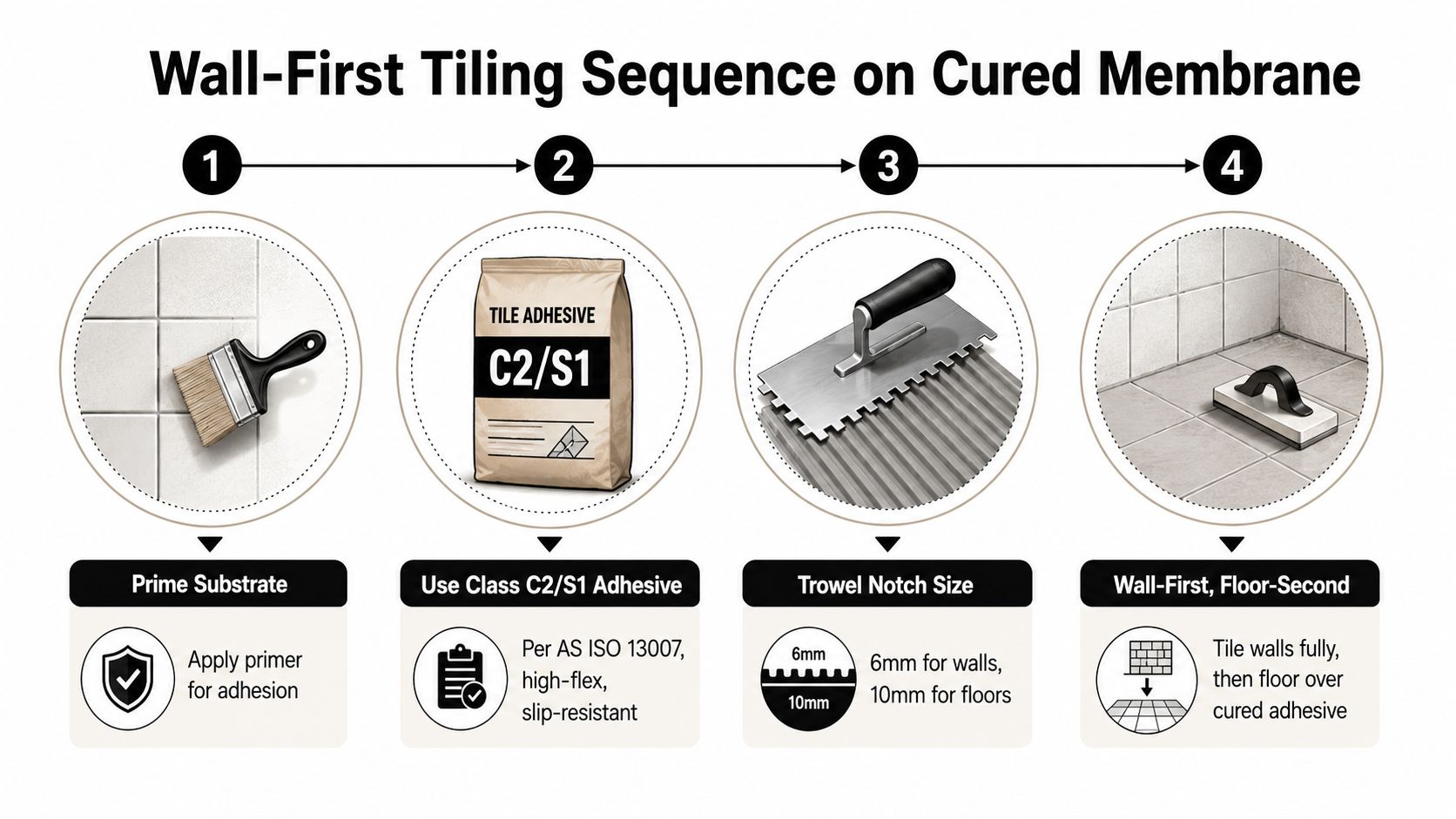

A short installation overview is also shown below.

Where Fewer Grout Lines Stop Being a Benefit

Fewer grout lines can simplify wiping on a wall, but they don't automatically make a bathroom easier or safer to maintain. A 600 x 1200 floor panel still needs the correct fall, cleaning routine and slip-rated finish. Its broad surface can allow water to travel further before reaching the waste, particularly when the floor geometry hasn't been designed around the tile.

Structured and matte surfaces are often more suitable for wet-area floors than polished finishes, but texture can also hold soap residue and mineral spotting. Melbourne homeowners concerned about hard-water marks should choose a finish they can clean consistently, not just the surface that looks smoothest under showroom lighting.

A large wall tile can reduce grout maintenance. A large shower-floor tile can increase installation risk.

Match format to the surface

Walls are usually the strongest application for large panels because the surface can remain continuous and the layout is easier to control. Floors ask more from the tile. They need drainage, traction, edge support and movement detailing, all while carrying foot traffic and wet contamination.

The slip-resistance category should be confirmed from the product documentation rather than assumed from the tile size. The Australian trend towards matte and structured finishes reinforces the practical point that surface finish and wet-area use must be specified together.

Don't confuse a clean look with a flexible assembly

Large panels don't remove movement from a building. Timber floors, concrete transitions, wall junctions and changes of plane can move differently. Without suitable movement joints, a crack can telegraph across a broad panel instead of stopping at a grout line.

For many Melbourne bathrooms, the sensible arrangement is large format tile on walls, with smaller structured tile or mosaic on a shower floor where the fall and grip demand more flexibility. A linear drain and a carefully designed single-plane fall can make a larger floor format more workable, but that decision belongs in the drainage and substrate design, not after the tile has been ordered.

Registered Builders, Contracts, and Warranty in Victoria

The person laying tile and the person responsible for the domestic building contract aren't always the same person. Tiling by itself isn't a trade category that requires registration in every circumstance, but Victorian domestic building thresholds can make registration and contracting obligations relevant to the renovation as a whole.

Victoria requires a registered building practitioner for domestic building work where the total cost, including labour and materials, exceeds $10,000, and registration must be approved before work starts. Consumer Affairs Victoria's registration checklist also makes clear that submitting an application isn't the same as holding approved registration.

Check who carries responsibility

For a bathroom renovation, ask who is coordinating the waterproofing, screeding, plumbing, electrical work, tiling and certification. If one builder controls the complete scope, that builder should explain the registration category, contract arrangement and responsibility for defects.

Consumer guidance states that a major domestic building contract is required for work worth more than $10,000, and that from 1 July 2026 builders must have Home Warranty insurance for work worth more than $20,000. Victoria's guidance on builders and domestic building projects also identifies wall and floor tiling as work that doesn't require registration by itself, while confirming that the overall domestic-building threshold still matters.

A written scope should identify demolition, substrate correction, waterproofing, falls, tile supply, adhesive, grout, silicone, trims, screens, waste protection, curing and handover documents. Clear records help homeowners reduce project risk with contracts, particularly when several trades work in the same wet area.

An infographic showing five key regulations for builders, contracts, and construction warranties in Victoria, Australia.

What a credible proposal should show

Look for a registration check where relevant, a detailed written scope, named waterproofing responsibility and confirmation of the applicable AS 3740 process. The quote should also state how the substrate will be surveyed and corrected, rather than assuming the existing wall or floor is ready.

Home Warranty insurance and contract requirements don't guarantee a perfect tile installation, but they give the renovation a clearer legal and documentary framework. That framework becomes more valuable as the project involves heavier panels, waterproofing interfaces and expensive finishes.

Putting the Renovation Plan Together

A reliable large-format renovation starts with a drawing and ends with a documented handover. Before ordering tile, confirm the room dimensions, door swings, niche locations, waste positions, shower screen lines and the direction of any feature veining. A beautiful slab pattern can lose its impact if the layout leaves narrow edge cuts or places a joint through the focal point.

A six-step checklist graphic outlining the renovation plan process for large format tiling projects.

Build the specification before the quote

Use the following as a site meeting checklist:

  • Confirm the scope: Record demolition, plumbing, electrical work, waterproofing, screeding, tiling, trims, silicone, shower screens and final cleaning.
  • Survey the substrate: Measure flatness, identify structural transitions and decide whether grinding, patching, screeding or self-levelling is required.
  • Specify the tile system: Note the tile thickness, dimensions, weight, finish, adhesive compatibility and intended room.
  • Design the wet area: Resolve AS 3740 waterproofing extents, falls, penetrations, hobs, niches and waste locations before fixing begins.
  • Map movement joints: Show perimeter gaps, changes of plane and any structural transitions on the tile layout.
  • Protect the finished work: Agree curing time, access restrictions, surface protection and the method for cleaning adhesive and grout residue.

The project should also allow realistic lead times for panels, replacement stock, trims and specialist equipment. Large-format tile installation cost guidance can help a homeowner frame the discussion, but the actual price depends on access, demolition, substrate condition, tile selection and the amount of cutting.

Trends worth planning for

Melbourne projects are using thinner Kerlite slabs, bookmatched veining, broad wall cladding, slip-rated outdoor porcelain and more detailed mitred edges. Those finishes look controlled because the layout and fabrication were controlled first. A mitred niche, for example, needs accurate wall geometry, consistent panel thickness and a fixing sequence that protects exposed edges.

At handover, request as-built drawings where relevant, waterproofing and product warranty certificates, care instructions and a documented maintenance schedule. Keep the tile batch information and spare pieces as well. Future repairs are easier when the exact product, finish and joint colour are recorded.

Melbourne Tiling Services P/L provides bathroom and ensuite renovations, waterproofing, screeding, self-levelling and large-format Kerlite, porcelain and stone installation across Melbourne and greater Victoria. For a site-specific assessment of substrate preparation, waterproofing and panel layout, visit Melbourne Tiling Services P/L and request a renovation discussion before choosing the tile size.

Shower Niche Installation: A Practical Step-by-Step Guide

The bathroom is gutted, the old tiles are stacked outside, and the shower wall is finally open to the studs. That's usually when someone decides they want a recessed niche, only to discover that the position affects framing, plumbing, tile layout and waterproofing all at once. A niche cut into the wrong section of wall can leave pipes in the way, create awkward tile cuts or introduce a leak behind a finish that looks perfect.

Good shower niche installation starts before the saw. In Australia, AS 3740:2021 and NCC 2022 treat the niche as part of the wet-area waterproofing system, not as a decorative box. The niche needs a stable substrate, continuous membrane coverage and a base that drains towards the shower. The following process reflects how the work should be planned on a Melbourne bathroom renovation site, with the legal role of registered builders considered alongside the practical work.

Table of Contents

Before You Cut Into the Wall

A homeowner once showed me a shower wall with the cavity already cut. The opening looked square, but a mixer pipe ran straight through the lower corner, the proposed shelf had no fall, and the remaining studs no longer gave the wall the support it needed. The tiles hadn't been selected yet, so the niche would also have forced narrow slivers into the surrounding layout. The expensive part wasn't cutting the opening. It was undoing the decisions made before anyone checked the wall.

Treat the recess as part of the wet area

Under NCC 2022 wet-area provisions, the shower floor must be waterproof, shower walls must be waterproof to not less than 1800 mm above the floor substrate, and shower-area junctions and joints must be waterproof for not less than 40 mm either side of the junction. The NCC wet-area waterproofing provisions make the practical point clear. A recessed opening interrupts the normal wall surface, so the membrane detail must be planned around it.

AS 3740:2021 adds niche-specific requirements. Every niche surface needs a water-resistant substrate, the niche must be separated from the lining on the opposite side of the wall, all surfaces must be fully waterproofed, and the base must fall at least 1:100 towards the shower. Those requirements are why a niche can't be cut into plasterboard and tiled over.

Confirm the site conditions first

Before the cut-out is marked, confirm:

  • Wall construction: Identify whether the wall is masonry, timber frame or steel frame. Each material changes how the opening is supported and how the lining is fixed.
  • Services: Use a stud finder and inspect the exposed cavity for water, waste and electrical routes. Body sprays, mixers and hand-showers need space around the niche, not through it.
  • Framing strength: Check that removing or modifying studs won't compromise the wall. Add proper side supports, a head and a bottom support before installing the lining.
  • Fall direction: Mark the shelf so water runs back into the shower. A level shelf is a defect waiting to become a maintenance problem.
  • Waterproofing plan: Record the niche dimensions, internal corners, penetrations and shelf junctions for the waterproofer.
  • Contract scope: In Victoria, domestic building work costing more than $10,000 in labour and materials, or any building work requiring a permit, must be performed by a person registered with the Building and Plumbing Commission, with registration approved before work starts. The Victorian waterproofing and tiling guidance explains why this matters during bathroom renovations.

Decide early between a preformed foam insert and a custom tile-in niche. A preformed unit can simplify the shape and membrane detailing. A custom recess gives better control over tile modules, width and shelf design, but leaves more responsibility with the framing and waterproofing trades.

Planning Size, Height, and Framing Layout

The right niche is sized around the bottles, the wall structure and the tile grid, not just the visual proportion of the shower. I normally place the selected tile on the floor or draw its module on the wall before finalising the opening. That exposes problems early, such as a niche edge landing halfway through a feature tile or a shelf that can't carry the intended stone slab.

Choose a footprint that suits the wall

Common planning footprints include:

  • Single 600 × 300 mm niche: A practical horizontal recess for everyday bottles where the wall has limited width.
  • Double 900 × 400 mm niche with split shelf: Useful when products need to be separated, but the divider and extra junction add detailing work.
  • Oversized 1200 × 500 mm niche: Appropriate only where the wall, framing and waterproofing plan can support the larger opening, particularly with multiple shower outlets.

Those dimensions are design examples, not compliance dimensions. The niche must still fit the available cavity and preserve the waterproofing envelope.

The main shelf commonly sits in a height band of 1200 mm to 1500 mm at centre, adjusted for the tallest user and the shower rose. A lower shelf may sit around 300 mm above the bath or floor for foot-level storage, but it mustn't become an obstacle or create a difficult-to-clean recess.

An infographic titled Shower Niche Planning detailing standard sizes, optimal placement, and correct framing layout techniques.

Frame for the cavity, then route services

A niche between two studs is the simplest arrangement. A partial-width niche may need a 90 mm noggin to form the lower or upper support, while a heavy stone shelf should be supported with double noggins and appropriate fixings. Don't rely on tile adhesive to carry a thick shelf.

Plumbing needs to be resolved before the wall is closed. Route body sprays, mixers and hand-showers around the proposed opening, leaving enough room for fittings and penetrations. Moving a tap after the membrane has been applied isn't a small adjustment. It creates a new penetration and requires the affected area to be re-waterproofed under AS 3740.

Document the final cavity width, height, depth and shelf positions on the waterproofing plan. The applicator needs that information to detail bond-breakers, internal corners and shelf-to-wall transitions without guessing on the day.

Tools, Materials, and Substrate Choices

A clean niche depends on having the right materials on site before the wall is closed. Substrate compatibility matters as much as the brand of membrane. A primer designed for fibre cement won't automatically be correct for a foam insert, and an untreated timber support can create problems behind an otherwise sound membrane.

Build the job checklist by stage

Framing and inspection

  • Cutting tools: Use a multi-tool or reciprocating saw for controlled openings.
  • Fixings: Keep a drill-driver and suitable 90 mm screws available for framing work.
  • Supports: Use treated pine noggins, a stud finder, spirit level and laser to set the opening accurately.
  • Service checks: Inspect the cavity before cutting, particularly around plumbing and electrical routes.

Plumbing rough-in

  • Testing equipment: A pressure gauge helps the plumber verify the rough-in before the lining is installed.
  • Penetration preparation: Use thread tape where specified and lagging around services where required to protect pipes and reduce movement.
  • Valve planning: The JMJ Plumbing shower valves resource is useful when confirming valve positions and the relationship between plumbing hardware and the niche opening.

Waterproofing

  • Primer: Match the primer to the substrate and membrane system.
  • Membrane: Use the specified Class III acrylic or polyurethane membrane system.
  • Reinforcement: Allow for 100 mm reinforcing bandage at internal corners and shelf-to-wall junctions.
  • Sealing tools: Have silicone sealant, a brush, hawk and wet film gauge ready.
  • Application control: Follow the membrane manufacturer's coverage and curing instructions rather than judging thickness by colour.

Tiling and finishing

  • Cutting and bedding: Select a notched trowel appropriate to the tile, with spacers, spirit level and a tile cutter or wet saw.
  • Edge protection: Use a lipped tile profile where the niche edge needs a crisp, durable finish.
  • Penetrations: Keep a diamond hole saw available for outlets close to the niche.
  • Junction seal: Use compatible silicone at changes of plane instead of forcing grout into corners.

Fibre-cement sheet, including 6 mm or 9 mm compressed sheet for masonry and 6 mm sheet for stud walls, is a common lining option where the system allows it. Foam preformed inserts can reduce framing complexity, while tiled HardieBacker or another approved fibre-cement lining supports a custom tile-in build. Plasterboard isn't suitable as the wet-area niche substrate for this application, MDF swells when exposed to moisture, and untreated pine can rot behind the membrane.

Stage Item Quantity
Framing Treated noggins and approved screws As required for the opening and shelf supports
Lining Water-resistant substrate or preformed foam insert Enough to line every niche surface
Waterproofing Primer and compatible membrane Enough for complete coverage of all niche surfaces and adjoining details
Reinforcement 100 mm bandage Enough for internal corners and shelf junctions, with additional length for overlaps
Finishing Tile adhesive, trims, grout and silicone Based on the selected tile and niche perimeter

For estimating, measure the full niche perimeter and allow membrane and bandage for every internal corner and shelf junction. A one-metre perimeter isn't one metre of bandage in practice if several corners and overlaps need reinforcement, so measure the actual detail rather than buying only the visible edge length. For substrate preparation before lining, use this guide to substrate preparation.

Step-by-Step Shower Niche Installation

The sequence should read like one continuous build. Framing, lining, plumbing, waterproofing and tiling are separate trades, but the niche only works when each stage leaves the next one a sound, documented surface.

Frame and line the opening

Start by scanning the wall and confirming that no pipe or cable intersects the proposed cut. Mark the opening with a laser or long spirit level, then install double studs at each side where the design requires additional support. Fit a bottom plate or noggin that can carry the shelf and establish the fall towards the shower.

Add a head support and any intermediate noggins needed for a divider, shelf or stone slab. Fix the lining cleanly, keeping approximately 6 mm gaps at corners where the waterproofing system requires room for a membrane turn-up and flexible detailing. Don't pack the cavity with weak offcuts or leave a shelf supported only by the wall sheet.

A step-by-step infographic showing the six stages of installing a preformed shower niche in a bathroom.

The substrate controls the rest of the system. Villaboard, another approved fibre-cement sheet or a foam preformed niche each needs the primer and membrane specified for that surface. A preformed insert still needs to be installed exactly as the manufacturer's system requires. It doesn't excuse gaps, unsealed flanges or missing membrane continuity at the surrounding wall.

Waterproof every surface

Before applying membrane, remove dust and prime the substrate. Install bond-breaker tape at all internal corners, including the base, sides, back and shelf-to-wall junctions. Apply the membrane in the specified coats and use a wet film gauge where the system requires measured thickness. The AS 3740:2021 guidance reinforces the central rule. The niche must be lined on all surfaces, isolated from the opposite wall lining, fully waterproofed and built with a minimum 1:100 fall towards the shower.

Allow the membrane to cure fully before any required flood test or tiling. Rushing because the surface feels dry can trap moisture under adhesive and compromise the bond. Under NCC 2022, the niche detail must connect with the waterproofed shower floor, walls, junctions and penetrations rather than ending at the visible tile edge.

Tile for drainage and movement

Dry-fit the niche tiles before spreading adhesive. Keep the layout aligned with the surrounding courses where possible, and avoid placing mitred joints directly on the niche base where standing water and movement make the detail vulnerable. Set the shelf with its fall intact, then tile the back, sides, top and base in a sequence that leaves clean, supported edges.

Use mould-resistant grout on the tile joints, but don't grout changes of plane. The niche corners and niche-to-wall junction should receive compatible silicone so movement doesn't turn into a hairline crack. A carefully selected designer shower enclosures for UK homes reference can also help when coordinating the niche position with the eventual screen line, door swing and visible hardware.

Troubleshooting Waterproofing and Tile Failures

A niche that looks dry during handover can still be poorly built. The common mistake is treating a visible symptom, such as discoloured grout or a damp corner, instead of correcting the waterproofing detail beneath it.

Ponding at the shelf

Water sitting on the base usually means the shelf was installed too flat, or the fall was directed towards the back of the niche. Adding silicone to the front edge won't correct the geometry and may trap moisture. Remove the affected finish, rebuild the shelf with a compliant fall, then re-prime and re-membrane the repaired area.

The applicable AS 3740 niche rule requires a minimum 1:100 fall towards the shower. Some site discussions use steeper falls for practical drainage, but the installed system still needs to meet the relevant standard and product instructions.

Junction leaks and cracked corners

A leak at the niche-to-wall junction often starts with a missing bond-breaker, an unreinforced corner or a membrane that stops short of the adjoining wall. Surface caulk is the wrong repair when the membrane detail is incomplete. The sound approach is to expose the failed junction, install the specified bond-breaker and lap the membrane at least 100 mm onto the substrate where the system requires that reinforcement.

Efflorescence and grout haze can appear when tiling or grouting starts before the membrane has cured. Let the waterproofing system reach its specified cure before covering it. Moisture trapped under the finish has nowhere useful to go.

An infographic showing common tile failure modes on the left and their correct waterproofing solutions on the right.

Movement, mould and inspection

Hairline cracks along the niche base are usually a movement-joint issue, not a request for harder grout. Use silicone at changes of plane and replace failed grout where appropriate. Mould behind a shelf can point to blocked drainage, poor ventilation or detailing that has trapped moisture behind the finish.

Tile selection also affects maintenance. An architect specification guide by Varun Marbles can help compare marble and vitrified surfaces before the niche is tiled. For a Melbourne-specific waterproofing detail, refer to shower niche waterproofing guidance.

After the shower has been used, inspect the niche base with a torch and moisture meter once the shower has run for 10 minutes. This isn't a substitute for proper testing or inspection, but it can reveal early ponding or dampness before the damage spreads.

Time, Cost, and When to Hire a Registered Builder

A single niche can be a compact job or a coordination problem disguised as a compact job. A preformed insert usually reduces shaping and internal detailing. A custom tile-in niche gives more control over the tile layout, shelf material and proportions, but it demands stronger framing and more careful waterproofing.

The following planning ranges apply to a Melbourne bathroom renovation in 2024 to 2025, as specified for this installation comparison:

Install Type Time Cost (AUD) Skill Required Builder Required?
Preformed niche, fully installed 6 to 10 hours across a tiler-and-waterproofer team over two days $650 to $1,400 Experienced tiling and waterproofing knowledge Depends on total domestic building scope and permits
Custom tile-in niche, excluding surrounding wall tiling 6 to 10 hours across a tiler-and-waterproofer team over two days $1,200 to $2,200 Framing, membrane application, tile layout and finishing Depends on total domestic building scope and permits
Owner-builder custom installation Two full weekends Costs depend on materials and hired trades Must understand membrane testing and AS 3740 data sheets Owner-builder requirements may apply

These figures cover the niche scope described, not the entire bathroom. Extra plumbing, structural alterations, demolition, screeding, wall tiling and screen installation can change the project total.

The Victorian threshold changes the responsible party

In Victoria, domestic building work where the total cost of labour and materials exceeds $10,000, or work that requires a permit regardless of cost, must be carried out by a registered builder approved before work starts. A homeowner may instead act as an owner-builder where the legal requirements and certificate of consent apply. That means a bathroom renovation can move beyond a simple tiler-and-waterproofer arrangement once the total contract includes other trades.

Waterproofing should be performed by a suitably certified applicator, with records and product data retained. If you can't read the AS 3740 data sheet or have never tested a membrane, the apparent saving from doing the detail yourself may not justify the repair risk.

For a coordinated bathroom renovation, Melbourne bathroom renovation specialists can be considered alongside independent tilers, plumbers, waterproofer teams and registered builders. Call a tiler for tile layout and finish, a waterproofer for membrane work and certification, and a registered builder when the overall scope or permit rules require one. An independent waterproofing inspector is useful when the substrate, membrane or sequencing is disputed before tiles conceal the work.

Quick Decision Framework and FAQs

A reliable decision can be made before ordering the niche. Confirm the wall depth, service routes and fall direction first. Then choose the system that gives the waterproofer a clear, continuous detail, rather than choosing a product only because its front edge looks neat.

A quick decision framework checklist for professional shower niche installation, highlighting five key steps for success.

Make the decision in this order

  1. Confirm the cavity: Check stud depth, framing strength and service routes before buying a preformed insert or cutting the wall.
  2. Set the drainage direction: Mark the shelf fall towards the shower and verify it with a spirit level.
  3. Choose the construction: Select a tile-in niche for custom proportions and tile control, or a preformed unit when a controlled, system-based installation is more suitable.
  4. Book the trades in sequence: Plumbing and framing come first, waterproofing follows the completed substrate, and tiling starts only after the membrane is ready.
  5. Check the legal scope: Use a registered builder when the domestic building work exceeds $10,000, or whenever a permit is required, as set out in the NCC wet-area provisions.

Common questions

What minimum cavity depth suits a 90 mm tile-in niche?
Allow the full wall cavity and lining build-up, not just the nominal stud dimension. Confirm the finished internal depth with the niche system and tile thickness before framing.

Does a preformed insert still need a full membrane behind it?
It still needs compliant integration with the wet-area waterproofing system. Seal flanges, junctions and penetrations as specified, and don't leave the surrounding wall membrane discontinuous.

What fall is acceptable inside the niche?
The niche base must fall at least 1:100 towards the shower under AS 3740:2021. The finished surface should drain without ponding.

Can an existing tiled wall be retrofitted?
Yes, but it means opening the wall, checking services and rebuilding the waterproofing detail. Removing only the tiles and inserting a box over the existing surface isn't a compliant shortcut.

Can waterproofing be inspected in Melbourne?
Arrange inspection through an appropriately qualified waterproofing practitioner or building professional, and confirm the individual's current Victorian registration or certification before work starts.


Melbourne Tiling Services P/L coordinates bathroom renovations, shower niche framing, waterproofing, screeding and detailed tiling across Melbourne and greater Victoria. Visit Melbourne Tiling Services P/L to discuss your niche layout, obtain a quote and organise the right sequence of registered builders and wet-area trades for the job.

Preventing Shower Leaks: A Practical Melbourne Guide

You notice it when you step onto the carpet outside the bathroom and the fibres feel sodden under your feet. The shower screen looks intact, the tiles still look presentable, and yet the skirting board is swelling or the room below has a faint brown mark on its ceiling. By the time water becomes visible outside the shower, it may already have travelled through joints, penetrations or the substrate.

Preventing shower leaks isn't about buying a better tube of silicone after the damage appears. It starts with the decisions made during a bathroom renovation, including the substrate, floor fall, membrane coverage, drain, screen and the people responsible for signing off the work. In Victoria, registered builders and waterproofing practitioners must work within the AS 3740 and NCC 2022 framework. The practical question is whether those requirements have been properly translated into the shower being built in your home.

Table of Contents

Why Shower Leaks Happen in Melbourne Homes

A shower leak is rarely one dramatic failure. More often, it's a chain of small decisions that drift away from the required construction detail. A membrane may be incomplete, the floor may hold water, a penetration may be left unsealed, or a screen may later be fixed through the waterproofing.

Australian building reviews and consultation material indicate that between 20% and 40% of modern multi-unit residential buildings have some form of waterproofing defect, with leaking showers, bathrooms and balconies repeatedly appearing among the common defect types over the past decade. The same review estimates the annual economic cost of residential apartment waterproofing defects at about A$121 million to A$314 million. These figures are discussed in the Australian review of waterproofing failures, and they explain why a shower shouldn't be treated as a cosmetic tiling job.

An infographic titled Why Shower Leaks Happen in Melbourne Homes, illustrating four main causes and results.

The house type changes the risk

A Melbourne brick home with timber joists doesn't respond to trapped moisture in the same way as an apartment with a concrete slab. Timber framing can move, swell and decay when moisture remains hidden. Concrete won't rot, but water can still migrate through slab edges, wall cavities and service penetrations, damaging finishes and neighbouring rooms.

Older fibro shower rooms, acrylic-lined bathrooms built over timber, and newer tiled apartments may all require different investigation before retiling. A registered builder should identify the existing substrate, check for deflection or swelling, and establish whether the old waterproofing can be retained. Covering a questionable base with fresh tiles doesn't remove the original failure.

Start with the wet-area chain

Think of the shower as a connected system:

  • Substrate: It must be stable, sound and suitable for the membrane and tile system.
  • Fall: Water needs a clear path to the waste rather than a place to pond.
  • Membrane: The waterproof layer must cover the required surfaces continuously.
  • Junctions: Corners, changes of plane, hobs and penetrations need deliberate detailing.
  • Screen and drain: Later fixtures mustn't compromise the waterproofing or obstruct drainage.

Practical rule: If the quote only says “waterproof bathroom” without describing coverage, system and testing, ask for the construction detail before work starts.

The Five Most Common Causes of Shower Leaks

The most useful way to assess a leak is to match what you see on site with the construction decision that failed. A stained ceiling might come from a shower waste, a membrane defect or water escaping at the screen. Guessing from the stain alone often leads to patching the visible symptom rather than repairing the source.

Five failure points worth checking

Missing or incomplete membrane is the first major concern. Renovations sometimes proceed with a tiler applying adhesive and tiles over a surface that was never waterproofed by a properly engaged practitioner. Tiles and grout aren't the waterproofing system. In the shower area, the floor, required wall surfaces, junctions and penetrations all need compliant treatment under the applicable requirements.

Insufficient fall to the waste leaves water sitting against tile edges, seals and junctions. Victorian Building Authority guidance points to a minimum 1:80 fall in shower areas, as outlined in its wet-area waterproofing guidance. A flatter surface may look acceptable once tiled, but it gives water more opportunity to track beneath a screen or remain around the drain.

Failed grout and silicone often appears at the wall-floor corner or at a change of plane. Grout isn't a flexible sealant, so movement can open a joint even when the tiles remain firmly attached. Those junctions need suitable mould-resistant silicone or another specified flexible seal, rather than a hard acrylic product used because it was cheaper or easier to apply.

Unsealed penetrations include mixer bodies, tap spindles, shower rose brackets, niches and screen-related fixings. Each hole through a wet-area surface is a potential route behind the finish. The problem may not show until water has travelled through the lining or framing.

Substrate movement is common where timber joists flex, sheets are compressed, joints aren't properly treated, or the surface wasn't primed for the membrane system. A crack along a grout line can be a finish issue, but repeated cracking, soft lining or movement underfoot points to a base that needs investigation.

Cause What You See On Site Standard Reference
Missing or incomplete membrane Damp lining, loose tiles or moisture outside the shower AS 3740 and NCC wet-area waterproofing provisions
Poor fall to waste Ponding, slow drainage or water sitting at the screen edge AS 3740 guidance, including the 1:80 minimum shower fall
Failed grout or silicone Open wall-floor joints, cracked corners or mould at changes of plane Wet-area junction and movement-joint detailing
Unsealed penetrations Damp around mixers, brackets, niches or fixings Waterproof treatment to shower-area penetrations
Moving substrate Cracked grout, flexing sheets, swollen edges or loose tiles Suitable substrate preparation and membrane-system installation

Building a Leak-Free Shower From the Substrate Up

The finished tile tells you very little about the quality of the waterproofing underneath. A reliable shower is built in sequence, and each stage makes the next stage possible.

Begin with a base that won't move

Remove loose materials and inspect the structural surface. Plywood or compressed fibre-cement sheets should be firmly fixed, joints should be treated as required by the system, and the base shouldn't deflect, swell or carry old water damage. If the substrate is compromised, a new membrane won't turn it into a sound floor.

For a practical explanation of the first stage, see substrate preparation for tiling. The preparation may look slow compared with rolling on a product, but it prevents the membrane and tile finish from being asked to bridge movement they weren't designed to absorb.

Form drainage before waterproofing

The shower floor must fall towards a suitable waste. AS 3740 guidance identifies 1:80 as the minimum fall in shower areas, and the fall needs to be formed before the membrane and tiles are installed. A centrally positioned waste and a linear drain can both work, provided the screed, grate and membrane details suit the assembly.

Don't rely on tile adhesive to correct a poorly formed floor. It creates inconsistent bedding, can leave unsupported tile edges and may produce a surface that still holds water. The drain also needs to be set at the correct height for the tile, adhesive and membrane system.

Apply the specified membrane system

Once the surface is clean and suitably primed, the waterproofer applies the selected system to the required coverage. Liquid acrylic and polyurethane systems are common options, but the product data sheet controls primer choice, coat application, curing and detailing. Corners, hobs, wall-floor junctions, pipe penetrations and drain connections deserve more attention than broad open areas because that's where continuity is most often lost.

The shower walls must be waterproofed to at least 1,800 mm above the floor substrate, and the exact floor and wall coverage depends on the shower configuration. A shower within 200 mm of a wet-area exit requires a vertical water stop, according to guidance on AS 3740 wet-area waterproofing.

The membrane must cure before testing. Don't let tiling start just because the surface feels dry to the touch.

An infographic showing a four-step guide for building a leak-free shower base following construction standards.

A flood test belongs between waterproofing and tiling. Block the waste with a proper test plug, fill only to the prescribed level for the shower assembly, mark the water level and inspect surrounding areas. Australian guidance describes a shallow perimeter test of no more than 5 mm, while standards material refers to filling to the waterstop angle and holding for a minimum of 24 hours. Follow the approved system and test method rather than improvising a deeper fill.

Here is a useful visual reference for the sequence:

Only after a successful test should the tiler install tiles with a compatible flexible adhesive. Finish changes of plane with the specified flexible sealant, then install the screen without piercing the waterproofing where the system doesn't allow it.

Choosing Membranes, Tiles, Grout and Shower Screens

The product written on a quote matters, but compatibility matters more. A membrane, adhesive, tile and screen can each be reputable products and still form a poor assembly if the substrate, primer, cure time or fixing method doesn't match.

Compare the options before signing

Sheet membranes offer consistent factory thickness and can be useful where the installer is experienced with the particular system. They still require careful treatment at seams, corners, drains and penetrations. Liquid membranes suit irregular surfaces and detailed repairs, but the installer must achieve the specified coverage and dry-film thickness across the whole area.

For a clearer look at the membrane stage, review shower waterproofing membrane systems. The cheaper option isn't automatically the weaker option, but a low quote that removes preparation, detailing or testing is a reliability problem.

System Typical Use Pros Watch For
Sheet membrane Planned shower assemblies and compatible proprietary systems Controlled thickness and clear components Seams, corners, drains and penetrations
Liquid acrylic membrane General wet-area construction and suitable repairs Adaptable around details and irregular surfaces Primer, coat thickness and cure
Polyurethane membrane Areas requiring a flexible liquid system Useful movement tolerance when correctly specified Product compatibility and application conditions
Porcelain tile Floors, walls and higher-wear finishes Dense body and broad design range Correct adhesive, cutting and movement detailing
Ceramic tile Wall finishes and suitable bathroom applications Light, workable and available in many formats Body suitability, edge protection and wet-area use
Cement or polymer-modified grout Standard tile joints Familiar application and repairability Porosity, cracking and cleaning
Epoxy grout Joints needing greater stain and water resistance Dense finish and strong chemical resistance Installation skill and difficult cleanup
Framed screen Bathrooms needing a more forgiving enclosure More support and defined sealing lines Tracks, corners and regular cleaning
Frameless or semi-frameless screen Open, contemporary layouts Clean sightlines and less framing Precise floor fall, silicone and fixing details

Tile choice also affects safety and durability. Check the product's wet-area suitability, edge profile and slip characteristics rather than selecting only by colour or showroom appearance. A large format tile can look excellent, but it demands a flat substrate and careful falls, especially around a linear drain.

The screen should direct water back into the shower, not create a new route into the wall or floor. Silicone-to-tile and silicone-to-subsill joints need clean surfaces, correct profiles and a compatible sealant. If a screen installer drills through a membrane without a planned detail, the waterproofing can be compromised after the tiling work has passed inspection.

Routine Maintenance That Keeps a Compliant Shower Compliant

A compliant shower still needs maintenance. Silicone shrinks, surface joints collect soap residue, grout becomes harder to inspect, and drain hair can slow the flow enough to keep water around the enclosure.

Start with a visual inspection every six months. Look at the screen base, hob, wall-floor junction, tap penetrations and corners under a bright torch. You're looking for lifting, splitting, pinholes, discolouration or a seal that has separated from the tile.

Use a simple inspection rhythm

  • Silicone joints: Check the screen, hob and changes of plane for gaps or lifting.
  • Grout lines: Inspect annually with a pointed tool, without gouging the joint.
  • Drain: Remove the grate and clear hair and soap buildup without damaging the waste or seal.
  • Cleaning products: Use products suitable for the tile, grout and sealant. Vinegar and harsh acids can shorten the service life of some finishes and seals.
  • Water behaviour: Notice whether water drains promptly or remains around the screen and corners.

Silicone resealing is commonly planned around every 2 to 3 years, but condition matters more than a calendar alone. A clean, intact joint is normal wear management. Mould that returns quickly, a joint that has opened behind the tile, or moisture outside the shower calls for investigation.

A broader plumbing inspection checklist can help you prevent water damage with a home check, particularly if you manage a rental or have wet areas on more than one level. Use it as a general household check, not as a substitute for a Victorian wet-area assessment.

If a repair reaches the substrate, remove tiles, changes a penetration or disturbs the membrane, treat the work as a new waterproofing event. Let the repaired area dry, reinstate the system correctly and flood test it again before closing the surface.

Warning Signs That Point to Leak Rectification, Not Prevention

Routine cleaning and resealing are appropriate only when the waterproofing assembly remains sound. Once moisture has entered the substrate or adjoining structure, adding another bead of silicone may hide the evidence while the damage continues.

Watch for a combination of visible and sensory clues:

  • Persistent efflorescence: White crystalline deposits can indicate moisture moving through masonry or cement-based materials.
  • Swollen skirting or wall lining: Expansion, soft spots or bulging suggest water has travelled beyond the finished surface.
  • Returning mould: If mould reappears shortly after cleaning, the moisture source hasn't been removed.
  • Musty air: A damp smell in the bathroom, hallway or adjacent room can point to concealed moisture.
  • Ceiling marks below: Brown staining, bubbling paint or damp patches under the shower deserve prompt investigation.

An infographic listing four warning signs that indicate water damage requiring rectification rather than just simple prevention.

A plumber or builder may isolate the waste, carry out a shower-base flood test, inspect the screen and use moisture or thermal imaging equipment to trace the affected area. A pressure test can help separate a plumbing fault from a wet-area waterproofing failure. The aim is to identify the route before demolition, not to guess from the location of the stain.

For a plumbing-focused first assessment, property owners can use detect water leaks in Melbourne as a starting resource. For shower-specific investigation, shower leak detection in Melbourne can help define whether the problem sits with the waste, screen, penetrations or membrane.

Know when the work becomes regulated rectification

In Victoria, waterproofing work must be carried out or supervised by a registered building practitioner, and only registered practitioners can authorise compliance with the applicable standard, as outlined in Victoria-focused AS 3740 waterproofing guidance. Work that penetrates or reinstates the waterproofing should be documented appropriately, including the relevant waterproofing compliance documentation.

Rectification may involve removing tiles, inspecting the lining and framing, replacing damaged substrate, rebuilding falls, reinstating the membrane, testing, then retiling and resealing. The cost depends on how far water has travelled, what must be removed and whether plumbing or structural work is involved. A realistic Melbourne assessment should be based on an inspection and defined scope, not a fixed promise made from a photograph.

Your Melbourne Shower Leak Prevention Checklist

Use this checklist before a bathroom renovation starts, while the shower is open, and after handover. It turns waterproofing from an item buried in a quote into a sequence you can verify.

A checklist infographic titled Your Melbourne Shower Leak Prevention Checklist with four steps for waterproofing bathrooms.

Before the renovation

  • Engage the right practitioner: Confirm who will perform or supervise the waterproofing and check the relevant Victorian registration.
  • Write the standard into the scope: Require the work to address AS 3740 and NCC 2022 wet-area requirements, not just a generic “waterproofing allowance”.
  • Record the system: Ask for the membrane product, primer, coverage, curing requirements and treatment of corners, drains and penetrations.
  • Inspect the existing base: Look for swelling, soft lining, deflection, mould, damaged joists and evidence that water has already travelled beyond the shower.
  • Plan the screen early: Confirm where fixings will go and how the screen will be sealed without compromising the waterproofing.

During construction

  • Check the substrate: Sheets should be stable, clean and suitable for the nominated membrane and tile system.
  • Check the fall: The shower floor needs the required fall to the waste before membrane application. Victorian guidance identifies 1:80 as the minimum shower fall.
  • Check the membrane coverage: Confirm shower walls reach the required height, and that junctions and penetrations have been detailed.
  • Wait for cure: Don't accept tiling just because the membrane looks dry.
  • Witness the flood test: The test should use a proper plug, the correct fill level and a minimum 24-hour hold, with the surrounding areas inspected.
  • Confirm compatible finishes: Adhesive, grout, tile and sealant should suit the substrate, membrane and wet-area conditions.
  • Review screen fixing: The installer should avoid unplanned penetrations through the waterproofing.

After handover

  • Inspect silicone twice yearly: Look at the screen base, hob, corners and penetrations.
  • Inspect grout annually: Use a torch and look for cracks, hollow tiles, open joints or repeated mould.
  • Keep the waste clear: Remove hair and residue before drainage slows.
  • Treat alterations seriously: Any plumbing change, tile removal or membrane repair should trigger drying, reinstatement and another flood test.
  • Keep the paperwork: Retain product records, photos, compliance documentation and the renovation scope.

A failed flood test means the shower isn't ready to close up. Multiple substrate symptoms, such as soft lining combined with mould or swelling, mean maintenance has ended and rectification should begin. Call a registered Victorian builder before the damage spreads into framing, flooring or the room below.


For bathroom renovations, Melbourne Tiling Services P/L provides coordinated waterproofing, screeding, tiling, shower screen installation and shower or balcony leak rectification across Melbourne and greater Victoria. Visit Melbourne Tiling Services P/L to discuss your shower, request a quote and establish a compliant prevention or rectification scope before tiles go down.

Bathroom Tiling and Waterproofing Guide for Melbourne Homes

You've stripped out the old bathroom in a Melbourne home, the plumber has finished the rough-in, and the room is finally starting to resemble the design you approved. Then the tiler asks a question that can't be postponed: what exactly is being waterproofed, and what evidence will be provided before the first tile is fixed? That decision matters more than whether you choose porcelain, marble or a patterned feature tile.

A bathroom can look perfectly finished while hiding a failed membrane, a poorly detailed puddle flange or falls that leave water sitting at the shower entrance. Bathroom tiling and waterproofing are one compliance system, and the tile finish is only the visible part. In Melbourne renovations, the durable result starts with the substrate, drainage, membrane, documentation and trade sequence.

Table of Contents

Planning a Bathroom Tiling and Waterproofing Project

Lock in the scope before ordering materials

Start by defining the wet area. Is the membrane limited to the shower, or will the entire bathroom floor and additional wall zones be treated? A hob, a frameless shower, a recessed niche, a linear drain and a set-down all change the preparation and detailing. The waterproofing scope drives labour, materials, curing time and tile quantities, so choosing tiles first often produces an inaccurate renovation price.

Demolition also needs a proper decision. Confirm what will be removed, who will dispose of it and whether the building may contain asbestos, particularly in older homes. Pre-1990s construction deserves careful checking before fibro sheeting, old floor coverings or wall linings are disturbed. Don't let a tiler arrive to find that the substrate is unstable, contaminated or still covered in demolition waste.

Identify the existing substrate before specifying primers and membranes. Fibro, plasterboard, brick, concrete, Scyon and existing tile surfaces behave differently. The plumber should also confirm fixture locations, pipe penetrations, the floor waste and the finished floor height before waterproofing begins. A change to the vanity, toilet, shower rose or waste after membrane work can create a new penetration and compromise the system.

A checklist for bathroom renovation showing six steps including rip-out, plumbing, and booking a tiler.

Sequence the trades, then keep the records

A reliable sequence generally has the carpenter preparing framing and linings, the plumber completing rough-in work, the waterproofer preparing and coating the wet area, the tiler installing the finish, the electrician completing fit-off, and the glazier measuring and installing the shower screen. The exact order can vary, but the membrane must be protected from avoidable damage after certification.

Keep a project file containing:

  • Approvals and permits: Retain the building permit and any relevant project approvals.
  • Waterproofing evidence: Keep the waterproofing compliance certificate, product information, photographs and test records.
  • Builder documentation: For work over $16,000, retain the relevant VBA documentation and builder records. The threshold and Victorian practitioner pathway should be confirmed for the specific contract and scope.
  • Product details: Record membrane, primer, sealant and adhesive batch information where available.
  • Variation history: Put changes to drains, niches, shower screens and tile layouts in writing.

Practical rule: Don't approve tiling because the room “looks ready”. Approve it when the substrate, membrane, curing and inspection evidence are ready.

Before waterproofing, check that the demolition is complete, the substrate is clean and stable, plumbing penetrations are fixed, the waste is correctly installed, falls are formed, corners are detailed and the final fixture layout is signed off. That checklist prevents the expensive return visit caused by a late plumbing change or a membrane punctured by another trade.

Waterproofing Standards and Membrane Choices

What the Australian standard controls

Australia's current bathroom waterproofing baseline is AS 3740:2021, published on 23 July 2021 and superseding AS 3740:2010. It defines minimum requirements for waterproofing materials, design and installation in domestic wet areas, including wet areas in Class 1, 2 and 4 buildings under the NCC, with wider application to relevant Class 3 to 9 wet areas as described in the standard. The standard was adopted by NCC 2022 on 1 May 2023, which is why the compliance framework matters directly to current Melbourne bathroom renovations. See the AS 3740:2021 standard reference and the Standards Australia product listing.

The shower floor must be waterproof. Shower walls need waterproofing to at least 1,800 mm above finished floor level, or 50 mm above the shower rose, whichever is higher. Relevant wet-area wall conditions also include a minimum of 150 mm above finished floor level outside the shower zone. These dimensions protect the substrate behind the tiles. They aren't a substitute for correct corners, penetrations, junctions or drain detailing.

A membrane system also has to suit the substrate and the intended wet-area application. Acrylic roll-on systems are common because they're practical for many residential layouts and can be applied around irregular corners. They depend heavily on correct primer selection, film thickness, reinforcement and curing between coats. A rushed single coat is not a waterproofing strategy.

Two-part polyurethane systems can provide a continuous coating, but they demand accurate mixing, careful application and controlled curing. Sheet systems, including products such as Schluter Kerdi, can offer consistent factory-controlled thickness and dependable overlaps when installed correctly. They're less forgiving of poor joint preparation, awkward penetrations and detailing that hasn't been planned before the sheet is cut.

Comparing practical membrane systems

Membrane Type Cost per m2 (AUD) Cure Time Best Application
Acrylic roll-on Varies by product and scope Product-dependent, between coats and before tiling Standard residential bathrooms with prepared substrates
Two-part polyurethane Varies by product and scope Product-dependent, with controlled mixing and curing Demanding wet-area detailing and compatible substrates
Sheet membrane Varies by product and scope Adhesive and joint system dependent Planned shower systems requiring controlled sheet overlaps

The figures above are deliberately qualitative because membrane pricing depends on access, preparation, penetrations, floor shape and product specification. A contractor should provide the selected system, primer, compatible sealants, required dry film thickness and curing instructions rather than quoting a membrane as an unnamed bucket of product. The shower waterproofing membrane guide can help homeowners understand the system choices before approving a scope.

The details that cause trouble are usually small. Shower tap penetrations, niche corners, internal wall-floor junctions and the puddle flange at the floor waste all need deliberate treatment. The membrane must bond to compatible surfaces and remain continuous around each penetration. Where a tiler also performs the waterproofing, ask who is responsible for inspection and certification. The concern isn't that one person can never do both tasks. It's that the person paid to continue into tiling may have a commercial reason to declare the membrane ready before every detail has been properly checked.

Screeding, Self-Levelling and Getting the Falls Right

A membrane can't correct a floor that sends water away from the waste. Screeding shapes the drainage plane, while self-levelling compound corrects suitable low spots and creates a flatter surface where a true fall isn't required. A pre-formed shower tray provides a manufactured fall and drain arrangement, but it still needs compatible waterproofing and accurate connections to the surrounding floor.

Australian guidance identifies a general wet-area floor fall of at least 1:100, or 10 mm per metre, to move water towards drainage and reduce ponding risk. The NCC wet-area provisions also describe fall requirements that can include a continuous fall between 1:80 and 1:50, depending on the application. Check the applicable detail for the exact bathroom design rather than assuming a steeper slope is automatically safer. Excessive fall can create its own compliance and usability problems.

Shape the floor for the actual drain

A centred waste normally needs a four-way fall. Each plane rises towards the walls, and the tile layout has to accommodate the resulting changes in angle. A linear drain allows a two-way fall and can suit larger tiles, but only if the drain is installed level and the surrounding screed reaches it without hollows.

For example, a brick shower base may need a bonded screed that forms the fall from the perimeter to a puddle flange. Outside the shower screen, the screed may need to feather into the tile underlay while preserving the required drainage direction. A frameless screen can also require a meaningful height relationship between the shower area and the rest of the bathroom, so the finished tile build-up must be designed before screeding.

Self-leveller won't hide a dropped slab, a hollow section or a structurally moving substrate. It also won't solve an incorrectly positioned waste. Those defects need correction first, otherwise a smooth-looking compound only creates a smooth-looking version of the same drainage problem.

A diagram illustrating the three steps of bathroom floor preparation including screeding, leveling, and drainage.

The timing matters just as much as the mix. Tiling over a screed before it has reached the product's required cure condition risks weak adhesion, trapped moisture and movement beneath the tile. Ask the installer to identify the product, application date and cure requirement in the site records before tiles are laid.

The video below illustrates the relationship between floor preparation and tile installation.

For a closer explanation of substrate shaping and preparation, review this guide to screeding for bathroom tiles.

Tiling Sequence, Adhesives, Grout and Sealants

The tiling crew should start only after the membrane has fully cured and passed the agreed inspection process. Wall layout is set from a datum line, not from the first visible corner. That line determines where cuts land around the vanity, shower screen and doorway, and it prevents a room from looking skewed because the installer followed an out-of-square wall.

Walls are generally tiled before the floor so the floor finish can run neatly into the wall junction and avoid unnecessary damage during wall work. If a ledger board is needed to support heavy or large-format tiles, every fixing point must be repaired and waterproofed in accordance with the membrane system before the area is closed.

An infographic illustrating the four-step wall-first tiling sequence on a cured waterproof membrane for bathroom installation.

Match the adhesive to the tile and substrate

Adhesive selection should account for tile size, tile absorption, substrate movement and the wet-area system. A basic C1 adhesive may suit limited stable applications, while C2 adhesives and deformable classes such as S1 or S2 are commonly considered where stronger adhesion and flexibility are required. The classification should be checked against AS ISO 13007, the tile manufacturer's instructions and the membrane manufacturer's compatibility requirements.

The trowel notch isn't a decorative preference. The installer selects it to achieve adequate coverage, then collapses the ridges by laying tiles in a consistent direction. Large-format and rectified tiles expose poor coverage quickly, especially around shower floors, niches and edges. The substrate needs to be flat enough for the tile, and the adhesive bed needs to support the tile without voids that can transmit movement or allow water to collect.

Use movement joints at internal corners and perimeter changes rather than filling every junction with rigid grout. Cementitious grout is practical and repairable, but it needs correct mixing, cleaning and maintenance. Epoxy grout resists staining and water absorption more effectively in suitable applications, though it costs more and requires disciplined installation.

Corners, wall-floor transitions and changes of plane should normally receive sanitary silicone compatible with the tile and membrane system. Grout in a moving corner is a common shortcut, not a movement joint. The sealant also needs adequate cure time before the shower is exposed to water.

A neat grout line can't compensate for the wrong adhesive, poor coverage or a joint that should have been flexible.

The final fit-off should protect the finished work. Avoid drilling through tiled waterproofed zones without a planned sealing method. Shower screens, accessories and shelves need fixings that don't create unsealed paths into the substrate.

Common Failure Points and How to Verify the Work

Good-looking tiles prove very little about waterproofing. The defects I'm most concerned about are usually hidden beneath a clean finish, where the puddle flange wasn't clamped correctly, the membrane stopped short at a junction or a later fixing punctured the system.

Small omissions create large repairs

A membrane applied below the specified dry film thickness may look complete while failing to provide the intended protection. The second coat matters where the approved system requires it, and the applicator should follow the product's coverage and thickness instructions rather than judging the finish by colour alone.

Corners and changes of plane need reinforcement or bond-breaker detailing where required by the system. If the wall-floor junction is grouted instead of sealed, movement can open a path behind the tile. A screed flatter than the applicable drainage requirement leaves water at the shower base, while tiling over a failed screed conceals the defect.

Common warning signs include:

  • Loose or drummy tiles: Hollow sounds can indicate poor adhesive coverage, substrate movement or a bond problem.
  • Efflorescence: White crystalline deposits may indicate moisture movement through the substrate or joints.
  • Persistent mould: Mould that repeatedly returns at the shower base can point to retained moisture, failed sealant or inadequate drainage.
  • Cracked junctions: Cracking at corners and wall-floor transitions often indicates that rigid grout has been used where movement accommodation was needed.
  • Recurring dampness: Damp adjoining walls, ceilings or skirtings require investigation rather than another bead of silicone.

Ask for evidence at every hold point

Photographs should show the prepared substrate, penetrations, corners, puddle flange, membrane coats and any reinforcement before the tiles cover them. Keep the membrane product name, batch details, applicator information and the completed waterproofing certificate in the project file.

A flood test should be recorded before tiling where the system and site conditions permit it. The evidence should show the test area filled to the agreed level, the start time, the inspection period and the result. Guidance for Australian bathroom waterproofing commonly identifies a 24-hour flood-test period, and the test should be completed before tile installation, not after a leak appears. See the Australian waterproofing defect guidance for the wider defect context.

The certificate needs to be appropriate to the work and the Victorian compliance pathway. Ask for the practitioner's details and the relevant VBA documentation instead of accepting a text message that says “waterproofed”. Product data sheets should also confirm that the membrane is suitable for the intended application, including compatibility with the substrate, adhesive and sealants.

Inspection evidence is part of the bathroom, even though it disappears behind the tiles.

If a contractor refuses to photograph concealed work or can't explain the test process, pause before approving the next stage. A tile finish can be repaired. A concealed membrane failure may require removal of tiles, screed, fixtures and adjoining linings.

Timelines, Costs and When to Hire a Registered Builder

A complete Melbourne bathroom renovation commonly takes three to five weeks, depending on the scope, access, structural work, product availability and the number of trades involved. Strip-out, plumbing rough-in, substrate correction, screed curing, membrane coats, flood testing, tiling, grouting and fit-off each create dependencies. A delay in one stage can leave several trades unable to proceed.

A straightforward cosmetic re-tile is a different engagement from a full renovation. If the existing membrane and substrate are sound, the work may be limited to tile removal, preparation, adhesive, new tiles and joints. If the shower leaks, the floor waste is defective or the substrate has moved, the job becomes a waterproofing and rectification project before new tiles are even considered.

Understand what changes the price

There are no reliable universal Melbourne rates for bathroom tiling and waterproofing because preparation often costs more than the visible installation. A small bathroom with difficult access, multiple niches, a frameless screen, large-format tiles or a herringbone layout can require more labour than a larger room with simple geometry.

Scope Element Cost Range (AUD) Notes
Waterproofing Project-dependent Changes with wet-area coverage, penetrations, corners, substrate preparation and membrane system
Screeding and floor preparation Project-dependent Depends on falls, waste position, slab condition, levelling and finished floor height
Tile supply Project-dependent Influenced by tile material, size, finish, wastage and pattern
Tile labour Project-dependent Large-format, rectified, stone, mosaics and complex layouts require additional control
Leak rectification Project-dependent Can expand when failed screeds, membranes, linings or adjoining areas need removal

A transparent quote should separate demolition, disposal, carpentry, plumbing, electrical work, waterproofing, screeding, tile supply, tiling, grout, sealants, shower screen and fit-off. The cost of bathroom renovation in Melbourne varies with precisely these scope decisions, so a single allowance for “bathroom tiles” doesn't provide a useful comparison.

Choose the right practitioner

In Victoria, bathroom, kitchen and laundry renovations commonly fall within the registered Domestic Builder pathway. A limited registration needs to be the DBL-L category for bathroom, kitchen and laundry renovations, while a Domestic Builder Unlimited registration covers a broader range of domestic building work. Confirm the registration, contract requirements and permit position for the actual project rather than relying on a trade label. The Australian state bathroom renovation regulation overview provides background on the Victorian pathway.

Work over $16,000 needs particular attention to Victorian builder documentation and the registered builder requirements. Structural waterproofing, altered layouts, new plumbing, wall removal, floor changes and significant rectification aren't suitable for an informal tiler-only arrangement. A tiler-only engagement makes sense for a cosmetic re-tile only when the underlying membrane, falls and substrate have already been properly assessed and remain sound.

Your contract should identify who prepares the substrate, who applies and certifies the membrane, who performs the flood test, what products are approved, how variations are authorised and what warranty documentation is supplied. It should also state who is responsible if another trade damages the waterproofing after certification.

For homeowners who want one coordinated scope, Melbourne Tiling Services P/L provides bathroom and ensuite renovations, waterproofing, screeding, self-levelling, tile installation and frameless shower-screen installation, with registered builder coordination across the relevant trades. The practical advantage of a coordinated engagement is clearer responsibility for the sequence, not a promise that documentation can be skipped.


If your Melbourne bathroom needs more than a tile refresh, ask Melbourne Tiling Services P/L to assess the substrate, drainage, waterproofing scope and trade sequence before work starts. Visit Melbourne Tiling Services P/L to discuss a documented bathroom renovation, waterproofing or leak-rectification plan and request a quote.

Shower Niche Waterproofing: A Complete Guide

You've finished a Melbourne bathroom renovation, the tiles look flawless, and the shower niche has become the room's neatest feature. Then, months later, a faint watermark appears on the adjoining wall. The grout still looks sound, so the cause isn't obvious. Often, the trouble began behind the niche, where a missed junction, flat shelf, unsealed penetration, or poorly integrated membrane allowed water into the wall assembly.

Shower niche waterproofing isn't a decorative upgrade. It's part of a regulated wet-area system governed by the National Construction Code and AS 3740:2021. The substrate, framing, membrane, bond breakers, falls, penetrations, tiles, and shower-screen detailing all have to work together. This guide follows the practical sequence used on Melbourne bathroom renovations, including the registration obligations that apply to builders and waterproofers and the frameless-screen details many generic guides leave out.

Table of Contents

Why a Shower Niche Is the First Place a Bathroom Leaks

A common rectification call starts with a renovation that appears complete. The homeowner has used the shower for months without noticing anything unusual. Then a discoloured patch appears on the wall beside the bathroom, paint begins to blister, or the ceiling below shows a damp mark. By the time the symptom is visible, the niche may have been receiving water every day.

A recessed niche interrupts the otherwise continuous wall plane. That creates more internal corners, more substrate joins, more membrane transitions, and often a penetration for lighting or plumbing. The base also becomes a small horizontal surface where water can sit if the fall is missing or directed the wrong way.

Stained wall next to a shower showing signs of water damage, highlighting potential shower niche waterproofing issues.

Where the water gets in

The membrane itself is rarely the only issue. In failed niches, the vulnerable points are usually:

  • Internal corners: The back, side, and base junctions need compatible fillets or bond-breaker detailing so movement doesn't open a direct path behind the membrane.
  • Shelf bases: A level shelf can hold water against the rear corner rather than directing it towards the shower.
  • Penetrations: Mixer outlets, pipework, niche lighting, and screen fixings all need compatible sealing.
  • Wall transitions: The niche lining must connect with the surrounding wet-area substrate without leaving an unprotected break in the waterproofing plane.

Australian guidance places the shower floor and shower walls within a defined waterproofing zone. Under the NCC 2022 wet-area waterproofing provisions, shower walls must be waterproofed to at least 1800 mm above the floor substrate, and wall junctions and joints within the shower area require waterproofing for at least 40 mm either side of the junction. A niche sits inside that regulated zone, so it must be treated as part of the assembly, not patched as an afterthought.

Practical rule: If the tiler can't show how the niche membrane joins the surrounding wall membrane, the tiles are hiding a risk rather than finishing a compliant detail.

Rectification is disruptive because the visible repair is only the beginning. Tiles may need removal, the niche substrate may need to be opened, the membrane may need to be reinstated, and the wet area may require another test before retiling. Spending time on framing, substrate preparation, membrane continuity, falls, and inspection before tiling is far cheaper than diagnosing a stained adjoining room later.

The Code and Registration Baseline Every Melbourne Project Should Meet

The starting point is AS 3740:2021, which sets minimum waterproofing requirements for domestic wet areas in Class 1, 2, and 4 buildings. It also applies to wet areas in Class 3 to 9 buildings as if they were Class 2 or 4 parts of a building, making it relevant beyond detached homes and standard apartment bathrooms. The Standards Australia description of AS 3740:2021 identifies it as the core standard for materials, design, and installation of waterproofing in these wet areas.

The NCC 2022 provisions translate that framework into practical coverage. The shower floor, including a hob or step-down, must be waterproof. Shower walls need waterproofing to at least 1800 mm above the floor substrate, while shower-area wall junctions and joints require coverage for at least 40 mm on either side. Penetrations also need sealing, which matters around mixers, shower outlets, shelves, and any niche lighting.

Falls and shower risk categories

The finished shower floor must fall towards the waste between 1:80 and 1:50. The Australian Building Industry Services information on waterproofing explains that this range corresponds to 12.5 mm to 20 mm per metre. The Victorian Building Authority treats both enclosed and unclosed showers as Category 1 high-risk areas, with a minimum 1:80 fall in shower areas. The VBA material also identifies 1:100 where vertical separation applies and no fall requirement for a Category 3 area where an enclosed shower retains water, conditions that shouldn't be casually applied to an open or frameless design. These distinctions are set out in the VBA wet-area waterproofing practitioner material.

A summary of AS 3740-2021 code baseline requirements for residential waterproofing and installer registration.

Registration questions to ask

Victoria separates bathroom renovation work from waterproofing work through different domestic builder categories. The Victorian regulations include a class limited to bathroom, kitchen and laundry renovation, and another class limited to waterproofing, so a renovation builder and a waterproofing practitioner aren't automatically the same registration scope. The relevant categories appear in Schedule 12 of the Victorian Building Regulations.

Victoria also requires registration to perform domestic building work over $10,000 in labour and materials, or to carry out building work requiring a permit regardless of cost, as explained by Consumer Affairs Victoria's registered practitioner guidance. Before signing a quote, ask:

  • Who holds the registration: Confirm the builder's registration class and the waterproofer's relevant scope.
  • What the quote includes: Check that framing, substrate, falls, membrane, penetrations, testing, and documentation aren't excluded.
  • Which system is specified: The membrane needs to be compatible with the substrate, adhesive, corners, collars, and tile finish.
  • What evidence you'll receive: Ask for photographs, product details, and test records before tiling covers the work.

For a renovation, a waterproofing compliance certificate in Victoria should form part of a properly documented handover where applicable.

Preparing the Framing, Substrate, and Falls Before Any Membrane

A niche can't be waterproofed properly if the opening moves, the lining is unsuitable, or the shelf starts flat. Preparation decides whether the membrane has a stable, continuous surface to protect.

Build a rigid opening

The niche opening should be framed with plumb studs and solid noggings. The upper and lower members need to support the lining and shelf without flexing, while the opening must avoid clashes with plumbing, electrical services, insulation, and structural elements. A wide horizontal niche deserves particular caution because removing too much existing framing can reduce wall stiffness. If the wall is structural or external, the builder needs to resolve that issue before the niche is cut.

The lining choice depends on the system and site conditions. Fibre cement sheet, compressed sheet, and proprietary foam tile backer can all be suitable when used according to their product instructions and integrated with a compatible membrane. The important point is continuity. A waterproof niche box installed against a poorly prepared opening still leaves a weak perimeter.

A prefabricated niche saves time only when its flange, substrate, membrane, and surrounding wall have been designed as one detail.

The niche lining must cover the back, sides, top, and base. AS 3740:2021 material quoted in this technical reference on niche waterproofing requires all niche surfaces to use a water-resistant substrate, with the niche separated from the lining on the opposite side of the wall. That separation matters where the recess would otherwise press directly against or share a vulnerable lining on the other face.

Establish the falls before coating

The niche base needs a minimum 1:100 fall towards the shower. That requirement is separate from the main shower-floor fall. A tiler can create the niche slope by packing, screeding, or forming the substrate before the membrane is applied, but the method must leave a sound, even surface.

The base should fall out of the recess, not towards the back wall. The back and side corners need to remain clean and continuous so water can travel across the shelf and out rather than collect in the rear junction. A registered waterproofer should check the substrate for dust, contamination, loose material, and excessive moisture, then use the specified primer before applying the membrane.

A four-step infographic illustrating the preparation process for building a shower niche, featuring construction diagrams.

The practical order is straightforward:

  1. Frame the opening: Make the structure square, plumb, and adequately supported.
  2. Install noggings: Provide firm support for the shelf and each lining edge.
  3. Install the substrate: Line every niche face and keep it separated from the opposite wall lining where required.
  4. Set the fall: Form the base slope before membrane application and confirm that it drains towards the shower.

A short site video can help illustrate the construction sequence, but it doesn't replace the membrane manufacturer's instructions or the registered waterproofer's inspection.

Sheet Membrane Versus Liquid Membrane for a Shower Niche

Both sheet and liquid membranes can produce a reliable shower niche when the products are compatible and the installer follows the system requirements. Neither option fixes poor framing, a flat shelf, contamination, or an unsealed penetration.

Criterion Sheet Membrane Liquid Membrane
Internal corners Preformed corners and proprietary tapes can make geometry consistent. The material conforms to complex shapes but needs careful reinforcement at corners.
Application control Coverage is visible, with overlaps and bonding carrying the main risk. Coat thickness, drying, and recoating windows carry the main risk.
Speed Fast on prepared, regular surfaces. Flexible for custom shapes, but requires curing between stages.
Common failure Poorly bonded overlaps, wrinkles, or incomplete corner adhesion. Thin spots, pinholes, or coating applied before the previous layer is ready.
Best fit A clean, stable niche with a compatible proprietary detailing system. A complex recess where an experienced applicator can control coverage and curing.

What works on site

Sheet systems are useful where the niche has crisp, predictable geometry. The membrane is cut to suit the back, sides, top, and base, then joined with compatible tapes or corner pieces. Overlaps must be fully bonded, pressed free of wrinkles, and integrated with the surrounding wall membrane. A sheet that appears to cover the area but isn't properly bonded at an edge is not a finished waterproofing detail.

Liquid polyurethane and acrylic systems are more forgiving around irregular geometry because the coating follows the substrate. That flexibility comes with discipline. The waterproofer needs to apply the specified coats at the specified coverage, allow the correct drying period, and avoid trapping moisture between layers. Cold and humid Melbourne conditions can make rushed recoating particularly risky.

The membrane system should also suit the tile adhesive and substrate. Product instructions govern primers, reinforcement, curing, and compatibility, so choosing a brand from a catalogue without checking the complete system is poor practice. A useful shower waterproofing membrane service overview can help homeowners understand what should be discussed, but the installer still needs to nominate the actual compatible system for the project.

Treat corners and penetrations as separate details

At wall-to-floor and wall-to-niche junctions, the applicator uses compatible fillets, bond-breaker tape, or the proprietary equivalent. These details accommodate movement and help the membrane remain continuous through a change in plane. Mixer outlets, shower penetrations, and niche lights need collars or reinforced detailing, not a casual smear of membrane around the pipe.

The choice between sheet and liquid should follow the geometry, substrate, enclosure, and applicator's demonstrated skill. Brand loyalty is a poor substitute for a complete, documented system.

Flashing, Taping, and the Niche Base That Drains

A niche must drain into the shower, not function as a small tiled shelf that holds water. The membrane covers the back, sides, top, and base, then turns into each junction with compatible fillets or bond breakers. All niche surfaces require waterproofing, with a minimum 1:100 fall towards the shower under the applicable wet-area requirements, as noted earlier.

Form the internal corners

Sharp changes of plane can thin a membrane, leave gaps beneath reinforcement, or crack when the framing moves. The applicator prepares each junction, installs the specified fillet or bond-breaker tape, and dresses the membrane continuously over the detail. Back and side upturns must remain continuous, with no pinholes or open lower corners.

The niche base should slope outward into the shower. A single sloping shelf is easier to clean and inspect than a concealed step or complicated channel. A drained shelf can work, but it adds an outlet, another junction, and another component requiring compatible products and ongoing cleaning. A full-width niche also needs stronger framing and more accurate tile setting than a compact recess.

An infographic detailing shower niche waterproofing steps, including upturns, taping, base drainage, and shelf angle techniques.

Connect the niche to the floor system

The wall membrane must join the floor membrane, which then dresses into a compatible floor-waste flange or puddle-flange arrangement. Waterproofing is incomplete if it stops short of the waste, finishes behind an unsealed penetration, or leaves the shower-screen line outside the planned wet-area detail.

The main shower floor fall remains between 1:80 and 1:50, or 12.5 mm to 20 mm per metre, under VBA guidance and the AS 3740 framework. A shower drainage installation service should coordinate the waste, screed, membrane, tile thickness, and finished levels. The grate is not a trim item to position after everything else.

Frameless screens change the exposure

Frameless and walk-in screens let more spray reach the wall and niche opening. The screen rail, channel, and fixing line must be planned before membrane application, especially where a waterstop sits beneath the rail. Drilling through a completed tiled wall can breach the waterproofing when the fixing detail was not allowed for during construction.

An enclosed shower contains spray more effectively, but it does not correct poor niche detailing. An open shower exposes more wall area, so the designer, builder, waterproofer, and screen installer need agreed falls and water-containment details before tiling begins. This coordination is where many otherwise neat niches fail.

Leak Testing, Sign-Off, and Documentation Before Tiling

Waterproofing should be inspected before tile adhesive hides it. A visual check looks for missed corners, pinholes, uncoated substrate, damaged membrane, incomplete collars, and poor transitions around the niche. It should also confirm that the shelf still has its intended fall after all reinforcement and coating have been applied.

Run a controlled flood test

Where the construction and project requirements call for it, the shower area can be temporarily flooded and held for the standard 24-hour period. The NCC wet-area waterproofing provisions provide the broader regulatory context for wet-area waterproofing, while the site team must follow the applicable testing method and membrane instructions.

Before filling, the tester marks the water level and protects openings and test drains appropriately. During the hold period, the adjoining room, skirtings, ceiling below, penetrations, and accessible edges should be checked for moisture or movement in the level. A niche may not be the lowest point, so the inspection must cover the whole wet zone rather than focusing only on the recess.

If the test fails, the team shouldn't just dry the area and tile over it. The membrane system needs diagnosis. A localised defect may allow a controlled repair followed by another test, but widespread separation, missing coverage, or a poor floor-to-wall connection can justify removing and rebuilding the wet-zone membrane.

Record the work

A useful handover file includes:

  • Photographs: Capture the substrate, niche corners, membrane coverage, penetrations, waste connection, and screen-zone detail before tiling.
  • Product records: Keep membrane and primer names, batch numbers, and manufacturer instructions.
  • Application notes: Record coat sequence and applied thickness where the system requires it.
  • Site checks: Include substrate moisture readings, preparation notes, and inspection dates.
  • Test evidence: Note the test method, water level, duration, observations, and any repairs.

Once tiling begins, later diagnosis becomes slower and more destructive. Documentation gives the owner and builder a clear record of what was installed, and it provides useful evidence if a warranty or rectification question arises.

Common Shower Niche Defects, Fixes, and Long-Term Maintenance

A neat tile finish can conceal a badly performing niche. The recurring defects in Melbourne rectification work are usually simple geometry or detailing mistakes, not mysterious product failures.

The failures that keep returning

Ponding on the shelf usually means the base was left level or falls towards the rear. The repair involves removing enough tile to expose the substrate, correcting the fall, reinstating the compatible membrane detail, and repeating the required test before retiling.

Delamination at the back wall can follow inadequate substrate preparation, movement, or a niche lining installed flush against the opposite wall lining where separation was required. The affected lining and membrane may need removal rather than a surface patch.

Perimeter silicone failure allows water behind the finished edge, especially where the joint is contaminated, too thin, or applied to a moving connection without proper preparation. Silicone is a maintenance joint, not a replacement for membrane coverage.

Capillary tracking at mixer penetrations often starts where the pipe collar or seal was omitted. Water follows the small gap around the penetration and travels behind the tile. The correct remedy depends on the extent of damage, but it can require opening the wall around the fitting and reinstating the penetration detail.

Repair or rebuild

Local tile and membrane removal makes sense when the defect is isolated and the surrounding system is documented and sound. A full wet-zone rebuild is often the safer decision where multiple junctions are missing, the floor membrane doesn't connect to the waste, or the substrate has moved. Any repair should include a new inspection and, where required, a repeat flood test.

Maintenance still matters after handover:

  • Inspect while cleaning: Look for cracked grout, open silicone, staining, and persistent moisture.
  • Maintain flexible joints: Replace failed silicone before water reaches the substrate.
  • Avoid excessive shelf loading: Heavy rigid objects can stress a small shelf and its tile edges.
  • Keep the recess clear: Remove residue so water can run out rather than sit in corners.
  • Report changes early: A stain outside the shower is a reason to investigate, not a mark to paint over.

Melbourne Tiling Services P/L provides bathroom renovations, shower niche waterproofing, screeding, drainage detailing, tiling, frameless shower screens, and leak rectification across Melbourne and greater Victoria, coordinating registered builders and relevant trades for the wet-area scope. For a niche renovation or an existing leak, visit Melbourne Tiling Services P/L to arrange a project discussion and request a quote before the tiles conceal the detail.

Leaky Shower Valve Repair: A Melbourne Homeowner’s Guide

A dripping shower handle is one of those problems Melbourne homeowners tend to ignore for too long. It starts as a faint tick, a wet stain on the vanity, or a shower floor that never quite dries out, then turns into a bathroom that smells musty and costs more to live with every month.

In older inner-suburb homes and renovated apartments across Melbourne, that drip is rarely just an annoyance. It can point to a worn cartridge, a tired washer, a showerhead issue, or something more serious behind the tiles. If the leak is allowed to keep going, the repair often gets bigger, because hidden moisture can move into wall cavities, finishes, and framing. That's why leaky shower valve repair is really about diagnosis first, not just parts replacement.

Table of Contents

That Dripping Shower Handle Is Telling You Something

A Bayside ensuite that never quite shuts off tells a familiar story. The tenants move out, the owner notices a slow drip from the spout, and suddenly the vanity edge has a water mark that wasn't there before. The handle feels a bit loose, the shower head hisses after use, and the bathroom has started asking for attention.

That symptom matters because shower efficiency and leak awareness aren't cosmetic issues in Australia. The Australian Government's WELS scheme has applied nationally since 1 July 2006, and it rates showerheads by star efficiency to reduce household water use. In practical terms, even a small drip matters in a country where household leaks can waste large volumes of water, and the U.S. EPA's WaterSense data shows a single showerhead leaking at 10 drips per minute wastes more than 500 gallons per year. Household leaks can waste more than 10,000 gallons annually as well, so the logic for fixing a shower leak is tied to water loss, bills, and moisture damage, not just comfort EPA WaterSense leak guidance.

A drip that seems minor at first can stay hidden for months, then show up as staining, swelling, or mould in the wrong place.

The visible leak isn't always the real fault

A handle leak often gets blamed on the valve because that's the part you can see and touch. Sometimes that's right. A worn cartridge or washer is common, and in many bathrooms the fix is straightforward if the rest of the installation is sound.

But Melbourne renovations tell a second story. Older bathrooms, especially ones updated before modern membrane standards, can leak because water is travelling behind the wall lining and out through the valve opening. When that happens, the drip is just the symptom, not the diagnosis. A sensible repair starts by asking whether the valve is failing, or whether the wall system around it has already failed.

Is It Really the Valve? Quick Checks Before You Touch Anything

Before you pull the handle apart, run a few checks that separate a simple valve fault from a showerhead or concealed-wall problem. The point is to avoid opening up a working valve and chasing the wrong part. A ten-minute diagnosis can save an unnecessary tile repair later.

A safety infographic showing six numbered steps to check before working on industrial valves and equipment.

Start with the drip pattern

Watch what happens when the handle is fully off. If the drip slows down after the shower is left alone, that often points to an internal seal, cartridge, or washer issue. If it keeps going steadily, especially after a while, the problem may be pressure-related or coming from somewhere else in the assembly.

Next, isolate hot and cold if the setup allows it. Some valves behave differently depending on which side is under pressure, and that clue helps narrow the fault before anything is dismantled. If there are supply-stop valves behind the trim, they can help localise the issue without shutting off the whole property.

Check the showerhead and the wall around it

A showerhead can mimic a valve leak, especially if mineral buildup or a loose threaded connection is involved. Feel the shower arm joint, check the head, and look for water tracking along the fitting rather than from the valve body. A wrap of fresh PTFE thread tape or a tightened head may solve a joint leak, but don't assume that's the whole story if water is showing up elsewhere.

Then look outside the shower. Bubbling paint, swollen skirting, staining on adjacent walls, or a musty smell in the next room are red flags. Those signs usually mean the problem has moved beyond a trim-level repair and may involve a concealed wall failure. For homeowners wanting a local diagnostic starting point, this Melbourne shower leak detection resource is worth keeping handy.

Tools, Parts and Safe Isolation in a Melbourne Bathroom

A proper repair starts with the right tools on the bench, not half-way through the job. For most valve repairs, the practical kit is simple, but every item earns its place. You'll want an adjustable spanner, Phillips and flathead drivers, an allen key set, needle-nose pliers, plumber's grease, thread tape, a torch, and a phone or camera so you can photograph the assembly before you pull it apart.

The parts side matters just as much. Don't guess the cartridge by shape alone. Match it by brand and model where possible, especially in older Melbourne bathrooms where imported mixers and long-discontinued Australian valves still show up in renos and strata stock.

Isolate the water properly

Find the main bathroom stop tap first, then test it before touching the valve. Open the shower handle after shutting the supply to confirm pressure is off, because a trapped line can still surprise you. If mini isolation valves are hidden behind the trim plate, use them only if you can identify them clearly and they move freely.

If you can't confirm isolation, stop there. A dribbling valve is annoying, but a live line behind a wall opening turns a simple repair into a much bigger one.

Once the supply is off, photograph the trim, retaining clip, and cartridge orientation before removal. That single habit prevents a lot of reassembly mistakes. If you're dealing with a bathroom that's tied into a wider renovation, this Melbourne shower repair guide is a useful companion for the practical side of the work.

Replacing the Cartridge or Washer Step by Step

A good cartridge swap feels calm, not rushed. The handle comes off first, then the cap and trim plate, and only then do you get access to the valve body. The retaining clip is usually the part that turns a simple job into a frustrating one, so pull it carefully and keep it somewhere visible.

A step-by-step infographic showing how to replace a leaky faucet cartridge or washer in eight simple steps.

Remove straight, then match the part exactly

Pull the cartridge or stem straight out without twisting it if you can avoid it. If it's seized, that's where a stuck puller or a little patience comes in, especially in 1990s bathrooms where old cartridges can bind in place. Gentle heat can help, but forcing it usually damages the body or seats.

The replacement needs to go back with the orientation lugs matched to the valve body. Hot and cold sides matter, and so does the cartridge's seating depth. If you reuse a tired seal or clip it back in crooked, the shower can still drip after reassembly, which is why cartridge orientation and retaining-clip seating are the most common failure points in repair work.

Reassemble, grease, and test twice

Before reassembly, lightly grease the o-rings and any contact surfaces that need it. Then work in reverse order, trim plate first, handle last, and don't over-tighten cosmetic fittings. Once everything is back together, test under live flow, then shut it off and test again after residual pressure returns.

The real finish line isn't “it looked fine when I turned it on.” It's “it stayed dry after the line settled back down.”

That post-test check matters because some leaks only show once pressure returns to the line. If the valve still drips, the issue may be the seat, the cartridge, or the hot/cold side rather than the part you just changed. At that point, another round of guesswork usually costs more than getting the right diagnosis.

Repair Versus Full Replacement in Older Melbourne Homes

Older Melbourne homes often hide the decision in the wall. A cartridge or washer replacement is the right answer when the valve body is sound, the part is still available, and the seal surfaces haven't been chewed up by years of use. Full replacement makes more sense when the body is corroded, the threads are stripped, the valve has been over-tightened too many times, or the part is no longer easy to source.

The cost picture makes that choice worth thinking about early. National reference ranges commonly place shower valve repairs around $150 to $350 and full valve replacement around $225 to $575 Modernize cost reference. In Melbourne, that gap matters more in older housing stock, where labour, access, and part compatibility can shift a simple repair into a more involved rectification.

A practical comparison

Factor Cartridge or Washer Repair Full Valve Replacement
Typical fit Good when the body is sound and the part is available Better when the valve is corroded, stuck, or obsolete
Access impact Usually limited to the trim and internal parts Often more disruptive, especially in older walls
Risk level Lower if the right part is matched and seated correctly Lower long term if the existing valve is worn out
Best use case Early leak, clean body, known brand Repeated leaks, corrosion, failed parts supply
Renovation value Keeps costs down for a straightforward fix Makes sense during a planned bathroom upgrade

When replacement is the smarter call

If you're already planning bathroom renovations, replacement can be the cleaner path. That's especially true where the existing valve is incompatible with modern parts or where a newer pressure-balanced or thermostatic unit would improve reliability. WELS-rated fixture choices also make sense when a bathroom is being refreshed, because water efficiency is part of the long-term value equation in Australia.

Melbourne homeowners usually feel the trade-off in the labour bill, not just the parts box. A cheap repair that fails twice isn't cheap at all. A full replacement done at the right time can save a second callout and avoid chasing the same leak through an old valve body.

When the Leak Is Really a Waterproofing and Building Compliance Job

A shower that keeps leaking after a cartridge swap is telling you something different. The water may not be coming from the valve hardware at all. It can be tracking through failed waterproofing, moving through a degraded membrane, or collecting in the substrate and showing up where the trim meets the wall.

That's where the visible clues matter. Efflorescence on grout lines, soft or hollow-sounding tiles, mould at the shower base, or moisture readings on adjoining walls point to a concealed problem rather than a tidy valve fix. If those signs are present, a handle repair won't close the system back up.

A diagram explaining that building leaks are often due to waterproofing and compliance issues, not just repairs.

Why compliance changes the job

Australia's National Construction Code and waterproofing requirements make shower waterproofing mandatory in compliant bathroom construction. That means leak repair can become a building compliance issue as soon as the wall lining, membrane, or tile substrate needs to be opened up. In Victoria, structural changes, plumbing changes, or waterproofing work generally pull the job beyond minor repair territory and into registered-practitioner work.

That's also where the role split matters. A licensed plumber handles the pipework and valve side. A registered waterproofing applicator addresses membrane failure. A Registered Unlimited Builder can coordinate the broader rectification across carpentry, plumbing, waterproofing, and tiling, which is often what a Melbourne bathroom needs once the leak has moved behind the tiles. Melbourne Tiling Services P/L also publishes guidance on waterproofing compliance in Victoria, which is a useful reference point when the repair starts looking like a renovation.

What not to ignore

If the wall feels soft, the skirting has swollen, or the shower base is holding damp longer than it should, the issue has likely moved past the valve. At that stage, the smartest move is to stop treating it like a small plumbing fix. A proper leak rectification may start with a handle, but it can end with a membrane repair, tile replacement, and compliant rebuild.

Your Decision Framework After the Drip Stops

Once the dripping stops, the key question is which path got you there. A clean DIY cartridge swap is the right result when the valve was easy to isolate, the part matched properly, and the shower stayed dry after the pressure test. That outcome usually suits a straightforward, recent installation with no hidden wall damage.

A licensed plumber call-out makes sense when the valve is stubborn, the isolation isn't clear, or the leak doesn't behave like a simple worn seal. That path is also the safer one when you're dealing with an older mixer, unknown parts, or repeat dripping after reassembly. The time signal is usually obvious, because a few minutes of DIY turns into a stalled bathroom and a pile of trim pieces.

The third path is the one Melbourne homeowners often miss. If the leak comes with tile movement, damp walls, or signs of waterproofing failure, the job has crossed into rectification and likely needs a registered builder to coordinate the repair properly. That's the point where bathroom renovations and leak repairs overlap, and it's better to treat the wall system correctly than keep swapping parts that aren't the core issue.

Screenshot from https://melbournetilingservices.com.au

If your shower drip looks like a simple valve fault, Melbourne Tiling Services P/L can help assess whether it's a quick plumbing fix or a wider waterproofing problem. If the leak has started to affect tiles, membranes, or adjoining finishes, visit Melbourne Tiling Services P/L to organise a quote and talk through the repair or renovation scope with a Melbourne specialist.
